DATA FOR GRAPHS:

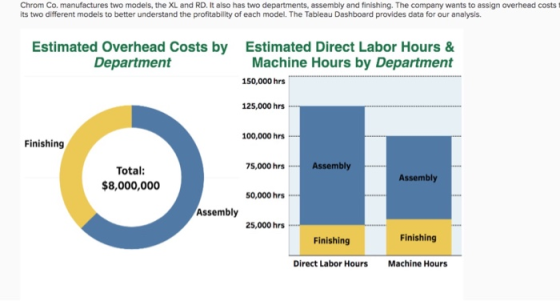

1) Est. Overhead costs by Department
a) Finishing: $3,000,000
b) assembly: $5,000,000
2)Estimated Direct Labor Hours & Machine Hours by Department
a) Direct labor hours: Finishing=25,000 hr , Assembly=100,000 hr
b) Machine hours: finishing =30,000 hr , assembly = 70,000 hr

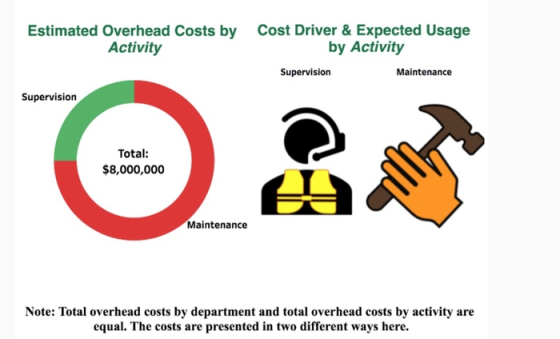

3) Est. Overhead costs by activity
a) supervision : $2,000,000
b) maintenace : $6,000,000
Cost Driver & Exp. Usage by Activity
a) Supervison: 125,000 direct labor hours
b) Maintance: 100,000 machine hours



ANSWER
| Chart Name: | Estimated direct labor hours & machine hours by department | |
| From above the chart following details are identified. | ||
| Direct labor hours for finishing | 25,000 | |
| Machine hours for finishing | 30,000 | |
| Direct labor hours | Machine hours | |
| Total | 125,000 | 100,000 |
| Finishing (less) | 25,000 | 30,000 |
| Assembly | 100,000 | 70,000 |
| Chart Name: | Estimated overhead cost by activity | |
| From above the chart following details are identified. | ||
| Supervision (8000000*1/4) | $ 2,000,000 | |
| Maintenance (8000000*3/4) | $ 6,000,000 | |
| Total overhead | $ 8,000,000 | |
Part: 2A
| Activity | Overhead | Divided by: Activity driver | Activity Rate | |||||
| Maintenance | $ 6,000,000 | 100,000 | MH | $ 60 | per MH | |||
| Supervision | $ 2,000,000 | 125,000 | DLH | $ 16 | per DLH | |||
| XL model | RD model | |||||||
| Activity | Activity Rate | Activity driver incurred | Overhead assigned | Activity driver incurred | Overhead assigned | |||
| Maintenance | $ 60 | per MH | 1 | MH | $ 60 | 3 | MH | $ 180 |
| Supervision | $ 16 | per DLH | 2 | DLH | $ 32 | 3 | DLH | $ 48 |
| Overhead Cost per unit | $ 92 | $ 228 | ||||||
Part: 2B
| Total overhead | $ 8,000,000 | |||
| Divided by: Total Direct labor hours | 125,000 | |||
| Plant-wide OH rate | $ 64 | |||
| Model | Activity Driver | Plant-wide OH rate | OH Cost per unit | |
| XL | $ 64 | DLH | 2 | $ 128 |
| RD | $ 64 | DLH | 3 | $ 192 |
Part: 3
| Model | OH cost per unit using ABC | OH cost per unit using Plant wide OH rate | Which method has lower cost ? |
| XL | $ 92 | $ 128 | ABC |
| RD | $ 228 | $ 192 | Single plant wide OH rate |
| The XL production manager would prefer ABC overhead cost allocation method. | ABC | ||
| The RD production manager would prefer Plant wide OH rate overhead cost allocation method. | Single plant wide OH rate | ||
THANK YOU FOR THE QUESTION....KINDLY RATE....IT HELPS ME A LOT
DATA FOR GRAPHS: 1) Est. Overhead costs by Department a) Finishing: $3,000,000 b) assembly: $5,000,000 2)Estimated...
Tableau DA 4-3: Mini-Case, Computing and assigning costs using ABC LOP3 wants to assign overhead costs to its two different models to better understand the profitability of each model. The Tableau Dashboard provides data for our analysis Estimated Overhead Costs by Estimated Direct Labor Hours & Machine Hours by Department Estimated Overhead Costs by Estimated Direct Labor Hours & Department Machine Hours by Department 150,000 hrs 125,000 hrs 100,000 hrs Finishing o lo 75,000 hrs Assembly Assembly Department Finishing: $3,000,000...
Estimated over cost
department finishing: 3,000,000
assembly: 5,000,000
Direct Labor:
Assembly: 100,000
Finishing: 25,000 hours
Machinery
Assembly: 70,000
Finishing: 30,000 hours
Activity cost pool:
sUPERVISION: 2,000,000
Maintenance: 6,000,000
Activity:
supervision: 125,000 direct hours
Machinery: 100,000 machine hours
Chrom Co. manufactures two models, the XL and RD. It also has two departments, assembly and finishing. The company wants to assign overhead costs to its two different models to better understand the profitability of each model. The Tableau Dashboard provides data for...
Tableau DA 17-1: Quick Study, Computing plantwide overhead rates
LO P1
Chrom Co. manufactures two models, the XL and RD. It also has two departments, assembly and finishing. The company wants to assign overhead costs to its two different models to better understand the profitability of each model. The Tableau Dashboard provides data for our analysis. Estimated Overhead Costs by Department Estimated Direct Labor Hours & Machine Hours by Department 150,000 hrs 125,000 hrs 100,000 hrs Finishing Assembly 75,000 hrs...
Check my wor Chrom Co. manufactures two models, the XL and RD. It also has two departments, assembly and finishing. The company wants to assign overhead costs to its two different models to better understand the profitability of each model. The Tableau Dashboard provides data for our analysis. Estimated Overhead Costs by Department Estimated Direct Labor Hours & Machine Hours by Department 150,000 hrs 125,000 hrs 100,000 hrs Finishing 100 000 75,000 hrs Assembly Ορρρυ Total: $8,000,000 70000 Assembly 50,000...
Tableau DA 17-3: Mini-Case, Computing and assigning costs using
ABC LO P3
Chrom Co. manufactures two models, the XL and RD. It also has two departments, assembly and finishing. The company wants to assign overhead costs to its two different models to better understand the profitability of each model. The Tableau Dashboard provides data for our analysis. Estimated Overhead Costs by Department Estimated Direct Labor Hours & Machine Hours by Department 150,000 hrs 125,000 hrs 100,000 hrs Finishing 75,000 hrs...
Saved Help Save & Exit Su Check my wor Chrom Co. manufactures two models, the XL and RD. It also has two departments, assembly and finishing. The company wants to assign overhead costs to its two different models to better understand the profitability of each model. The Tableau Dashboard provides data for our analysis. Estimated Overhead Costs by Department Estimated Direct Labor Hours & Machine Hours by Department 150,000 hrs 125,000 hrs 100,000 hrs Finishing "V06000 75,000 hrs - Assembly...
Tableau DA 17-2: Exercise, Computing departmental overhead rates
LO P2
Chrom Co. manufactures two models, the XL and RD. It also has two departments, assembly and finishing. The company wants to assign overhead costs to its two different models to better understand the profitability of each model. The Tableau Dashboard provides data for our analysis. Estimated Overhead Costs by Department Estimated Direct Labor Hours & Machine Hours by Department 150,000 hrs 125,000 hrs 100,000 hrs Finishing 75,000 hrs Assembly Total:...
Chrom Co. manufactures two models, the XL and RD. It also has two departments, assembly and finishing. The company wants to assign overhead costs to its two different models to better understand the profitability of each model. The Tableau Dashboard provides data for our analysis. DATA FOR GRAPHS: 1) Est. Overhead costs by Department a) Finishing: $3,000,000 b) assembly: $5,000,000 2)Estimated Direct Labor Hours & Machine Hours by Department a) Direct labor hours: Finishing=25,000 hr , Assembly=100,000 hr b) Machine...
Check my work Required information Tableau DA 4-3: Mini-Case, Computing and assigning costs using ABC LO P3 Chrom Co. manufactures two models, the XL and RD. It also has two departments, assembly and finishing. The company wants to assign overhead costs to its two different models to better understand the profitability of each model. The Tableau Dashboard provides data for our analysis. Part 1 of 2 0.85 points Estimated Overhead Costs by Department Estimated Direct Labor Hours & Machine Hours...
Question 2.
Question 3.
Laval produces lamps and home lighting fixtures. Its most popular product is a brushed aluminum desk lamp. This lamp is made from components shaped in the fabricating department and assembled in the assembly department Information related to the 26.000 desk lamps produced annually follows 5.200,000 Direct labor Fabricating department (0.000 DLH Assembly department (15,600 DLH 520 per DUH) 527 per OLH) 16.00 5421,200 Fabricating department Assembly department Expected overhead cost and related data for the two...
