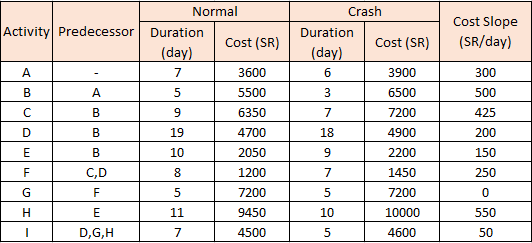

So set up the table with Duration and Crash Durations and calculate the Cost Slope
Cost Slope = (Crash Cost - Normal Cost)/(Normal Duration - Crash Duration)
So we get Cost Slope for Activity C = 425, Cost Slope for Activity G = 0

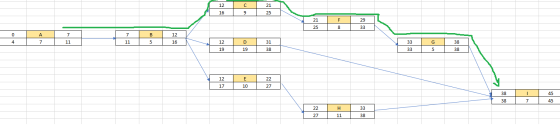

Set up the precedence network. For each activity set up a box like and get the precdence network

Early Start for Acitivity A = 0, Early finish for Activity A = 0 + duration = 0+7 =7
so that way we get EF for Activity I = 45. Assume this to be the LF for Activity I
ES for Activity I = maximum of EF of D,G,H

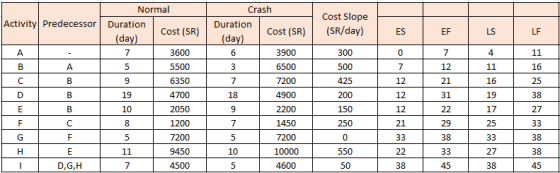

So now we know the ES, EF, LS, LF of all activities, so we have

so Critical path = A-B-C-F-G-I as shown below

Critical path = A-B-C-F-G-I
Time to complete project if you go in critical path = Sum of durations of A-B-C-F-G-I= 7+5+10+11+5+7 = 41
Normal project completion time = 41 days, Total direct normal cost = 44550
Indirect cost = 200/day. So multipy indirect cost by duration = 200*45 = 9000
So total cost = 44550+9000= 53550 - this is the total cost for normal completion time

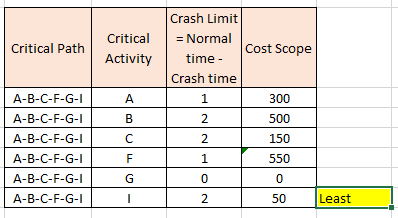

For crashing the project, we need to find the crash limit and slope for the critical path
So we find out the crash limit and slope for activities in the critical path. These are

b) So Activity I has the least slope i.e 50
So in CYCLE 1, Crash Activity by 1 day, this wil cost 50. So the project can be shortened by 1 day i.e total duration of project reduces to 40

c) So for cycle 1 we have to re-calculate critical path, we have this as follows
So now new critical path is still the same
Critical path = A-B-C-F-G-I
Time to complete project if you go in critical path = Sum of durations of A-B-C-F-G-I= 7+5+10+11+5+6 = 40days
First iteration total cost = 53550
So add 50 to this and subtract 200/day (i.e indirect cost)
So total cost after cycle 1 = 53550+50-200 = 53550-150 = 53400

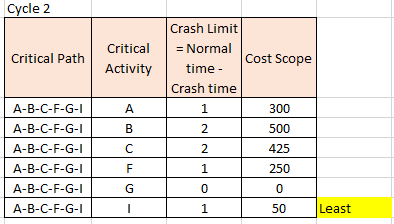

c) So now cyle 2, Total cost = 53400
So we find out the crash limit and slope for activities in the critical path. These are

c) so in cycle 2 - again Activity I can be shortened by 1 day. So project duration reduces from 40 days to 39 days
Previous iteration Total cost = 53400
So add 50 to this and subtract 200/day (i.e indirect cost)
So total cost after Cycle 2 = 53400+50-200 = 53250
So now our new critical path will stil be same
d) Cycle 3 we want to reduce project duration to 37 days. Sofirst reduce from 39 to 38 as follows

So now you cant crash activity I, so you have to crash the next activity with least slope i.e Activity F
so reduce activity F by 1 day total duration is now 38days
Previous iteration Total cost = 53400
So add 250 to this and subtract 200/day (i.e indirect cost)
So total cost after Cycle 3 = 53400+250-200 = 53450
Now we still need to reduce by one more week, so look at critical path now when Activity F has reduced by 1 day
Critical path is still same so we have

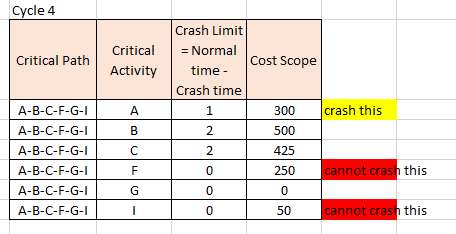

so we havef for Cycle 4 - now we reduce from 38 days to 37 days

so now you cannot crash activity F or Activity I, so you have to crash the next least slope, so crash Activity A by 1 day
so project duration is shortened from 38 days to 37 days.
Previous iteration Total cost = 53400
So add 300 to this and subtract 200/day (i.e indirect cost)
So total cost after Cycle 3 = 53400+300-200 = 53500
