Solution 1:
| Computation of % of completion, revenue recognition and Gross Profit - Arrow Construction Company | |||||||||
| Year | Actual cost incurred (A) | Total cost incurred till date (B) | Total estimated Cost ( C ) | % of completion (D) (B/C) |
Contract Price (E) |
Total Revenue to be recoganized (F) (E * D) | Revenue for current period (G) | Gross Profit (H) | |
| 2018 | $2,200,000 | $2,200,000 | $6,400,000 | 34.38% | $8,600,000 | $2,956,250 | $2,956,250 | $756,250 | $2,956,250 - $2,200,000 |
| 2019 | $2,700,000 | $4,900,000 | $8,800,000 | 55.68% | $8,600,000 | $4,788,636 | $1,832,386 | -$956,250 | $8,600,000 - $8,800,000 - $756,250 |
| 2020 | $4,000,000 | $8,900,000 | $8,900,000 | 100.00% | $8,600,000 | $8,600,000 | $3,811,364 | -$100,000 | $8,600,000 - $8,900,000 - $756,250 + $956,250 |
Solution 2a:
| Journal Entries - Arrow Construction Company - 2018 | |||
| Event | Particulars | Debit | Credit |
| 1 | Construction in Progress Dr | $2,200,000.00 | |
| To Various Accounts | $2,200,000.00 | ||
| (To record construction cost incurred) | |||
| 2 | Accounts receivables Dr | $2,700,000.00 | |
| To Billings on construction contract | $2,700,000.00 | ||
| (To record progress billings) | |||
| 3 | Cash Dr | $2,450,000.00 | |
| To Accounts receivables | $2,450,000.00 | ||
| (To record collection from customer) | |||
| 4 | Construction in Progress Dr | $756,250.00 | |
| Cost of construction Dr | $2,200,000.00 | ||
| To Revenue from long term contracts | $2,956,250.00 | ||
| (To record revenue and gross profit) | |||
Solution 2b:
| Journal Entries - Arrow Construction Company - 2019 | |||
| Event | Particulars | Debit | Credit |
| 1 | Construction in Progress Dr | $2,700,000.00 | |
| To Various Accounts | $2,700,000.00 | ||
| (To record construction cost incurred) | |||
| 2 | Accounts receivables Dr | $2,950,000.00 | |
| To Billings on construction contract | $2,950,000.00 | ||
| (To record progress billings) | |||
| 3 | Cash Dr | $2,675,000.00 | |
| To Accounts receivables | $2,675,000.00 | ||
| (To record collection from customer) | |||
| 4 | Cost of construction Dr | $2,788,636.00 | |
| To Construction in Progress | $956,250.00 | ||
| To Revenue from long term contracts | $1,832,386.00 | ||
| (To record revenue and gross profit) | |||
solution 3a & 3b:
| Arrow construction company | ||
| Balance Sheet (Partial) | ||
| As on December 31 | ||
| Particulars | 2018 | 2019 |
| Assets: | ||
| Current Assets: | ||
| Accounts
Receivables 2018 - $2,700,000 - $2,450,000 2019 - $250,000 + $2,950,000 - $2,675,000 |
$250,000.00 | $525,000.00 |
| Cost and
Profit in excess of billing 2018 - $2,956,250 - $2,700,000 |
$256,250.00 | |
| Liabilities and stockholder's equity: | ||
| Current liabilities: | ||
| Billings
in excess of costs and profits ($2,950,000 - $2,700,000 + $956,250 - $256,250) |
$950,000.00 | |

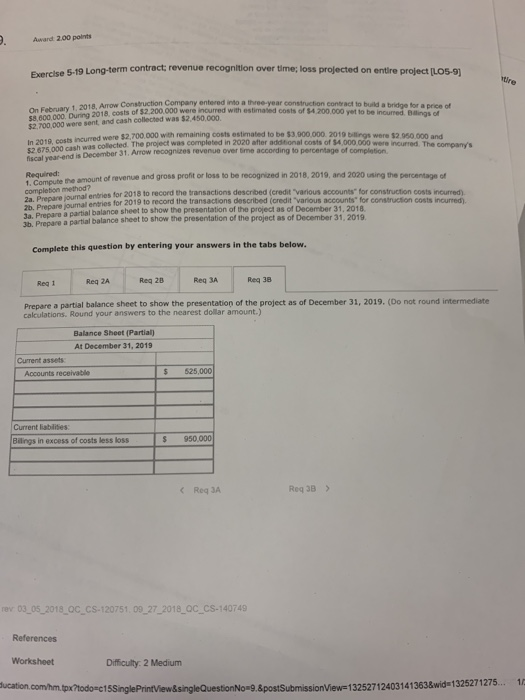

Award 2.00 points Exercise 5-19 Long-term 6.19 Long-term contract, revenue recognition over time, loss projected on...
