Solution:-
1. Prepare a schedule of cost of goods manufactures for 20X1:-
| Canseco Company | ||
| Schedule Cost of Goods Manufactured | ||
| Year Ended December 31, 20X1 (in thousands) | ||
| Direct materials: | ||
| Beginning inventory, Jan. 1, 20X1 | 22,000 | |
| Purchase cost of direct materials | 75,000 | |
| Cost of direct materials available for use | 97,000 | |
| Ending inventory, Dec. 31, 20X1 | 26,000 | |
| Direct materials used | 71,000 | |
| Direct manufacturing labor | 25,000 | |
| Indirect manufacturing costs: | ||
| Indirect manufacturing labor | 15,000 | |
| Plant insurance | 9,000 | |
| Depreciation - plant, building, and equipment | 11,000 | |
| Repairs and maintenance - plant | 4,000 | |
| Total indirect manufacturing costs | 39,000 | |
| Manufacturing costs incurred during 20X1 | 135,000 | |
| Beginning work-in-process inventory, Jan 1, 20X1 | 21,000 | |
| Total manufacturing costs to account for | 156,000 | |
| Ending work-in-process inventory, Dec. 31, 20X1 | 20,000 | |
| Cost of goods manufactured | 136,000 | |
2. Revenues in 20X1 were P300 million. Prepare the 20X1 income statement:-
| Canseco Company | ||
| Income statement | ||
| Year Ended December 31, 20X1 (in thousands) | ||
| Revenues | 300,000 | |
| Cost of goods sold: | ||
| Beginning finished goods, Jan. 1, 20X1 | 18,000 | |
| Cost of goods manufactured | 136,000 | |
| Cost of goods available for sale | 154,000 | |
| Ending finished goods, Dec. 31 20X1 | 23,000 | |
| Cost of goods sold | 131,000 | |
| Gross margin | 169,000 | |
| Operating costs: | ||
| Marketing, distribution, and customer-service costs | 93,000 | |
| General and administrative costs | 29,000 | |
| Total operating costs | 122,000 | |
| Operating income/(loss) | 47,000 | |

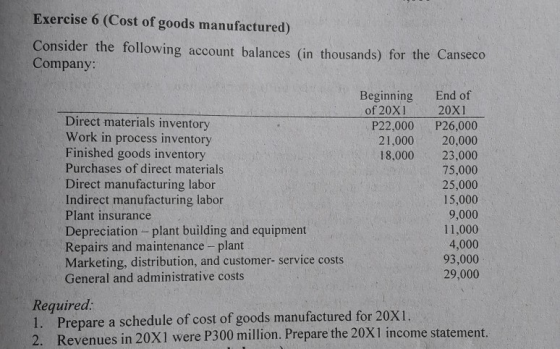

Exercise 6 (Cost of goods manufactured) Consider the following account balances (in thousands) for the Canseco...
