Question

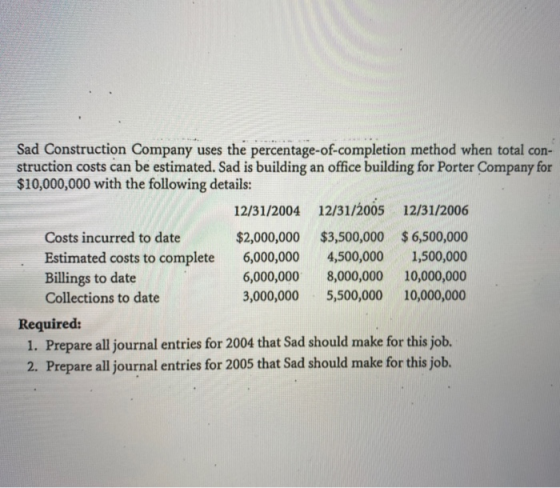

Sad Construction Company uses the percentage-of-completion method when total con- struction costs can be estimated. Sad is bu
0 0
Add a comment Improve this question Transcribed image text
Answer #1

Hi, Friend...

Hope you are also doing well.

I have tried to give the best possible answer. If you have any doubts, please do mention in the comment section. I'll definitely respond in early possible time.

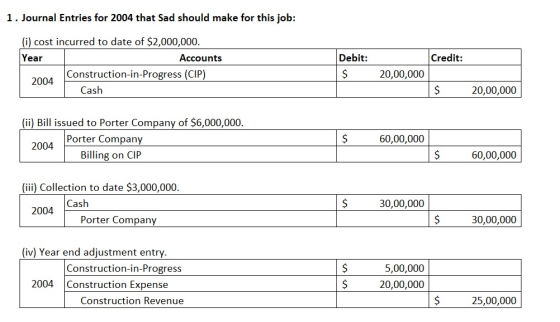

1. Journal Entries for 2004 that Sad should make for this job: Credit: (i) cost incurred to date of $2,000,000. Year Accounts2. Journal Entries for 2005 that Sad should make for this job: Credit: (i) cost incurred to date of $1,500,000. Year AccountsWorkings: 2005 (i) Cumulative cost incurred: ü) Cost incurred in the year: ((CIP and Construction Expense) (iii) EstimateThanks, Dear... Have a Wonderful Day.

Add a comment
Know the answer?
Add Answer to:
Sad Construction Company uses the percentage-of-completion method when total con- struction costs can be estimated. Sad...
Your Answer:

Post as a guest

Your Name:

What's your source?

Earn Coins

Coins can be redeemed for fabulous gifts.

Not the answer you're looking for? Ask your own homework help question. Our experts will answer your question WITHIN MINUTES for Free.
Similar Homework Help Questions
  • 1) Wind and Water Energy Company hired Smith Construction Corporation to build a new building for...

    1) Wind and Water Energy Company hired Smith Construction Corporation to build a new building for its operation. Smith agreed to build the plant for $1,200,000, and Wind and Water Energy agreed to pay Smith $300,000 on January 1 and July 1 for two years, beginning July, 2006. Smith estimates that it will incur total costs of $950,000 to complete construction. The following details at December 31, 2006: Costs incurred to date $400,000   Estimated costs to complete     550,000 Billings...

  • Answer all three of the following problems: Wind and Water Energy Company hired Smith Construction Corporation...

    Answer all three of the following problems: Wind and Water Energy Company hired Smith Construction Corporation to build a new building for its operations. Smith agreed to build the plant for $1,200,000, and Wind and Water Energy agreed to pay Smith $300,000 on January 1 and July 1 for two years, begin ning July 1, 2006. Smith estimates that it will incur total costs of $950,000 to complete con struction. The following details exist at December 31, 2006 Costs incurred...

  • Percentage of Completion and Completed Contact Supplement 01- Overall Profit Year 6,000,000 Costs to Date Estimated...

    Percentage of Completion and Completed Contact Supplement 01- Overall Profit Year 6,000,000 Costs to Date Estimated Costs Remaining Total Estimated Costs Year 1 1,650,000 3,850,000 5,500,000 Year 2 4,130,000 1,770,000 5,900,000 6,000,000 6,600,000 6,600,000 6,600,000 Sales Price (Total Revenue) Billings to Date Collections to Date 1,320,000 1,210,000 3,300,000 3,135,000 6,600,000 6,325,000 Percentage of Completion: Completed Contract Revenue and Income Entries:

  • Fender period. Construction Company receives a contract to construct a building over a 3 year Information...

    Fender period. Construction Company receives a contract to construct a building over a 3 year Information relating to the performance of the contract is summarized as follows: 2015 2016 2017 S 16,000,000 Cumulative construction costs incurred to date Estimated costs to complete Billings during the year Cash collected during the year 6,000,000 8,000,000 6,000,000 3,000,000 8,000,000 7,000,000 4,000,000 5,000,000 Required: 1. How much is Fender Construction charging to build this athletic stadium? In other words, what is the contract price...

  • Percentage complete, Cost Basis. I need help figuring out the percentages to date and percentages yearly....

    Percentage complete, Cost Basis. I need help figuring out the percentages to date and percentages yearly. I initially did 44% but since it says round to two decimal places I changed it to 44.44 and got different numbers. Please help! ($ millions) $ 25.00 Expected Revenue (contract amount in millions of dollars) $ millions) Project Started 20X1 20X2 18.00 $ 20.00 $ 8.00 $ 9.50 $ 9.00 $ 10.00 $ 8.50 $ 9.50 $ Estimated Total Cost (per Engineering) Actual...

  • Exercise 18-36 Coronado Construction Company uses the percentage-of-completion method of accounting. In 2017, Coronado began work...

    Exercise 18-36 Coronado Construction Company uses the percentage-of-completion method of accounting. In 2017, Coronado began work under contract #E2-D2, which provided for a contract price of $2,234,000. Other details follow: 2017 2018 Costs incurred during the year $615,980 $1,420,000 Estimated costs to complete, as of December 31 1,005,020 -0- Billings to date 413,000 2,234,000 Collections during the year 351,000 1,530,000 What portion of the total contract price would be recognized as revenue in 2017? In 2018? Revenue recognized in 2017...

  • Exercise 18-36 Marin Construction Company uses the percentage of completion method of accounting in 2017, Marin...

    Exercise 18-36 Marin Construction Company uses the percentage of completion method of accounting in 2017, Marin began work under contract E2-02, which provided for a contract price of 52,195,000. Other details follow 2017 2018 Costs incurred during the year 5695,310 $1,404,000 Estimated costs to complete, as of December 31921,690 0 Billings to date 426,000 2,195,000 Collections during the year 352,000 1,475,000 What portion of the total contract price would be recognized as revenue in 2017? In 2018? Revenue recognized in...

  • Riverbed Construction Company uses the percentage-of-completion method of accounting. In 2017, Riverbed began work under contract...

    Riverbed Construction Company uses the percentage-of-completion method of accounting. In 2017, Riverbed began work under contract #E2-D2, which provided for a contract price of $2,195,000. Other details follow: 2017 2018 Costs incurred during the year $695,310 $1,404,000 Estimated costs to complete, as of December 31 921,690 –0– Billings to date 426,000 2,195,000 Collections during the year 352,000 1,475,000 What portion of the total contract price would be recognized as revenue in 2017? In 2018? Revenue recognized in 2017 $ Revenue...

  • On February 1, 2021, Arrow Construction Company entered into a three-year construction contract to build a bridge for a price of $8,350,000. During 2021, costs of $2,140,000 were incurred, with estimated costs of $4,140,000 yet to be incurred. Billings of

    On February 1, 2021, Arrow Construction Company entered into a three-year construction contract to build a bridge for a price of $8,350,000. During 2021, costs of $2,140,000 were incurred, with estimated costs of $4,140,000 yet to be incurred. Billings of $2,668,000 were sent, and cash collected was $2,390,000. In 2022, costs incurred were $2,668,000 with remaining costs estimated to be $3,810,000. 2022 billings were $2,918,000, and $2,615,000 cash was collected. The project was completed in 2023 after additional costs of...

  • Question 10 Blossom Construction Company uses the percentage-of-completion method. During 2018, the company entered into a...

    Question 10 Blossom Construction Company uses the percentage-of-completion method. During 2018, the company entered into a fixed-price contract to construct a building for Sherman Company for $22870000. The following details pertain to the contract: At December 31, 2018 At December 31, 2019 Percentage of completion 20% 55% Estimated total cost of $14065000 $17130000 contract Gross profit recognized to 2120000 3470000 date The amount of construction costs incurred during 2019 was O $6685000. O $3065000. $9421500. O $6608500.

ADVERTISEMENT
Free Homework Help App
Download From Google Play
Scan Your Homework
to Get Instant Free Answers
Need Online Homework Help?
Ask a Question
Get Answers For Free
Most questions answered within 3 hours.
ADVERTISEMENT
ADVERTISEMENT
