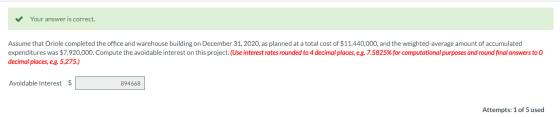

| Calculation of depreciation expenses | |||||
| cost incurred | 11440000 | ||||
| add: avoidable interest | 894668 | ||||
| Total cost | 12334668 | ||||
| Salvage value = 660000 | |||||
| Depreciation expenses = total cost-salvage value/useful life | |||||
| Depreciation expenses = 12334668-660000/30 years | |||||
| depreciation expenses = 176687 | |||||
