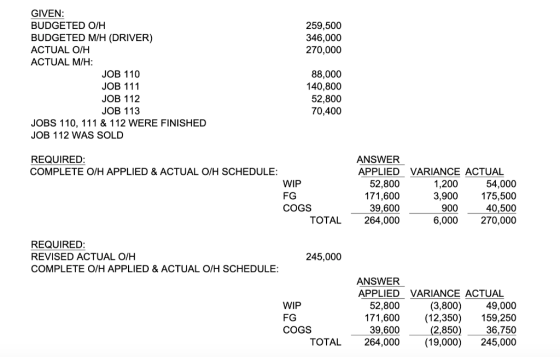

can you explain the second set
of required problems (REVISED ACTUAL O/H)?
| a. | |||
| Budgeted overhead rate: | |||
| Budgeted overhead rate/pre-determine overhead rate=budgeted overhead rate/budgeted machine hour | |||
| = $259500/346000 hours | |||
| = $0.75 per machinr hour | |||
| b. | |||
| Actual overhead rate: | |||
| Actual overhead rate=actual overhead /actual machine hours | |||
| =$270000/(88000+140800+52800+70400) hours | |||
| = $270000/352000hours | |||
| = $0.767 per machine hour | |||
| c. | |||
| In this question said job 110,111,112 were finished goods | |||
| Job 112 was sold | |||
| So , job 112 was in WIP condition | |||
| d. | |||
| Revised actual overhead rate: | |||
| Revised actual overhead rate=revised actual overhead /actual machine hours | |||
| 1 | |||
| Computation of overhead applied and actual overhead schedule | |||
| APPLIED | VARIANCE | ACTUAL | |
| WIP (job 113) | 52800 | 1200 | 54000 |
| (70400*0.075) | (70400*0.76704) | ||
| FG(job110+111) | 171600 | 3900 | 175500 |
| (140800+88000*0.75) | (140800+88000*0.76704) | ||
| COGS (job112) | 39600 | 900 | 40500 |
| (52800*0.75) | (52800*0.76704) | ||
| TOTAL | 264000 | 6000 | 270000 |
| Computation of overhead applied and actual overhead schedule | |||
| APPLIED | VARIANCE | ACTUAL | |
| WIP (job 113) | 52800 | -3800 | 49000 |
| (70400*0.075) | (70400*0.69602)) | ||
| FG(job110+111) | 171600 | -12350 | 159250 |
| (140800+88000*0.75) | (140800+88000*0.69602) | ||
| COGS (job112) | 39600 | -2850 | 36750 |
| (52800*0.75) | (52800*0.69602) | ||
| TOTAL | 264000 | -19000 | 245000 |
