| 1&2 | |||
| Direct Materials | |||
| Job | May | June | Total |
| 102 | $12,000 |
$20,000 [$32,000 - $12,000] |
$32,000 |
| 103 |
$49,000 [Job 103 is started in June] |
$49,000 | |
| 104 |
$47,000 [Job 104 is started in June] |
$47,000 | |
| Total | $12,000 | $116,000 | $128,000 |
| Direct Labor | |||
| Job | May | June | Total |
| 102 | $4,000 |
$14,000 [$18,000 - $4,000] |
$18,000 |
| 103 |
$28,700 [Job 103 is started in June] |
$28,700 | |
| 104 |
$41,000 [Job 104 is started in June] |
$41,000 | |
| Total | $4,000 | $83,700 | $87,700 |
.
.
| 3 | ||||
| Overhead rate | ||||
| Choose Numerator | / | Choose denominator | = | Overhead rate |
| Job 102 | ||||
| Estimated overhead costs | / | Estimated labor cost | Overhead rate | |
| $8,460 | / | $18,000 | 47.00% | |
| Job 103 | ||||
| Estimated overhead costs | / | Estimated labor cost | Overhead rate | |
| $13,489 | / | $28,700 | 47.00% | |
| Job 104 | ||||
| Estimated overhead costs | / | Estimated labor cost | Overhead rate | |
| $19,270 | / | $41,000 | 47.00% | |
.
.
| 4 | |||||
| Job | Direct Materials | Direct Labor | Applied Overhead | Total Cost | Costs Transferred to Finished Goods |
| 102 | $32,000 | $18,000 | $8,460 |
$58,460 [$32,000 + $18,000 + $8,460] |
$58,460 |
| 103 | $49,000 | $28,700 | $13,489 |
$91,189 [$49,000 + $28,700 + $13,489] |
$91,189 |
| 104 | $47,000 | $41,000 | $19,270 |
$107,270 [$47,000 + $41,000 + $19,270] |
|
| Total | $128,000 | $87,700 | $41,219 | $256,919 | $149,649 |
| Note - Job 102 & Job 103 are completed in June. So, the entire cost incurred for Job 102 & Job 103 is transferred to finished goods inventory. | |||||

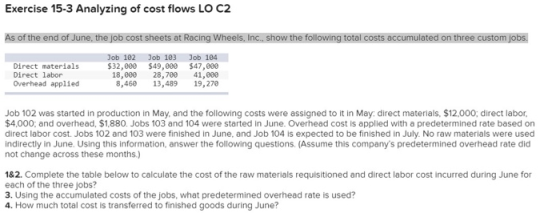

Exercise 15-3 Analyzing of cost flows LO C2 As of the end of June, the job...
