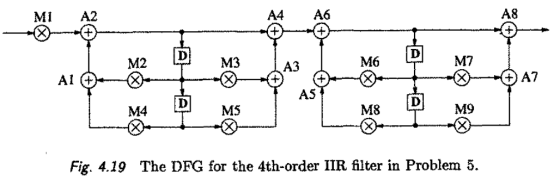

5. The DFG shown in Fig. 4.19 describes a 4th-order IIR digital filter implemented as cascade...

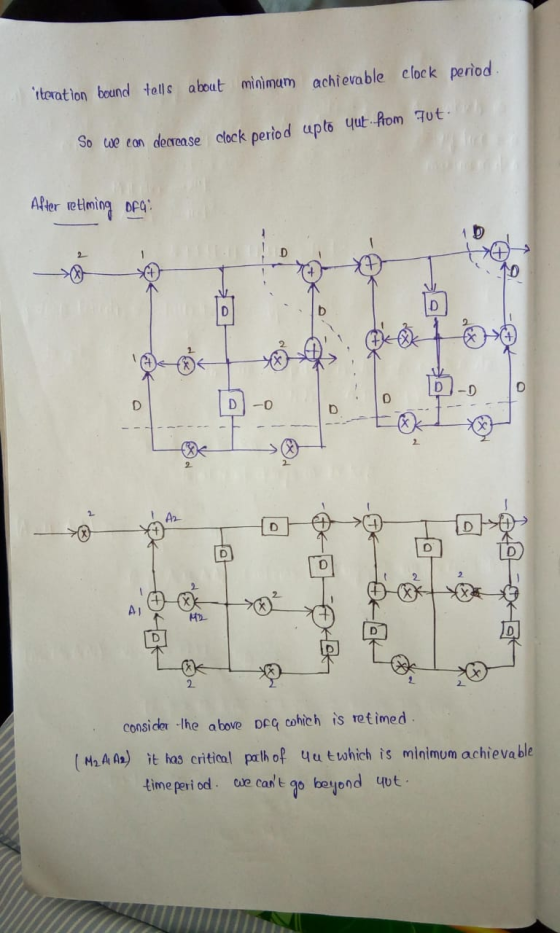

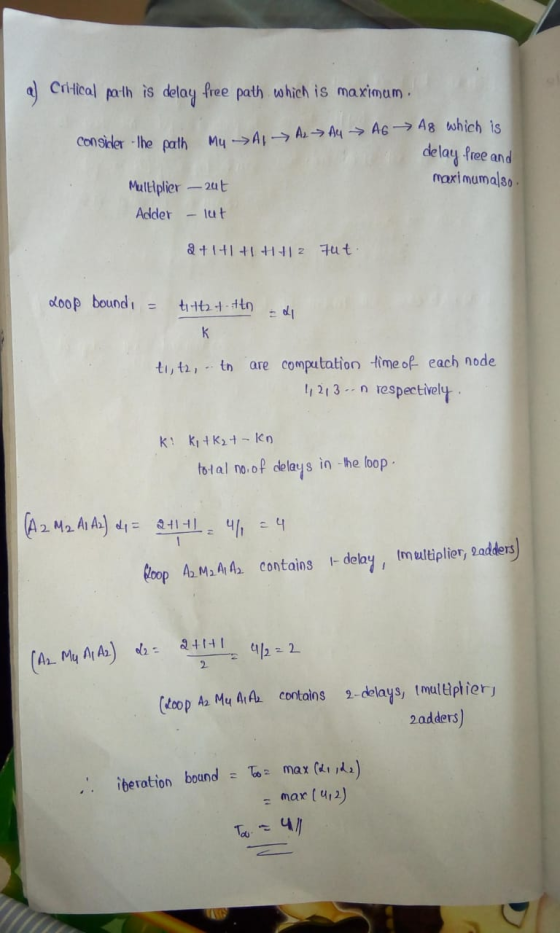

5. The DFG shown in Fig. 4.19 describes a 4th-order IIR digital filter implemented as cascade of 2 2nd-order sections. Assume each multiply requires 2 u.t. and add requires 1 u.t. (a) What is the critical path of this DFG? What is the iteration bound of this DFG? (b) Manually retime and pipeline the DFG to minimize the clock pe riod. What is the minimum achievable clock period obtained with pipelining and retiming?
