Question
please show me all the work i want to see it step by step please thank you

REVIEW QUESTIONS AND EXERCISES 9.1 (a) Using PERT, calculate expected project duration and determine the critical path in the
0 0
Add a comment Improve this question Transcribed image text
Answer #1

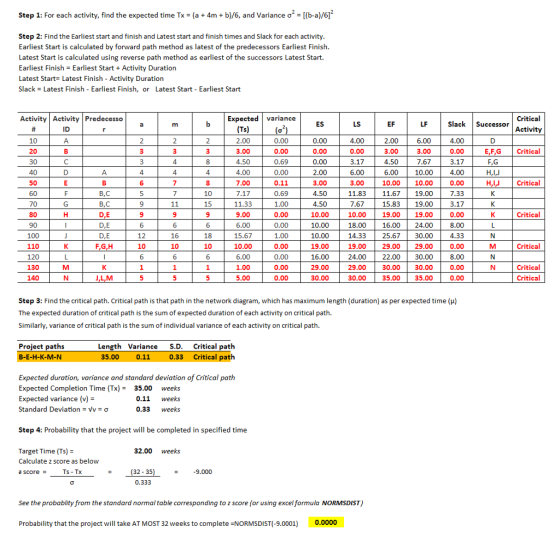

Step 1: For each activity, find the expected time Tx = (a + 4m + b)/6, and Variance oʻ = [(b-a)/6] Step 2: Find the Earliest

Add a comment
Know the answer?
Add Answer to:
please show me all the work i want to see it step by step please thank...
Your Answer:

Post as a guest

Your Name:

What's your source?

Earn Coins

Coins can be redeemed for fabulous gifts.

Not the answer you're looking for? Ask your own homework help question. Our experts will answer your question WITHIN MINUTES for Free.
