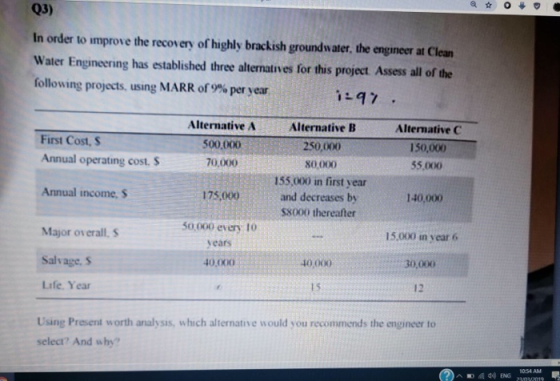

03) In order to improve the recovery of highly brackish groundwater, the engineer at Clean Water...

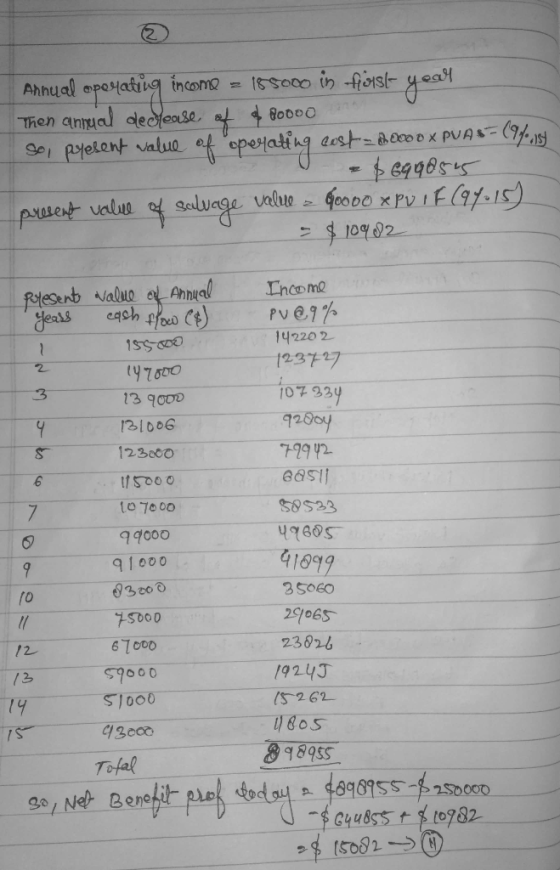

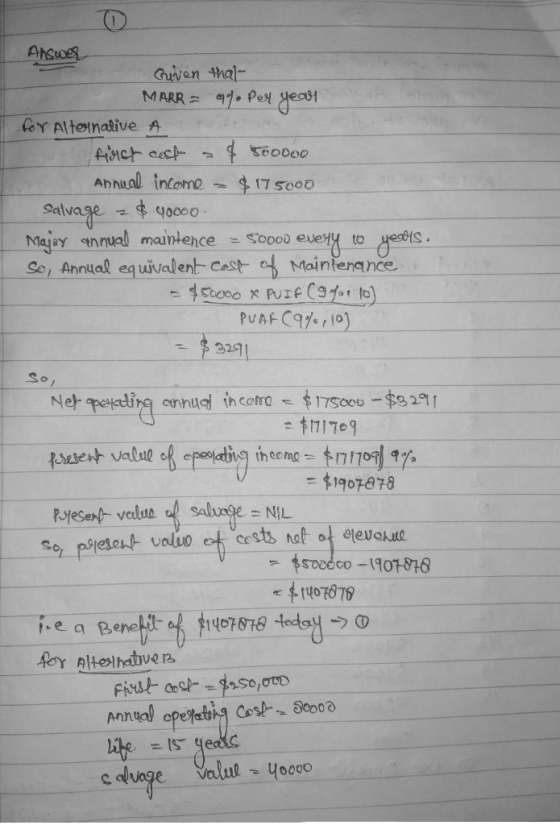

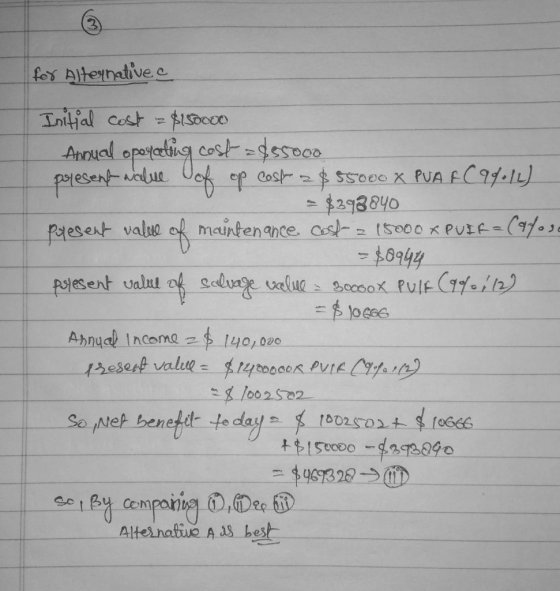

03) In order to improve the recovery of highly brackish groundwater, the engineer at Clean Water Engineering has established three altermatives for this project Assess all of the following projects, using MARR of 9% per year 129冫. Alternative A 500,000 70,000 Alternative B 250,000 80,000 155,000 in first year and decreases by $8000 thereafter First Cost, S Annual operating cost.s Alternative C 150,000 55,000 Annual income, $ 175,000 140,000 50,000 every 10 sears Major overall. S Salvage. S Life. Year...
