Question

8.2 Make a clear and neat sketch of the network specified below using precedence notation. On the precedence diagram cal- cul

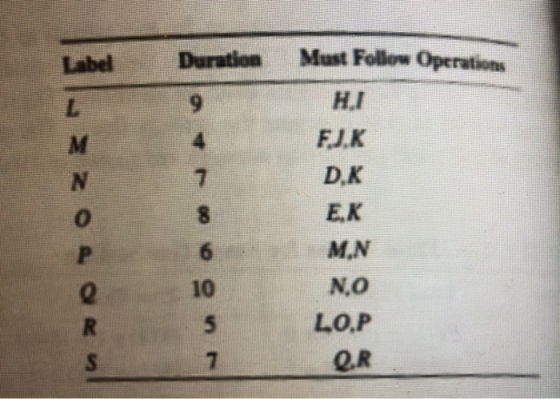

Label Duration ROO Must Follow Operations H.I FJK D.K EK MN N.o LOP QR
8.2: make it clear please
0 0
Add a comment Improve this question Transcribed image text
Answer #1

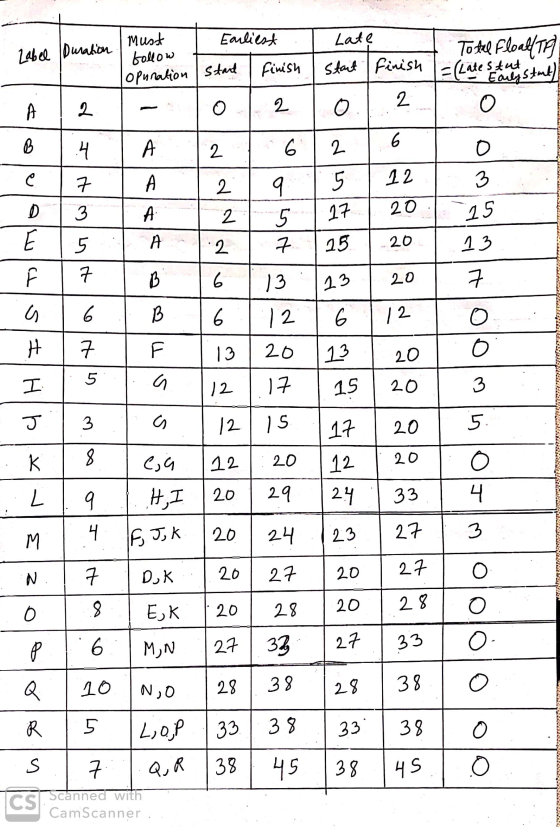

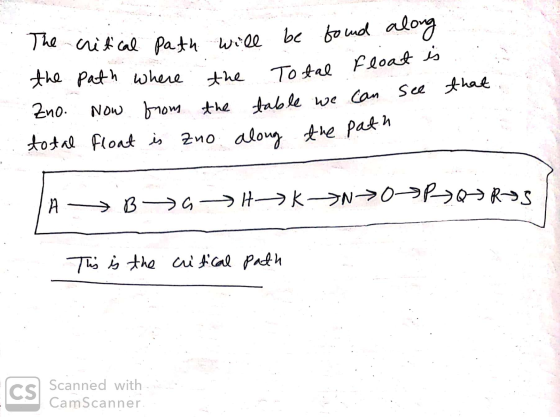

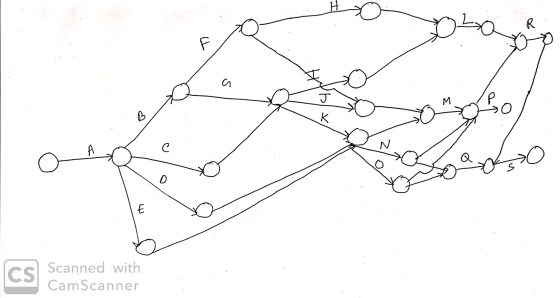

Must bollow opuration colelewals IH Earliest I Late 140 |ракм Total Float(TP) start | Finish Start Finish = (Latestutistul) Atap bago ♡ B A Scanned with CamScannerThe critical path will be found along the path where the Total Flo Eno. Now from the table we can see total float is zno alon
