Question

Prepare a master schedule given this information: It is now the end of week 1; customer orders are 25 for week 2,16 for week 3, 11 for week 4, 8 for week 5, and 3 for week 6. Use the MPS rule of ordering production when projected on-hand inventory would be negative without production. Suppose that there are currently 64 pumps in inventory and a production lot size of 70 pumps is used. (Leave no cells blank-be certain to enter O wherever required.) Jul 6 June 30 25 30 16 Forecast Customer orders (committed) Projected on-hand inventory MPS ATP 30 30 40 40 40 40

Prepare a master schedule given this information: It is now the end of week 1; customer orders are 25 for week 2,16 for week 3, 11 for week 4, 8 for week 5, and 3 for week 6. Use the MPS rule of ordering production when projected on-hand inventory would be negative without production. Suppose that there are currently 64 pumps in inventory and a production lot size of 70 pumps is used. (Leave no cells blank-be certain to enter "O" wherever required.)

0 0
Add a comment Improve this question Transcribed image text
✔ Recommended Answer
Answer #1

Please Note the formulas to be used

MPS will be provided in a lot of 70 when the available or (projected on-hand inventory becomes 0 or negative

(Please note I have used Available in place of Projected -On-Hand Inventory(same))

The available row can be calculated by

Current period available = Previous period available + MPS – (Greater of forecast or orders)

For example in in 3rd period you consider from the solution provided previous period available = 1

MPS = 70 and the maximum between Customer order(16) and forecast(30) is 30 so the Projected on hand is

1+70-Max(30,16) = 41

For ATP Calculation

ATP is available to promise for the customers

Fist period ATP = On-hand + any first-period MPS -\sum (all orders until the next MPS)
Later period ATP = MPS in that period - \sum (all orders in that and subsequent periods until the next MPS)

For example first period ATP = Onhand(64) - No MPS in 1st Period (0)- sum of all orders till 3rd period (33+25) = 6

ATP of 3rd period = MPS in 3rd Period (70)- Sum of all orders till next MPS( 16+11)= 43

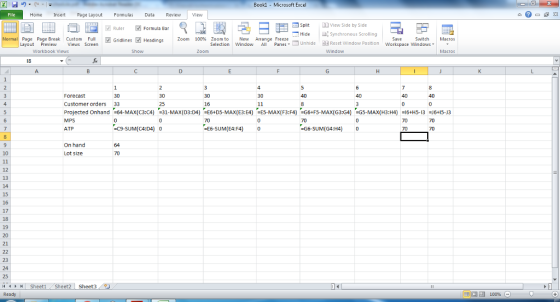

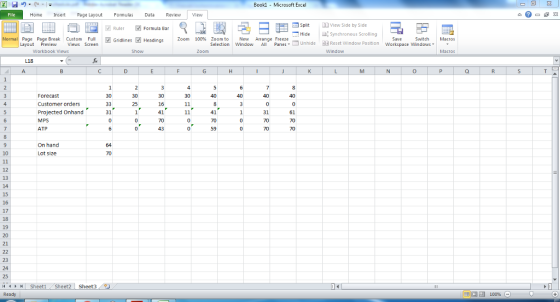

Book1 Microsoft Excel Home InsrtPage Layout Formulas Dat Revie Vew SplitVew Side by Side 团Ruler 図Formula Bar Hide SymchronousBookd Microsoft Excel Home InsrtPage Layout Formulas Data Revie View 園 ヨーコHide Split H View side by Hide Symchronous ScrollinI hope you got a better idea from the explanation

Please comment if any doubt and Rate me
