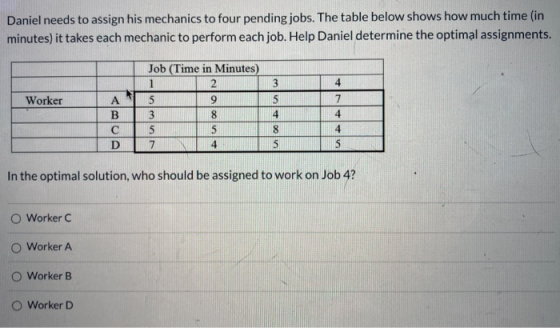

Question

Daniel needs to assign his mechanics to four pending jobs. The table below shows how much time (in minutes) it takes each mec
0 0
Add a comment Improve this question Transcribed image text
Answer #1

Answer: Option 1: Worker C

Explanation:

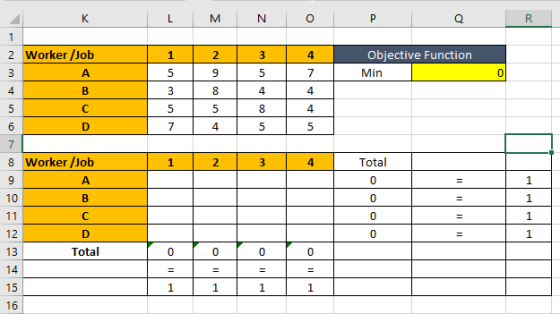

Excel LP formation (Assignment Problem)

K L M N U Р R 1 1 2 3 4 2 Worker /Job 3 A Objective Function Min 5 9 5 7 0 4 B 3 8 4 4 5 с 5 5 8 4 6 D 7 4 5 5 7 8 Worker /Jo

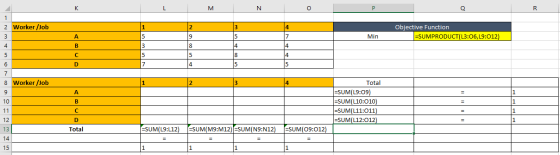

Formula:

K L M N O Q R 1 1 2 3 2 Worker/Job 3 4 7 Objective Function =SUMPRODUCT(L3:06, 19:012) A 5 9 5 Min 4 B 3 8 4 4 5 С 5 8 4 6 D

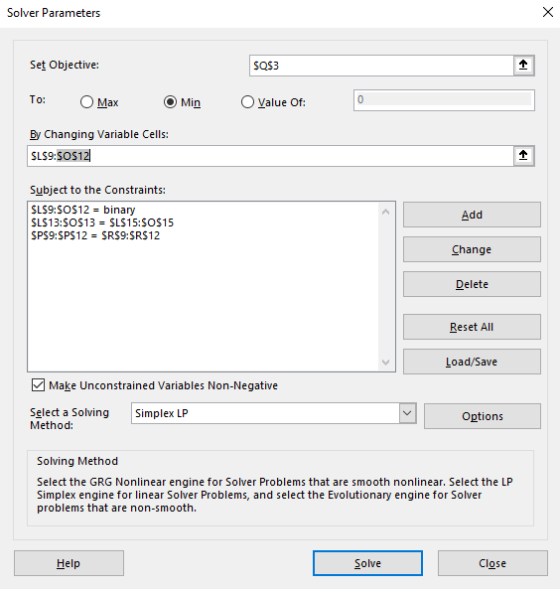

Solver Parameters:

Solver Parameters Set Objective: SOS3 To: o Max Min O Value of: 0 By Changing Variable Cells: SL59:505121 Subject to the Cons

Solution:

K L M N 0 P R 1 3 2 Worker /Job 3 A 4 B 2 9 8 4 7 Objective Function Min 5 5 3 16 4 4 с 5 8 4 5 6 5 7 D 4 Ол 5 7 8 Worker /Jo

Add a comment
