Q1. 58 %
% complete = Actual area of carpet installed / budgeted area
= 1500/2600
= 58 %
-------------------------------
Q2. 3,450
BCWP = Actual area of carpetinstalled * budgeted unit cost
= 1500*2.30
= $ 3,450
-------------------------------
Q3. 3,150
ACWP = Actual cost incurred till date
= $ 3,150
-------------------------------
Q4. 2,392
BCWS = Area of carpet as per schedule * budgeted unit cost
= 2600*4/10 * 2.3
= $ 2,392
-------------------------------
Q5. 300
CV = BCWP - ACWP
= 3450 - 3150
= $ 300
-------------------------------
Q6. 1,058
SV - BCWP - BCWS
= 3450 - 2392
= $ 1,058
-------------------------------

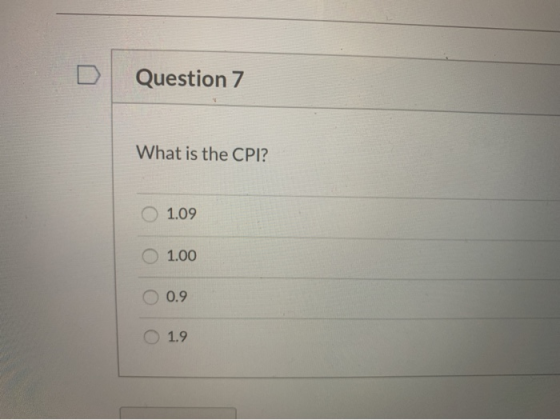

Q7. 1.095
CPI = BCWP / ACWP
= 3450 / 3150
= 1.095
-------------------------------
Q8. 1.44
SPI = BCWP / BCWS
= 3450/ 2392
= 1.44
-------------------------------
Q9. 517
FCV = CV / % complete
= 300/58%
= 517
-------------------------------
Q10. 1,824
FSV = SV / % complete
= 1058/58%
= 1,824
-------------------------------

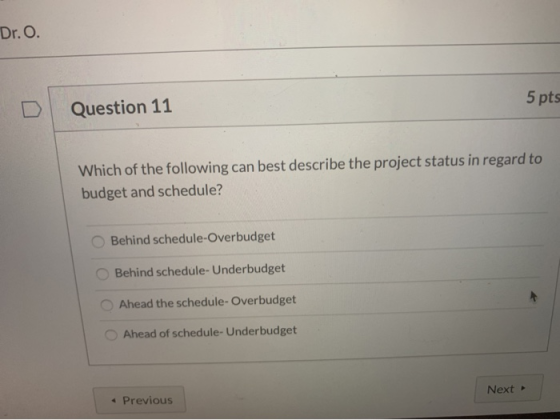

Q11.
CV is positive and CPI is greater than 1, which means that the project is under budget
SV is positive and SPI is greater than 1, which means that the project is ahead of schedule
