The following jobs are waiting to be processed at a small machine center:
| JOB | DUE DATE | DURATION (DAYS) |
| 10 | 240 | 18 |
| 20 | 232 | 14 |
| 30 | 240 | 6 |
| 40 | 245 | 30 |
| 50 | 255 | 26 |
All dates are specified as manufacturing planning calendar days. Assume that all jobs arrived on day 200 (yesterday) in the order shown but are not scheduled to begin until day 201 (today).
a. Sequence the jobs according to LPT
According to the LPT rule, the sequence of jobs should be _______________________
b. What is the average completion (flow) time?
c. What is the average job lateness?
d. What is the average number of jobs in the system?
a.

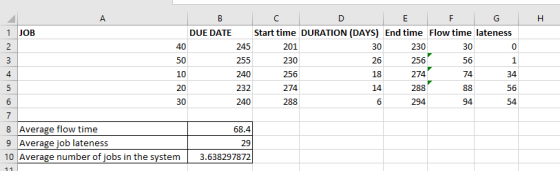

Sequence using LPT rule =>40-50-10-20-30
| Average flow time | 68.4 |
| Average job lateness | 29 |
| Average number of jobs in the system | 3.638297872 |

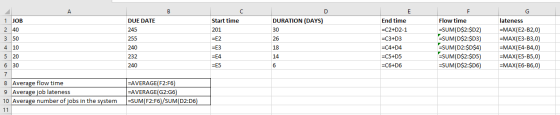

Calculation

Formula

The following jobs are waiting to be processed at a small machine center: JOB DUE DATE...
The following jobs are waiting to be processed at a small machine center: JOB DUE DATE DURATION (DAYS) 10 260 8 20 252 18 30 260 26 40 270 32 50 275 14 All dates are specified as manufacturing planning calendar days. Assume that all jobs arrived on day 200 (yesterday) in the order shown but are not scheduled to begin until day 201 (today). a. Sequence the jobs according to LPT? b. What is the average completion (flow) time?...
SIDDHERTHA CAN YOU SOLVE THIS BY EXPLAINING ALL FORMULAS AND
ANSWERS
obs are waiting to be processed at your work center, which cleans valve body castings Job numbers are All assigned sequentially upon arrival in the facility (a missing number means that job does not require your work center) dates are specified as days from today Due Date Duration 43 10 101 34 37 32 7 12 104 7 107 108 oeos bcesed soseudra to tedhduing rule? a. In what...
15.13 The following jobs are waiting to be processed at Rick Carlson’s machine center. Carlson’s machine center has a relatively long backlog and sets fresh schedulesevery 2 weeks, which do not disturb earlier schedules. Below are the jobs received during the previous 2 weeks. They are ready to be scheduled today, which is day 241(day 241 is a work day). Job names refer to names of clients and contract numbers.Job Date Job Received Production Days Needed Date Job DueBR-02 228...
a) Using the FCFS (first come, first
served ) decision rule for sequencing the jobs, the order is
(assume that jobs came in the order in which they are listed in
the table):
Sequence
Job
1
A
2
B
3
C
4
D
5
E
The average tardiness (job lateness) for the sequence developed
using the FCFS rule = ___ days (round your response to two
decimal places).
The following jobs are waiting to be processed at the same
machine...
a) Using the EDD (earliest due date) decision rule for sequencing the jobs, the order is (to resolve a tie, use the order in which the jobs were received): At Morgan's Transformer Rebuilding, following jobs (below) are ready for dispatching to a work center. The processing times, date job received, and due dates for the jobs are given below. In what sequence would the jobs be ranked according to the decision rules on the left Sequence Job 1 Date Job...
a) Using the EDD (earliest due date) decision rule for sequencing the jobs, the order is (to resolve a tie, use the order in which the jobs were received): At Morgan's Transformer Rebuilding, following jobs (below) are ready for dispatching to a work center. The processing times, date job received, and due dates for the jobs are given below. In what sequence would the jobs be ranked according to the decision rules on the left Sequence Job 1 Date Job...
1. Five jobs are waiting to be processed. Their processing times and due dates are given below. Using the longest processing time dispatching rule, in which order should the jobs be processed? All dates are specified as days from today. Job Processing Time (days) 4 Job due date (days) 7 A B 7 4 11 с 3 D 8 5 E 5 8 A) D, B, E, A, C B) C, A, E, B, D C) B, D, E, A,C...
a) Using the SPT (shortest processing time) decision rule for sequencing the jobs, the order is (to resolve a tie, use the order in which the jobs were received): Sequence Job 1 ▼ N L M K O 2 ▼ K O L M N 3 ▼ K N L O M 4 ▼ N L M O K 5 ▼ N O K M L The total flow time for the sequence developed using the SPT rule = nothing...
a) Using the FCFS (first come, first served) decision e for sequencing the jobs, the order is t Richard's Machine Shop, following jobs (below) are ready for dispatching to a work center. The processing times, date job recuived, and due dales for the jobs a ranked according lo the decision rukes given below whal sequence would the jobs b Sequence Job Date Job Processing (days) Job Received D 105 122 195 20 180 120 205 25 I times d daysloday...
Five jobs are waiting to be processed. Their processing times and due dates are given below. Using the shortest processing time dispatching rule, in which order should the jobs be processed? Processing Time (days) Job due date (days) Job A B 4 C 11 D 8 5 8 O A. D, A, E, B, C О в. D. В. Е. А. С О С. С. А, Е, в.р O D. C, E, A, B, D O E. B, D, A,...
