Question

Given the following Project Activities and Precedence Relations table; determine the Critical Path, and the minimum Project D

0 0
Add a comment Improve this question Transcribed image text
Answer #1

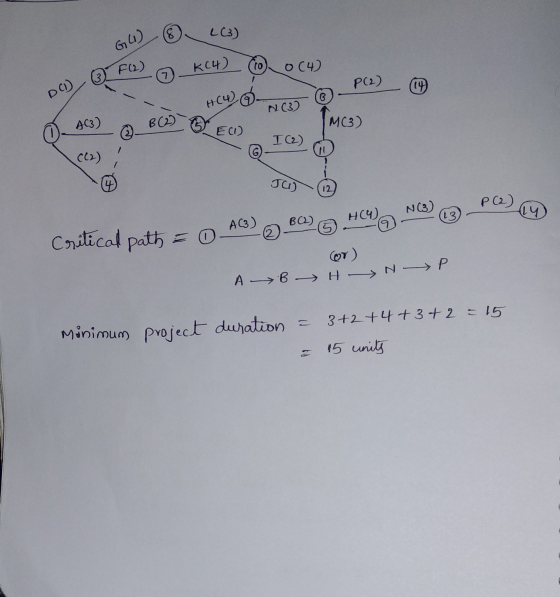

8 LC3) GU) F(2) KC4) (to о (ч) P(2) DO)) B H(4) N03) [MC3) B (2) AC3) © E1) I (2) CL2) JU) N(3) P (2) 13 HC4) BO2) A (3) Crit

Add a comment
Know the answer?
Add Answer to:
Given the following Project Activities and Precedence Relations table; determine the Critical Path, and the minimum...
Your Answer:

Post as a guest

Your Name:

What's your source?

Earn Coins

Coins can be redeemed for fabulous gifts.

Not the answer you're looking for? Ask your own homework help question. Our experts will answer your question WITHIN MINUTES for Free.
Similar Homework Help Questions
  • Given the following Project Activities and Precedence Relations table; determine the Critical Path, and the minimum...

    Given the following Project Activities and Precedence Relations table; determine the Critical Path, and the minimum Project Duration. Create the Gantt Chart for the project represented in the table. Project Activities and Precedence Relations ACTIVITY DURATION PRECEDED BY: A 3 B 2 A C 2 D 1 E 1 B F G 2 1 D D H 4 BD 2 J J 1 4 K F L 3 G M N 3 3 IJ H 0 4 HKL MNO Р...

  • project are listed for a In the following table the activities with their precedence sequence and...

    project are listed for a In the following table the activities with their precedence sequence and expected time (days) Immediate Predecessor(s) Time (days) Activity 7 A 2 A B 4 C 4 5 5 E C F 2 G E, F 3 H G, H a) The activities on the critical path are b) The project length is days.

  • Draw the bar chart, and Precedence Diagram for the given project and highlight the critical path....

    Draw the bar chart, and Precedence Diagram for the given project and highlight the critical path. Determine the project total duration, ES, EF, LS, LF, and TF for each given activity. + Activity Description Duration Predecessor A Move in 2 B Set up Scaffolds 3 A C Tear off Shingles 3 B ID Inspect Roof Truss & Deck 2 C E Remove Old Shingles 3 C IF Purchase New Shingles G G Install New Shingles 15 C,D H 3 G...

  • Activity Duration Precedence Problem# 3 For the project information given below (wecks) information a) Draw the...

    Activity Duration Precedence Problem# 3 For the project information given below (wecks) information a) Draw the network diagram to accurately B must be after C represent the information given C must be after A 10 15 b) Determine the earliest start, earliest D must be after B E must be after C F must be after D and E G must be after F H must be after G 1 must be after F finished, latest start, latest finish for...

  • In the following table the activities with their precedence sequence and expected time (days) are listed...

    In the following table the activities with their precedence sequence and expected time (days) are listed for a project: Activity Immediate Predecessor(s) Time (days) - ITMO OWNono Ana E, F D GH a) The activities on the critical path are b) The project length is days. A-B-E-G-1 A-B-D-H-1 A-C-F-G-

  • ASSIGNMENT- Scheduling a. Draw the EARLY start Gantt chart and state the critical activities b. Draw...

    ASSIGNMENT- Scheduling a. Draw the EARLY start Gantt chart and state the critical activities b. Draw the LATE start Gantt chart c. Draw the AON chart - Forward pass d. Draw the AON chart - Backward pass e. Identify the critical path from the table (follow ppt/notes) MUST BE DONE NEATLY! ACTIVITY WEEKS PRECEDENCE A B с D E F 3 4 5 7 2 4 3 A B B E C,D GF H

  • In the following table the activities with their precedence sequence and expected time​ (days) are listed...

    In the following table the activities with their precedence sequence and expected time​ (days) are listed for a project on which Carl​ Betterton's construction company is​ working:                                                                                        Activity Immediate​ Predecessor(s) Time​ (days) A minus− 5 B A 4 C A 6 D B 6 E B 4 F C 4 G D 6 H ​E, F 7 ​Carl's team should be able to complete the project in nothing days. Critical path activities for​ Carl's project are .

  • In the following table the activities with their precedence sequence and expected time (days) are listed...

    In the following table the activities with their precedence sequence and expected time (days) are listed for a project: Activity Immediate Predecessor(s) Time (days) S A Figure 1 C A 4 5 5 F 5 F G E, F D GH 2 3 H The correct AOA precedence diagram is shown in a Figure 2 Q Figure 3

  • Answer all questions Consider a project consisting of 12 activities and their duration along with...

    please answer this problem Answer all questions Consider a project consisting of 12 activities and their duration along with precedence as follows: Activity Precedence Duration (Days) B,C D,F.H IJ 10 5 marks Questionl Analyze the critical path to determine the total duration for the completion of the project Question2: Compute slack time for each task and analyze the appropriateness of the slack time and its usage in the process [5 marks] [5 marks Question3: Determine appropriate technological solution for the...

  • 5.) Consider a project whose activities are listed in the table below. Activity A will have...

    5.) Consider a project whose activities are listed in the table below. Activity A will have slack time as long as…    Activity Immediate Predecessors A None B None C A D B E C, D F E G E a. Duration of A < Duration of B b. Duration of A + Duration of C > Duration of B + Duration of D c. Duration of A + Duration of C < Duration of B + Duration of D...

ADVERTISEMENT
Free Homework Help App
Download From Google Play
Scan Your Homework
to Get Instant Free Answers
Need Online Homework Help?
Ask a Question
Get Answers For Free
Most questions answered within 3 hours.
ADVERTISEMENT
ADVERTISEMENT
