Question
this queistion but also what is the the total manufacturing cost and how do you calulate that.
thank you.

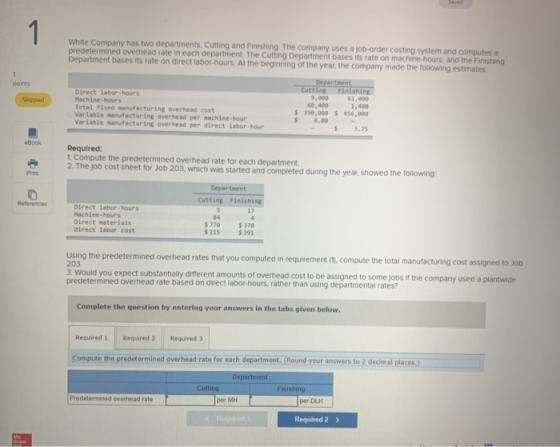

1 White Company has two departments, Cutting and Finishing The company uses a job-order costing system and computes a predete
0 0
Add a comment Improve this question Transcribed image text
Answer #1

Answer to Requirement 1:

Cutting Department:

Estimated manufacturing overhead = Variable manufacturing overhead per machine hour * Estimated machine hours + Fixed manufacturing overhead
Estimated manufacturing overhead = $4.00 * 68,400 + $390,000
Estimated manufacturing overhead = $663,600

Predetermined overhead rate = Estimated manufacturing overhead / Estimated machine hours
Predetermined overhead rate = $663,600 / 68,400
Predetermined overhead rate = $9.70 per machine hour

Finishing Department:

Estimated manufacturing overhead = Variable manufacturing overhead per direct labor hour * Estimated direct labor hours + Fixed manufacturing overhead
Estimated manufacturing overhead = $3.75 * 61,000 + $456,000
Estimated manufacturing overhead = $684,750

Predetermined overhead rate = Estimated manufacturing overhead / Estimated direct labor hours
Predetermined overhead rate = $684,750 / 61,000
Predetermined overhead rate = $11.23 per direct labor hour

Answer to Requirement 2:

Cutting Department:

Manufacturing cost = Direct materials + Direct labor cost + Manufacturing overhead applied
Manufacturing cost = $770.00 + $115.00 + $9.70 * 84
Manufacturing cost = $770.00 + $115.00 + $814.80
Manufacturing cost = $1,699.80

Finishing Department:

Manufacturing cost = Direct materials + Direct labor cost + Manufacturing overhead applied
Manufacturing cost = $370.00 + $391.00 + $11.23 * 17
Manufacturing cost = $370.00 + $391.00 + $190.91
Manufacturing cost = $951.91

Job 203:

Total manufacturing cost = Manufacturing cost of Cutting Department + Manufacturing cost of Finishing Department
Total manufacturing cost = $1,699.80 + $951.91
Total manufacturing cost = $2,651.71

Answer to Requirement 3:

Yes, if the job requires higher amount of machine hours and less amount of direct labor hour, then overhead cost assigned using activity based costing would be higher than using plantwide overhead rate.
