Question

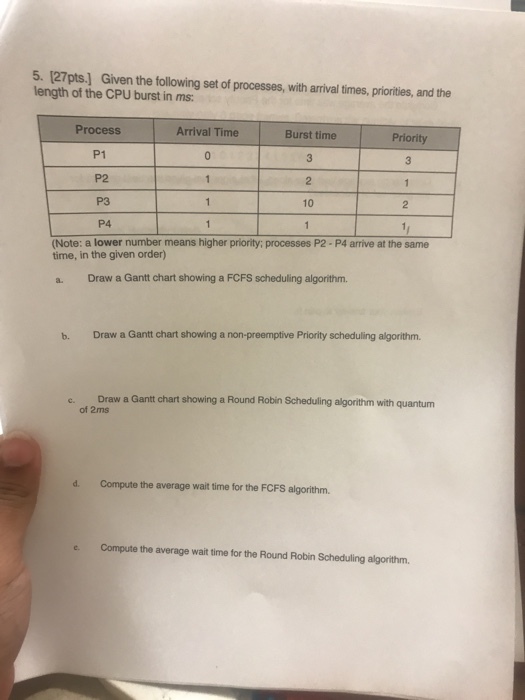

5. [27pts.] Given the following set of processes, with arrival times, priorities, and the length of the CPU burst in ms: Process Arrival Time Burst time Priority P1 P2 P3 2 10 P4 (Note: a lower number means higher priority; processes P2- P4 arrive at the same time, in the given order) a. Draw a Gantt chart showing a FCFS scheduling algorithm. b. Draw a Gantt chart showing a non-preemptive Priority scheduling algorithm. Draw a Gantt chart showing a Round Robin Scheduling algorithm with quantum of 2ms c. d. Compute the average wait time for the FCFS algorithm e Compute the average wait time for the Round Robin Scheduling algorithm
media%2F2a9%2F2a916d38-e599-478a-afe1-50Opearting system
0 0
Add a comment Improve this question Transcribed image text
Answer #1

#include <stdio.h>
#include <stdlib.h>
#include <conio.h>
#define MAX 100
typedef struct
{
    int pid;
    int burst_time;
    int waiting_time;
    int turnaround_time;
} Process;
void print_gantt_chart(Process p[], int n);
int main()
{
    Process p[MAX];
    int i, j, n;
     int sum_turnaround_time;
     clrscr();
    printf("Enter total number of process: ");
    scanf("%d", &n);
    printf("Enter burst time for each process:\n");
    for(i=0; i<n; i++)
    {
p[i].pid = i+1;
printf("P[%d] : ", i+1);
scanf("%d", &p[i].burst_time);
p[i].waiting_time = p[i].turnaround_time = 0;
      }
p[0].turnaround_time = p[0].burst_time;
    for(i=1; i<n; i++)
   {
p[i].waiting_time = p[i-1].waiting_time + p[i-1].burst_time;
p[i].turnaround_time = p[i].waiting_time + p[i].burst_time;
    }
    puts(""); // Empty line
    puts("          GANTT CHART          ");
    puts("          ***********          ");
    print_gantt_chart(p, n);
    getch();
    return 0;
}
void print_gantt_chart(Process p[], int n)
{
    int i, j;
     printf(" ");
    for(i=0; i<n; i++) {
        for(j=0; j<p[i].burst_time; j++) printf("--");
        printf(" ");
    }
    printf("\n|");

    for(i=0; i<n; i++) {
        for(j=0; j<p[i].burst_time - 1; j++) printf(" ");
        printf("P%d", p[i].pid);
        for(j=0; j<p[i].burst_time - 1; j++) printf(" ");
        printf("|");
    }
    printf("\n ");

    for(i=0; i<n; i++) {
        for(j=0; j<p[i].burst_time; j++) printf("--");
        printf(" ");
    }
    printf("\n");

    printf("0");
    for(i=0; i<n; i++) {
        for(j=0; j<p[i].burst_time; j++) printf(" ");
        if(p[i].turnaround_time > 9) printf("\b");
        printf("%d", p[i].turnaround_time);
    }
    printf("\n");}

sjf:
#include <stdio.h>
#include <stdlib.h>
#include <conio.h>
#define MAX_PROCESS 100
struct process {
    int pid;
    int burst_time;
    int waiting_time;
};
typedef struct process Process;
double average_waiting_time;
int total_waiting_time;
void sort_process_by_burst_time(Process p[], int n);
void calculate_waiting_time(Process p[], int n);
void print_gantt_chart(Process p[], int n);
int main()
{
    Process p[MAX_PROCESS];
    int n, i, j;
    clrscr();
    puts("SHORTEST JOB FIRST SCHEDULING ALGORITHM");
    puts("=======================================");
    printf("Enter total process: ");
    scanf("%d", &n);
    printf("Enter burst time for each process:\n");
    for(i=0; i<n; i++) {
printf("P[%d]: ", i+1);
scanf("%d", &p[i].burst_time);
p[i].pid = i+1;
    }
    sort_process_by_burst_time(p, n);
    calculate_waiting_time(p, n);
    average_waiting_time = (double) ( (double)total_waiting_time / (double) n );
    puts("");
    printf("Gantt Chart:\n");
    print_gantt_chart(p, n);
    getch();
    return 0;
}
void sort_process_by_burst_time(Process p[], int n)
{
    int i, j;
    Process temp;
    for(i=0; i<n-1; i++) {
        for(j=0; j<n-1-i; j++) {
            if(p[j].burst_time > p[j+1].burst_time) {
                temp = p[j];
                p[j] = p[j+1];
                p[j+1] = temp;
            }
        }
    }
}
void calculate_waiting_time(Process p[], int n)
{
    int i;
    total_waiting_time = 0;
    p[0].waiting_time = 0;
    for(i=1; i<n; i++) {
        p[i].waiting_time = p[i-1].waiting_time + p[i-1].burst_time;
        total_waiting_time += p[i].waiting_time;
    }
}
void print_gantt_chart(Process p[], int n)
{
    int i, j;
    int last = p[n-1].burst_time + ( n== 1 ? 0 : p[n-1].waiting_time);
    printf(" ");
    for(i=0; i<n; i++) {
        for(j=0; j<p[i].burst_time; j++) printf("--");
        printf(" ");
    }
    printf("\n|");
    for(i=0; i<n; i++) {
        for(j=0; j<p[i].burst_time-1; j++) printf(" ");
        printf("p%d", p[i].pid);
        for(j=0; j<p[i].burst_time-1; j++) printf(" ");
        printf("|");
    }
    printf("\n ");
    for(i=0; i<n; i++) {
        for(j=0; j<p[i].burst_time; j++) printf("--");
        printf(" ");
    }
    printf("\n");
    int minus = 0;
    for(i=0; i<n; i++) {
        if(p[i].waiting_time>9) printf(" ");
        printf("%d", p[i].waiting_time);
        if(p[i+1].waiting_time>9){
          minus = 1;
        }
        if(i+1 == n ) if (last>9) minus = 1;
        for(j=0; j<p[i].burst_time-minus; j++) printf(" ");
    }
    if(last>9) printf(" ");
    printf("%d\n", last);
}

#include<stdio.h>
#include<conio.h>
struct process
{
int at,bt,wt,tat,st,ft,flag,id,tbt;
}p[10],temp;
int n,t,save_et[10],save_id[10],turn,btsum;
float awt,atat;
void read();
void print();
void rndrbn();
void fifoq();
main()
{
int ch;
do
{
printf("\nEnter choice:1.RR 3.exit.ENTER UR CHOICE\n");
scanf("%d",&ch);
switch(ch)
{
case 1:read();
fifoq();
rndrbn();
print();
break;
case 3:
return 0;
default:
printf("invalid choice");
}
}while(1);
}
void read()
{
int i;
printf("Enter no of processes:");
scanf("%d",&n);
for(i=0;i<n;i++)
{
printf("Enter burst time of process p%d : ",(i+1));
scanf("%d%",&p[i].bt);
p[i].id=i+1;
p[i].wt=p[i].flag=0;
p[i].tbt=p[i].bt;
btsum+=p[i].bt;
}
printf("Enter time quantum : ");
scanf("%d",&t);
}
void fifoq()
{
int i,j;
for(i=0;i<n;i++)
{
for(j=0;j<n-i-1;j++)
{
if(p[j].at>p[j+1].at)
{
temp=p[j];
p[j]=p[j+1];
p[j+1]=temp;
}
}
}
}
void rndrbn()
{
//int tmp;
int cnt=n;
int i=0;
int et=0;
int sum=0;
float twt=0;
float ttat=0;
while(cnt!=0)
{
if((p[i].bt)>t)
{
et=t;
p[i].bt-=t;
}
else
{
et=p[i].bt;
p[i].bt=0;
}
p[i].st=sum;
if((p[i].flag)==0)
{
p[i].wt=p[i].st-p[i].at;
p[i].flag++;
}
else
p[i].wt=p[i].wt+(p[i].st-p[i].ft);
sum=sum+et;
p[i].ft=sum;
save_et[turn]=et;
save_id[turn++]=p[i].id;
if((p[i].bt)==0)
{
cnt--;
}
do
{
i=(i+1)%n;
}while((p[i].bt)==0 && cnt!=0);
}
for(i=0;i<n;i++)
{
p[i].tat=p[i].wt+p[i].tbt;
twt+=p[i].wt;
ttat+=p[i].tat;
}
awt=twt/n;
atat=ttat/n;
}
void print()
{
int i;
for(i=0;i<=btsum;i++)
printf("-");
printf("|");
for(i=0;i<turn;i++)
printf("%*d|",-(save_et[i]-1),save_id[i]);
printf("");
for(i=0;i<=btsum;i++)
printf("-");
printf("");
btsum=0;
}
