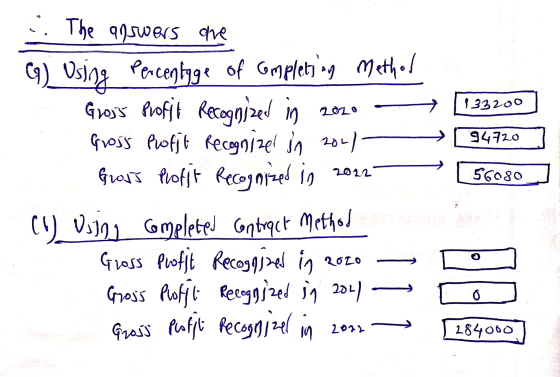

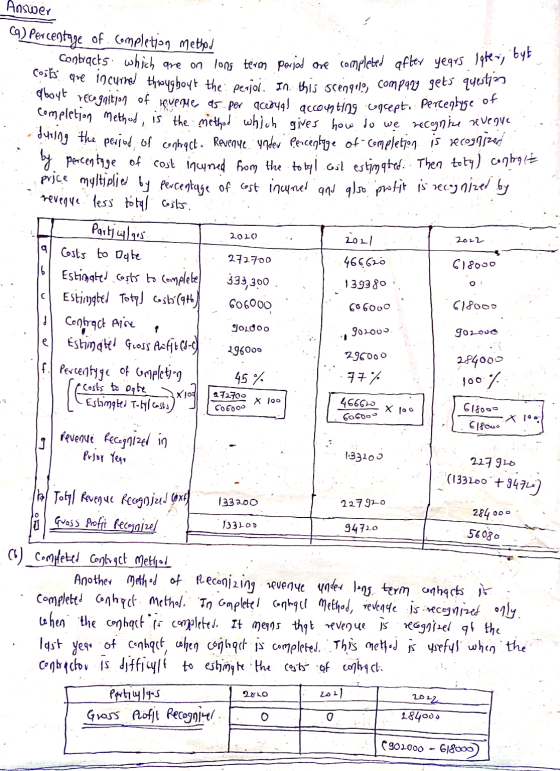

![7 1 33200 94720 ] 5 colo The answers are G) Using Percentage of completing Method Gross Profil Recognized in 2020 - Gross P](http://img.homeworklib.com/questions/791b29c0-a1a5-11eb-ba9d-9f9875cf013a.png?x-oss-process=image/resize,w_560)

Pearl Construction Company has entered into a contract beginning January 1, 2020, to build a parking...
Bramble Construction Company has entered into a contract
beginning January 1, 2020, to build a parking complex. It has been
estimated that the complex will cost $606,000 and will take 3 years
to construct. The complex will be billed to the purchasing company
at $902,000. The following data pertain to the construction period.
2020 2021 2022 Costs to date $272,700 $466,620 $618,000 Estimated
costs to complete 333,300 139,380 –0– Progress billings to date
273,000 546,000 902,000 Cash collected to date...
Bonita Construction Company has entered into a contract beginning January 1, 2020, to build a parking complex. It has been estimated that the complex will cost $596,000 and will take 3 years to construct. The complex will be billed to the purchasing company at $902,000. The following data pertain to the construction period. Costs to date Estimated costs to complete Progress billings to date Cash collected to date 2020 $256,280 339,720 270,000 240,000 2021 $429,120 166,880 555,000 505,000 2022 $606,000...
Grouper Construction Company has entered into a contract beginning January 1, 2020, to build a parking complex. It has been estimated that the complex will cost $606,000 and will take 3 years to construct. The complex will be billed to the purchasing company at $896,000. The following data pertain to the construction period. 2020 2021 Costs to date Estimated costs to complete Progress billings to date Cash collected to date $266,640 339,360 270,000 240,000 $412,080 193,920 545,000 495,000 2022 $617,000...
Problem 18-09
Shamrock Construction Company has entered into a contract
beginning January 1, 2020, to build a parking complex. It has been
estimated that the complex will cost $601,000 and will take 3 years
to construct. The complex will be billed to the purchasing company
at $903,000. The following data pertain to the construction
period.
2020
2021
2022
Costs to date
$270,450
$492,820
$613,000
Estimated costs to complete
330,550
108,180
–0–
Progress billings to date
273,000
550,000
903,000
Cash collected...
Pronghorn Construction Company has entered into a contract
beginning January 1, 2020, to build a parking complex. It has been
estimated that the complex will cost $596,000 and will take 3 years
to construct. The complex will be billed to the purchasing company
at $894,000. The following data pertain to the construction
period.
2020
2021
2022
Costs to date
$274,160
$417,200
$607,000
Estimated costs to complete
321,840
178,800
–0–
Progress billings to date
272,000
550,000
894,000
Cash collected to date...
Ivanhoe Construction Company has entered into a contract beginning January 1, 2020, to build a parking complex. It has been estimated that the complex will cost $599,000 and will take 3 years to construct. The complex will be billed to the purchasing company at $905,000. The following data pertain to the construction period 2020 2021 2022 Costs to date $257,570 $413,310 $609,000 Estimated costs to complete 341,430 185,690 –0– Progress billings to date 270,000 551,000 905,000 Cash collected to date...
Waterway Construction Company has entered into a contract beginning January 1, 2020, to build a parking complex. It has been estimated that the complex will cost $598,000 and will take 3 years to construct. The complex will be billed to the purchasing company at $897,000. The following data pertain to the construction period. 2020 2021 2022 Costs to date $275,080 $412,620 $607,000 Estimated costs to complete 322,920 185,380 –0– Progress billings to date 272,000 545,000 897,000 Cash collected to date...
Whispering Construction Company has entered into a contract
beginning January 1, 2020, to build a parking complex. It has been
estimated that the complex will cost $599,000 and will take 3 years
to construct. The complex will be billed to the purchasing company
at $905,000. The following data pertain to the construction
period.
2020
2021
2022
Costs to date
$257,570
$413,310
$609,000
Estimated costs to complete
341,430
185,690
–0–
Progress billings to date
270,000
551,000
905,000
Cash collected to date...
Ayayai Construction Company has entered into a contract beginning January 1, 2017, to build a parking complex. It has been estimated that the complex will cost $600,000 and will take 3 years to construct. The complex will be billed to the purchasing company at $901,000. The following data pertain to the construction period. Costs to date Estimated costs to complete Progress billings to date Cash collected to date 2017 $246,000 354,000 270,000 240,000 2018 $432,000 168,000 546,000 496,000 2019 $612,000...
Problem 18-09 Sweet Construction Company has entered into a contract beginning January 1, 2020, to build a parking complex. It has been estimated that the complex will cost $605,000 and will take 3 years to construct. The complex will be billed to the purchasing company at $909,000. The following data pertain to the construction period. Costs to date Estimated costs to complete Progress billings to date Cash collected to date 2020 $254,100 350,900 272,000 242,000 2021 $496,100 108,900 550,000 500,000...
