Q1. Complete the following MPS record and find out what is the available-to-promise. There are 10 units beginning inventory and the lot size is 65, Submit your answer in the drop box

Q2. Given the following data, construct a material requirements plan for all components which will result in 200 units of (A) at the beginning of week 6. (Submit your answer in the drop box)

Q1.

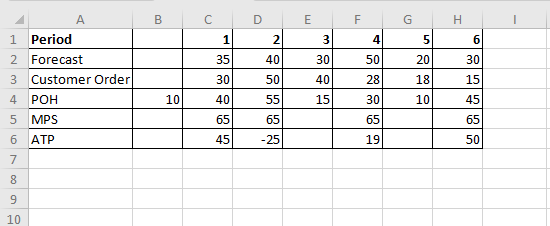

Completed MPS in Excel is following:

EXCEL FORMULAS:
| Period | 1 | 2 | 3 | 4 | 5 | 6 | |
| Forecast | 35 | 40 | 30 | 50 | 20 | 30 | |
| Customer Order | 30 | 50 | 40 | 28 | 18 | 15 | |
| POH | 10 | =B4-MAX(C2:C3)+C5 | =C4-MAX(D2:D3)+D5 | =D4-MAX(E2:E3)+E5 | =E4-MAX(F2:F3)+F5 | =F4-MAX(G2:G3)+G5 | =G4-MAX(H2:H3)+H5 |
| MPS | 65 | 65 | 65 | 65 | |||
| ATP | =B4+C5-C3 | =D5-SUM(D3:E3) | =F5-SUM(F3:G3) | =H5-H3 |
| Formulas explained: |
| POH = Previous period POH - MAX(Forecast, Customer Order) |
| ATP for period 1 = POH + MPS in period 1 - Cumulative Customer Orders before the next MPS receipt |
| ATP for subsequent periods = MPS of current period - Cumulative Customer Orders before the next MPS receipt |

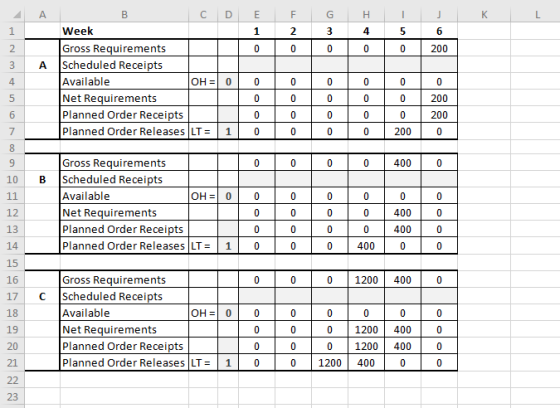

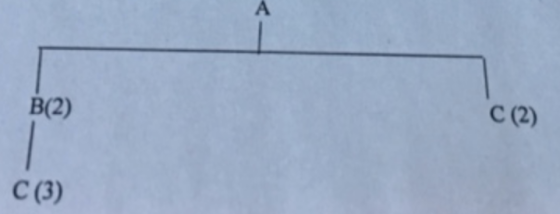

Q2.

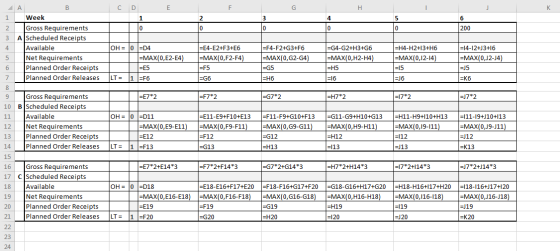

Gross requirement of item A is given. Lead time of none of the items are specified. Considering lead time of 1 week for all the items, MRP is following:

EXCEL FORMULAS:

Complete the following MPS record and find out what is the available-to-promise
Assignment 8 is due on Sunday 8/2 at 11:00 AM Complete the following MPS record and find out what is the available-to-promise. There are 20 units in beginning inventory and the lot size is 50. Answer in Excel and submit your answer in the drop box. Period 1 2 3 4 5 6 Forecast 20 22 23 20 25 20 Customers order (committed) 21 20 21 23 208 POH (Projected on hand) MPS (Master production schedule) ATP (Available-to-promise)
Given the following data, construct a material requirements plan for all components which will result in 200 units of (P) at the beginning of week 6. (Use Excel and submit your answer in the drop box). P A B (3) B (2) Item Currently On- Hand Order Quantity Scheduled Receipt (wk) Lead time 1 0 70 50 A B 30 (wk3) L4L Lot size 100 Lot size 100 3
Question #3 Georgia Clay and Gravel was updating the MPS record for one of its products, Smell Fresh Cat Litter. Complete the following MPS time-phased record. Smell Fresh On Hand Week 1 2 3 4 5 6 7 8 Forecast 20 20 20 30 30 30 30 30 Orders 5 3 2 Projected available balance 20 50 30 10 30 50 20 40 10 Available to promise MPS 50 50 50 50 MPS Lot Size = 50 The following events...
please show excel formula/file
thank you
Given the following data, construct a material requirements plan for all components which will result in 200 units of (P) at the beginning of week 6. P A B (3) B (2) Item Currently On- Hand Scheduled Receipt (wk) Lead time Order Quantity P A B 70 50 30 (wk3) 1 L4L Lot size 100 Lot size 100 3
Using the following MPS record, what is the MPS start for week
7?
MPS Lot Size Lead Time 10 1 3 4 5 6 7 8 9 45 25 20 20 20 20 40 20 T PERIOD Quantity on Hand Forecast Customer Orders Booked 1 Projected On Hand Inventory MPS Quantity MPS Start ATP 25 20 25 5 25 8_ 30
Q1. Develop a Master Production Schedule (MPS) The Forecast is 84 units for first period and 80 for the second period, and 60 units for each of the next three periods. The starting Inventory is 20 units. The company uses lot size of 50 units. Committed Orders are as follows: What is the available to promise? Period Customer Orders 1 82 2 82 3 58 4 40 5 20 Q2 Complete the following problem. There are 20 on hand and...
1. Using the information in the following table, prepare a prospective MPS and calculate the available-to- promise (ATP) quantities on the table below. The order policy is to produce in lots your calculations on the paper to receive full or partial credits. of 100. Show all Week 4 7 50 20 8 50 10 2 5 6 Quantity on hand: 401 404040 50 95 Forecast Customer orders (booked) Projected on-hand Inventory MPS quantity Available-to-promise (ATP) 20 40 45 15 75...
The bill of materials and the data from the inventory records for product A are shown in the figure to the right. Assume that the MPS start quantities for A are 100 units in weeks 1, 2, and 7. Derive an MRP plan for the components going into product A using the data in the table below Item Data Category L4L 2 weeks 100 (week 2) 350 L4L 1 week None 215 Lot-sizing rule Lead time Scheduled receipts Beginning inventory...
i Data Table Table 2. INVENTORY RECORD DATA F G C Data Category Lot-sizing rule Lead time Safety stock Scheduled receipts Beginning inventory L4L 3 weeks 0 150 (week 2) 125 D FOQ = 800 3 weeks 0 300 (week 2) 0 Item E FOQ = 600 4 weeks 0 600 (week 1) 255 L4L 2 weeks 70 None 670 L4L 1 week 0 1,200 (week 1) 0 Print Done Done nd then click Check Answer. Clear All The BOM...
Prepare a master production schedule for industrial pumps in the manner of the following ta Use the MPS rule to "schedule production when the projected on-hand inventory would be le than 10 without production". Suppose that there are currently 64 pumps in inventory and a production lot size of 70 pumps is used. 30 33 Week Forecast Customer orders (committed) Projected on- hand inventory MPS 0 Available to promise (ATP) 70 51 Question 29 (3 points) What is the projected...
