On July 1, 2017, Torvill Construction Company Inc. contracted to
build an office building for Gumbel Corp. for a total contract
price of $ 1,900,000. On July 1, Torvill estimated that it would
take between 2 and 3 years to complete the building. On December
31, 2019, the building was deemed substantially completed.
Following are accumulated contract costs incurred, estimated costs
to complete the contract, and accumulated billings to Gumbel for
2017, 2018, and 2019.
|

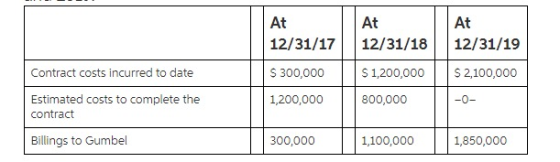

At |
At |
At |
||||
| Contract costs incurred to date | $ 300,000 | $ 1,200,000 | $ 2,100,000 | |||
| Estimated costs to complete the contract | 1,200,000 | 800,000 | –0– | |||
| Billings to Gumbel | 300,000 | 1,100,000 | 1,850,000 |

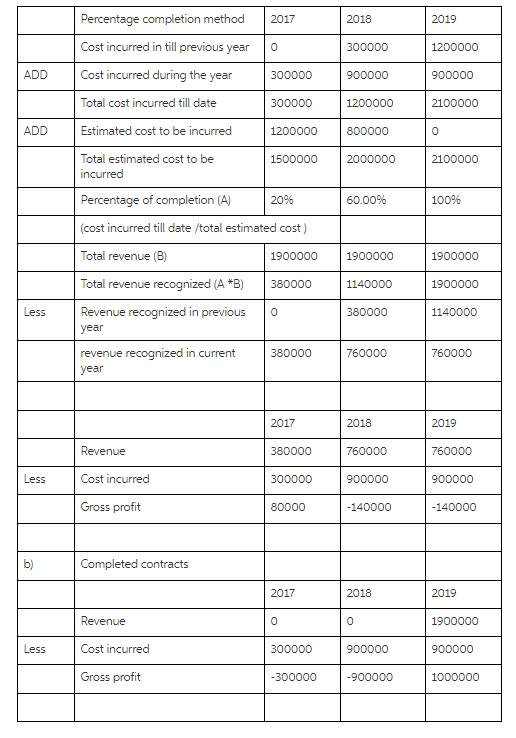

(a) Using the percentage-of-completion method,
prepare schedules to compute the profit or loss to be recognized as
a result of this contract for the years ended December 31, 2017,
2018, and 2019. (Ignore income taxes.) (If answer is 0,
please enter 0. Do not leave any field blank. Enter negative
amounts using either a negative sign preceding the number e.g. -45
or parentheses e.g. (45).)
|
2017 |
|||
|
$ |
|||
|
$ |
|||
| % | |||
|
$ |
|||
|
$ |
|
2018 |
||
|
$ |
||
|
$ |
||
|
$ |
||
|
$ |
|
2019 |
||||
|
$ |
||||
|
$ |
||||
|
$ |
||||
|
$ |
||||
|
$ |
(b) Using the completed-contract method, prepare
schedules to compute the profit or loss to be recognized as a
result of this contract for the years ended December 31, 2017,
2018, and 2019. (Ignore income taxes.) (If answer is 0,
please enter 0. Do not leave any fields blank. Enter negative
amounts using either a negative sign preceding the number e.g. -45
or parentheses e.g. (45).)
|
2018 |
||
|
$ |
|
2019 |
||
|
$ |
||
|
$ |
Answer: Given,
Accumulated contract costs incurred, estimated costs to complete the contract, and accumulated billings to Gumbel for 2017, 2018, and 2019.


THANK YOU!
On July 1, 2017, Torvill Construction Company Inc. contracted to build an office building for Gumbel...
Problem 18-11 On July 1, 2017, Sheffield Construction Company Inc. contracted to build an office building for Gumbel Corp. for a total contract price of $1,920,000. On July 1, Sheffield estimated that it would take between 2 and 3 years to complete the building. On December 31, 2019, the building was deemed substantially completed. Following are accumulated contract costs incurred, estimated costs to complete the contract, and accumulated billings to Gumbel for 2017, 2018, and 2019. At 12/31/17 $273,600 1,246,400...
On July 1, 2020, Crane Construction Company Inc. contracted to build an office building for Gumbel Corp. for a total contract price of $1,900,000. On July 1, Crane estimated that it would take between 2 and 3 years to complete the building. On December 31, 2022, the building was deemed substantially completed. Following are accumulated contract costs incurred, estimated costs to complete the contract, and accumulated billings to Gumbel for 2020, 2021, and 2022. Contract costs incurred to date Estimated...
On March 1, 2017, Bonita Construction Company contracted to construct a factory building for Fabrik Manufacturing Inc. for a total contract price of $8,450,000. The building was completed by October 31, 2019. The annual contract costs incurred, estimated costs to complete the contract, and accumulated billings to Fabrik for 2017, 2018, and 2019 are given below: 2017 2018 2019 Contract costs incurred during the year $2,824,800 $2,086,300 $2,418,900 Estimated costs to complete the contract at 12/31 3,595,200 2,418,900 –0– Billings...
On March 1, 2017, Bonita Construction Company contracted to construct a factory building for Fabrik Manufacturing Inc. for a total contract price of $8,450,000. The building was completed by October 31, 2019. The annual contract costs incurred, estimated costs to complete the contract, and accumulated billings to Fabrik for 2017, 2018, and 2019 are given below: 2017 2018 2019 Contract costs incurred during the year $2,824,800 $2,086,300 $2,418,900 Estimated costs to complete the contract at 12/31 3,595,200 2,418,900 –0– Billings...
Problem 18-10 On March 1, 2017, Sheffield Construction Company contracted to construct a factory building for Fabrik Manufacturing Inc. for a total contract price of $8,340,000. The building was completed by October 31, 2019. The annual contract costs incurred, estimated costs to complete the contract, and accumulated billings to Fabrik for 2017, 2018, and 2019 are given below: 2017 2019 2018 $2,811,600 $2,152,400 $2,336,000 2,336,000 Contract costs incurred during the year Estimated costs to complete the contract at3,578,400 12/31 Billings...
On March 1, 2017, Larkspur
Construction Company contracted to construct a factory building for
Fabrik Manufacturing Inc. for a total contract price of $8,450,000.
The building was completed by October 31, 2019. The annual contract
costs incurred, estimated costs to complete the contract, and
accumulated billings to Fabrik for 2017, 2018, and 2019 are given
below: 2017 2018 2019 Contract costs incurred during the year
$3,052,800 $2,254,300 $1,962,900 Estimated costs to complete the
contract at 12/31 3,307,200 1,962,900 –0– Billings...
Problem 18-10 On March 1, 2017, Culver Construction Company contracted to construct a factory building for Fabrik Manufacturing Inc. for a total contract price of $8,450,000. The building was completed by October 31, 2019. The annual contract costs incurred, estimated costs to complete the contract, and accumulated billings to Fabrik for 2017, 2018, and 2019 are given below: 2019 $1,962,900 Contract costs incurred during the year Estimated costs to complete the contract at 12/31 Billings to Fabrik during the year...
Problem 18-11
Your answer is partially correct. Try again.
On July 1, 2017, Coronado Construction Company Inc. contracted
to build an office building for Gumbel Corp. for a total contract
price of $1,880,000. On July 1, Coronado estimated that it would
take between 2 and 3 years to complete the building. On December
31, 2019, the building was deemed substantially completed.
Following are accumulated contract costs incurred, estimated costs
to complete the contract, and accumulated billings to Gumbel for
2017,...
Problem 18-11 Your answer is partially correct. Try again. On July 1, 2020, Sunland Construction Company Inc. contracted to build an office building for Gumbel Corp. for a total contract price of $1,880,000. On July 1, Sunland estimated that it would take between 2 and 3 years to complete the building. On December 31, 2022, the building was deemed substantially completed. Following are accumulated contract costs incurred, estimated costs to complete the contract, and accumulated billings to Gumbel for 2020,...
Problem 18-11 Your answer is partially correct. Try again. On July 1, 2020, Cullumber Construction Company Inc. contracted to build an office building for Gumbel Corp. for a total contract price of $1,920,000. On July 1, Cullumber estimated that it would take between 2 and 3 years to complete the building. On December 31, 2022, the building was deemed substantially completed. Following are accumulated contract costs incurred, estimated costs to complete the contract, and accumulated billings to Gumbel for 2020,...
