On March 1, 2014 Spieth Company entered into a contract to build an apartment building. It is estimated that the building will cost $2,000,000 and will take 3 years to compete. The contract price was $3,000,000. The following information pertains to the construction period.
2014 2015 2016
Cost to date 270,000 450,000 610,000
Estimated cost to complete 1,400,000 520,0000 0
Progress billing to date 1,050,000 2,000,000 3,000,000
Cash collected to date 950,000 1,950,000 2,850,000

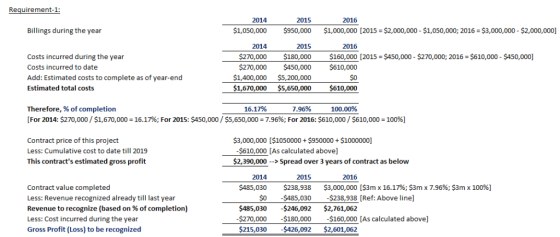

A) Compute the amount of gross profit to be recognized each year, assuming the percentage-of-completion method is used.

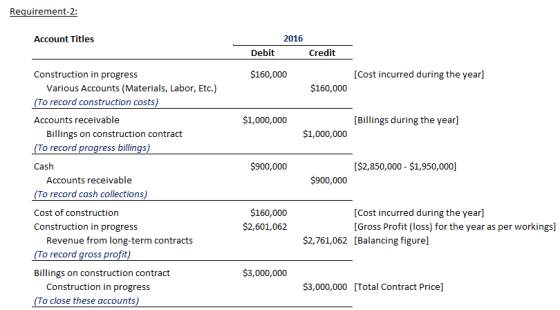

B) Prepare all necessary journal entries for 2016

C) Prepare a partial balance sheet for December 31, 2015, showing the balance in the receivables inventory accounts.
On March 1, 2014 Spieth Company entered into a contract to build an apartment building. It...
18.A construction company was hired on a construction project to build a building for $1,800,000. The project was begun in 2015 and completed in 2016. Cost and other data are presented below: 2015 2016 Costs incurred during the year $450,000 $1,100,000 Estimated costs to complete 1,050,000 0 Billing during the year 400,000 1,400,000 Cash collections during the year 300,000 1,500,000 Assume that A recognizes revenue on this contract over time according to percentage of completion. Required: Prepare all journal entries...
Rangers Corp. entered into a contract to construct a factory building. The contract price is $10,000,000. Cost information over the life of the contract is as follows: Year 2014 2015 2016 Cost Incurred During Year $2,000,000 3,500,000 1.100.000 Estimated Cost to Complete $5,000,000 1,250,000 0 Rangers uses cost-to-cost to estimate the percentage complete on the contract. Provide the amount of gross profit recognized each year using two alternative revenue recognition methods. Year Completed Contract Method Percentage of Completion Method 2014...
Ranger's Corp. entered into a contract to construct a factory
building. The contract price is $10M. cost information over life of
the contract is as follows
5.16 Rangers Corp. entered into a contract to construct a factory building. The contract price is $10,000,000. Cost information over the life of the contract is as follows: Year 2014 2015 2016 Cost Incurred During Year $2,000,000 3,500,000 1,100,000 Estimated Cost to Complete $5,000,000 1.250.000 Rangers uses cost-to-cost to estimate the percentage complete on...
Emmet Property Management entered into a 2-year contract on June 1, 2016, to build an apartment building. The contract starts on July 1, 2016. Under the terms of the contract, Emmet will be paid a fixed fee of $1,500,000 and will receive an additional 10% of the fixed fee provided that building is ready to occupy at the end of the two years. Emmet estimates a 60% chance it will meet the completion date. The total costs of the project...
Emmet Property Management entered into a 2-year contract on June 1, 2016, to build an apartment building. The contract starts on July 1, 2016. Under the terms of the contract, Emmet will be paid a fixed fee of $1,500,000 and will receive an additional 10% of the fixed fee provided that building is ready to occupy at the end of the two years. Emmet estimates a 60% chance it will meet the completion date. The total costs of the project...
Shanahan Construction Company has entered into a contract beginning January 1, 2017, to build a parking complex. It is estimated that the complex will take 3 years to construct. Additional information follows. Estimated cost of complex Contract price AA 600,000 900,000 The following data pertain to the construction period. 2019 610,000 $ 6100 A 2017 270,000 330,000 270,000 240,000 2018 450,000 150,000 550,000 500,000 Costs to date Estimated costs to complete Progress billings to date Cash collected to date $...
Percentage of Completion Problem: The Nifty Construction Company entered into a long-term contract in 2013. The contract price was $1,600,000, and the company initially estimated the total cost of the project to be $1,150,000. The following data pertains to the three years that the contract was in process: 2013 2014 2015 $224,000 $936,000 $1,280,000 Costs incurred to date Estimated costs to complete Billings to date Collections to date 896,000 264,000 0 200,000 1,200,000 1,600,00 170,000 1,070,000 1,500000 Using the percentage...
Fender period. Construction Company receives a contract to construct a building over a 3 year Information relating to the performance of the contract is summarized as follows: 2015 2016 2017 S 16,000,000 Cumulative construction costs incurred to date Estimated costs to complete Billings during the year Cash collected during the year 6,000,000 8,000,000 6,000,000 3,000,000 8,000,000 7,000,000 4,000,000 5,000,000 Required: 1. How much is Fender Construction charging to build this athletic stadium? In other words, what is the contract price...
At the beginning of 2013, the Harding Construction Company received a contract to build an office building for $10 million. Harding will construct the building according to specifications provided by the buyer, and the project is estimated to take three years to complete. According to the contract, Harding will bill the buyer in installments over the construction period according to a prearranged schedule. Information related to the contract is as follows: 2013 2014 2015 Cost incurred during the year $2,300,000...
A construction company entered into a fixed-price contract to build an office building for $30 million. Construction costs incurred during the first year were $10 million and estimated costs to complete at the end of the year were $15 million. During the first year the company billed its customer $11 million, of which $3 million was collected before year-end. What would appear in the year-end balance sheet related to this contract using the percentage-of-completion method? (Enter you answers in whole...
