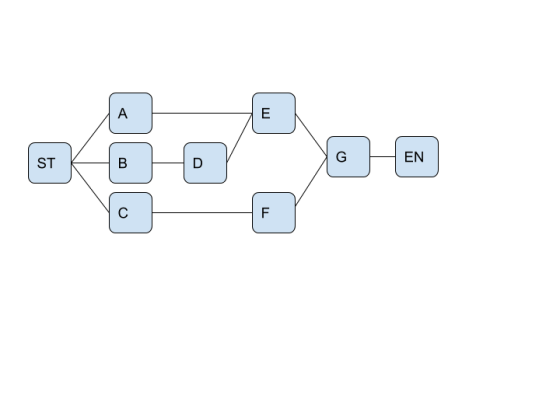

8) Shirley Hopkins is developing a program in leadership training for middle-level managers. Shirley has listed a number of activities that must be completed before a training program of this nature can be conducted. The activities, immediate predecessors, and times appear in the accompanying table. Provide the following: a) AON diagram for these precedencies and b) What is the critical path?What is the total project completion date?What is the slack time for each individual activity?
|
Activity |
Immediate Predecessor |
Time (days) |
|
A |
- |
2 |
|
B |
- |
5 |
|
C |
- |
1 |
|
D |
B |
10 |
|
E |
A,D |
3 |
|
F |
C |
6 |
|
G |
E,F |
8 |
|
ACTIVITY |
DURATION |
ES |
EF |
LS |
LF |
SLACK |
|
A |
2 |
0 |
2 |
13 |
15 |
13 |
|
B |
5 |
0 |
5 |
0 |
5 |
0 |
|
C |
1 |
0 |
1 |
11 |
12 |
11 |
|
D |
10 |
5 |
15 |
5 |
15 |
0 |
|
E |
3 |
15 |
18 |
15 |
18 |
0 |
|
F |
6 |
1 |
7 |
12 |
18 |
11 |
|
G |
8 |
18 |
26 |
18 |
26 |
0 |
FORWARD PASS
1. Go from left to right in a network.
2. ES = maximum of the EF value from all the direct predecessors.
3. EF = ES + Duration.
BACKWARD PASS
1. Go from right to left in a network.
2. LF = minimum of the LS value from all the direct predecessors.
3. LS = LF - Duration.
CRITICAL PATH
1. Total slack of all activities should be 0.
2. The total duration of all the activities should be the highest.
3. Slack = LF - EF or LS - ES
CRITICAL PATH & DURATION
B + D + E + G = 26
