1. a.

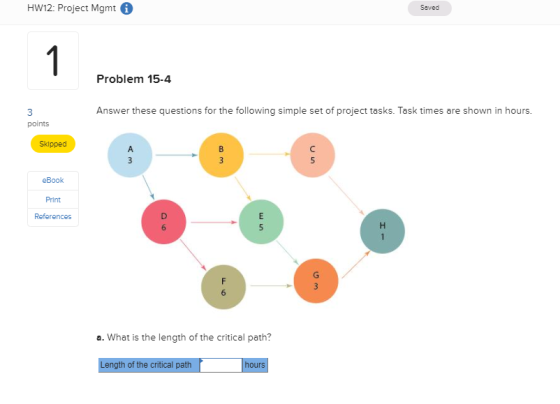

Possible Network paths and their duration are -
ABCH --> 3+3+5+1 = 12
ABEGH --> 3+3+5+3+1 = 15
ADEGH --> 3+6+5+3+1 = 18
ADFGH --> 3+6+6+3+1 = 19
Critical path is the path with longest duration i.e. ADFGH
Length of critical path = 19 hours
1. b.
Earliest Start (ES) = the earliest time when the activity can begin
Earliest Finish (EF) = ES + Activity Duration
Latest Finish (LF) = the latest time by whenthe activity can be finished without changing the project completion duration
Latest Start (LS) = LF - Activity Duration
Slack = LS-ES = LF-EF
Computing using the above gives us the below -
| Activity | Predecessor | Duration | ES | EF | LS | LF | Slack |
| A | - | 3 | 0 | 3 | 0 | 3 | 0 |
| B | A | 3 | 3 | 6 | 7 | 10 | 4 |
| C | B | 5 | 6 | 11 | 13 | 18 | 7 |
| D | A | 6 | 3 | 9 | 3 | 9 | 0 |
| E | B, D | 5 | 9 | 14 | 10 | 15 | 1 |
| F | D | 6 | 9 | 15 | 9 | 15 | 0 |
| G | E, F | 3 | 15 | 18 | 15 | 18 | 0 |
| H | C, G | 1 | 18 | 19 | 18 | 19 | 0 |
ES for E = 9 hours
LS for E = 10 hours
(c) LS for B = 7 hours
(d) If B takes 6 hours, the duration for all paths are -
ABCH --> 3+6+5+1 = 15
ABEGH --> 3+6+5+3+1 = 18
ADEGH --> 3+6+5+3+1 = 18
ADFGH --> 3+6+6+3+1 = 19
Hence, the project length still remains 19 hours and is not impacted
HW12: Project Mgmt。 Saved Problem 15-4 Answer these questions for the following simple set of project tasks. Task times are shown in hours. Skipped eBook Print References a. What is the length of th...
Answer these questions for the following simple set of project tasks. Task times are shown in hours w a. What is the expected time that all five tasks will be completed? Expected time 20 hours b. What is the earliest start for task C? Earliest startſ 4th/nd hour c. What is the latest start for task A? Latest start 1 nd/st hour
Please explain step by step because I do not
understand this problem. Thank You!
Problem 15-4 Answer these questions for the following simple set of project tasks. Task times are shown in hours. a. What is the length of the critical path? b. What are the earliest start and latest start for E? c, what is the latest start for B? d. If all other tasks are completed in their expected durations, will the project length be affected if task...
