Question

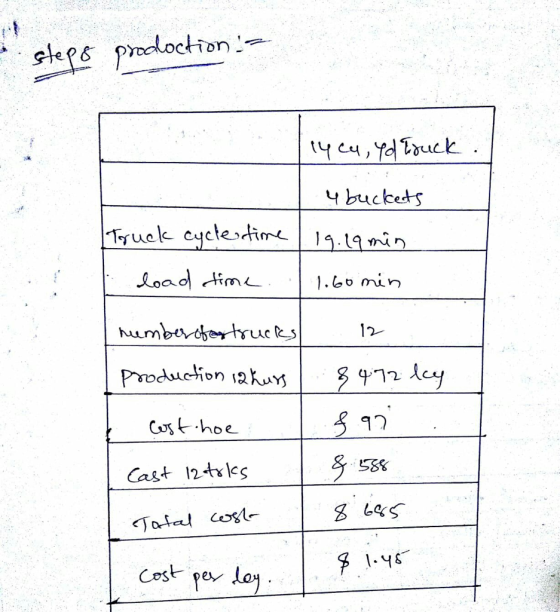

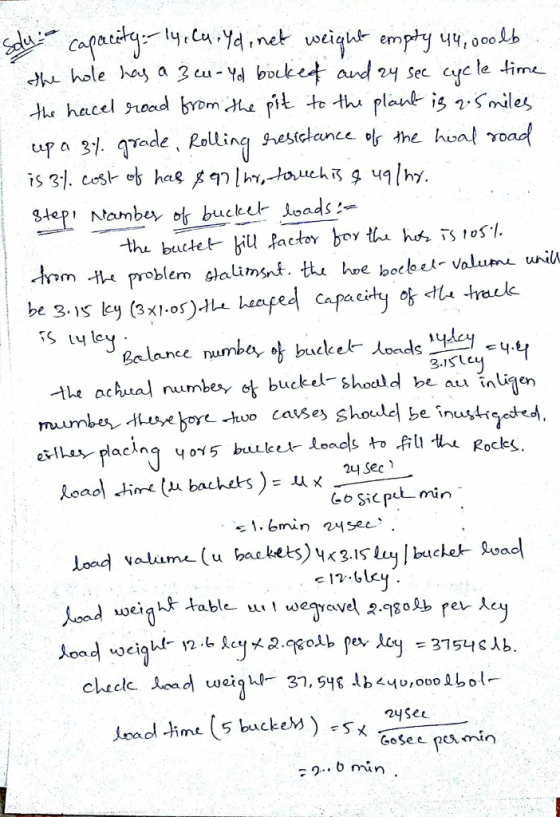

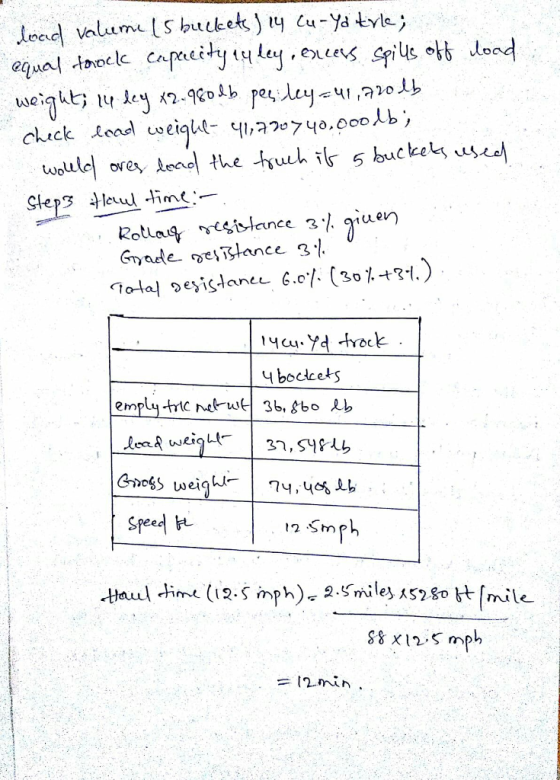

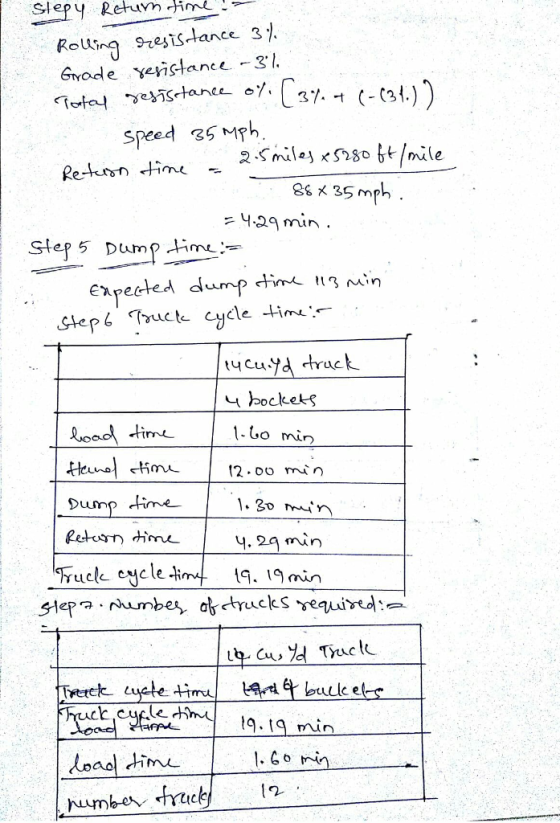

Problem 2: Evaluate cost and production using a 3-cy hoe to load wet gravel (2980 lb/lcy) into 14 cy trucks. Assume a bucket fill factor of 105% and that the hoe bucket swing cycle time is 24 sec. the truck empty weight is 36860 lb, and a rated payload of 40000 lb. Dump time will be 1.3 min. the haul distance is 2.5 miles from the pit to the plant up a 3% grade. The rolling resistance of the haul road will be maintained at 3%. The hoe and operator cost $97 per hour, and trucks cost $49 per hour What is the most cost-effective mix of bucket loads to use in loading the trucks and number of trucks to place on this job?

please help me.

0 0
Add a comment Improve this question Transcribed image text
Know the answer?
Add Answer to:
please help me. Problem 2: Evaluate cost and production using a 3-cy hoe to load wet gravel (2980 lb/lcy) into 14 cy...
Your Answer:

Post as a guest

Your Name:

What's your source?

Earn Coins

Coins can be redeemed for fabulous gifts.

Not the answer you're looking for? Ask your own homework help question. Our experts will answer your question WITHIN MINUTES for Free.
Similar Homework Help Questions
  • please help me , show all steps , please make your font clear.. Problem 1: A...

    please help me , show all steps , please make your font clear.. Problem 1: A project to move packed earth requires you to decide whether to use a dozer/scraper operation or excavator/truck operation. Determine the most economical operation based on the dozer/scraper operation estimated at S6.25/lcy All equipment carries a rated heaped capacity, has a fill factor of 105%, and works 45-min hours. Excavators costs $95/hr (including operator), cycle time is 0.28 min, and bucket heaped capacity is 3...

  • Please solve problem 1 and show formulas used Tables for reference: Homework 6- Chapter 9 Problem...

    Please solve problem 1 and show formulas used Tables for reference: Homework 6- Chapter 9 Problem 1: A crawler hoe having a 2 -cy bucket and whose cost per hour, including the wages to an operator, is $109 will excavate and load haul units under each of the stated conditions. The maximum digging depth of the machine is 22 ft. Determine the cost per bank cubic yard for each condition. (Condition 1: 315 bey/hr, S0.346/bcy; condition 2: 289 bey/hr, S0.377/bcy;...

  • (50) 7. Analyze the following operation. A 385C Excavator will be used to load material into a CAT 740 (no ejector) articulated truck. The excavator is equipped with a 6 cy heaped bucket and is...

    (50) 7. Analyze the following operation. A 385C Excavator will be used to load material into a CAT 740 (no ejector) articulated truck. The excavator is equipped with a 6 cy heaped bucket and is capable of cycling every 30 seconds. The material being loaded weighs 3,300 lbs cy. The job efficiency is 90%. The trucks will be hauling the nmaterial 4000 feet over a road with a total rolling resistance of 9% to the dumpsite and 10% total rolling...

  • Part 1 Complete the following Earthwork Sheet Material: Earth and Gravel, Swell Factor: 83 Strip fill(cy...

    Part 1 Complete the following Earthwork Sheet Material: Earth and Gravel, Swell Factor: 83 Strip fill(cy Total till och Total cut beyl Adj fill (byl Sum (beyl Mass ordinate 1.23 056 2.37 1.20 2.36 3.07 3.60 3.77 3.09 3.01 4.65 Strip cut (boyil 0.04 1.04 097 3.22 2.08 2.33 2.51 1.85 161 1.74 0.88 109 35.70 5.58 18 3.12 2.03 6.77 2.01 2.53 0.82 1.08 1.20 1.92 1.59 1.82 3.95 3.25 2.74 150 7.42 556 80 End-area End area cut...

ADVERTISEMENT
Free Homework Help App
Download From Google Play
Scan Your Homework
to Get Instant Free Answers
Need Online Homework Help?
Ask a Question
Get Answers For Free
Most questions answered within 3 hours.
ADVERTISEMENT
ADVERTISEMENT
