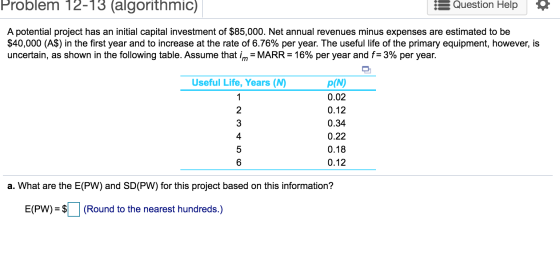

Initial Capital investment is $ 85,000 (Column 1)
Net Revenue increases @ 6.76% (Column 2)
Discounted revenue @ MARR 16% (Column 3) Calculated as

PW(N) is cumulative net outcome of the project up to the year (Column 4)
Probability of useful life of the project is p(N) (Column 5)
Summation of PW(N) X p(N) is E(PW) (Column 6)
Variance of Present Worth is

and Standard Deviation of Present worth is

| Year | Cost | Revenue | Discounted Revenue @ 16% | PW(N) | p(N) | PW(N)*p(N) | PW(N)^2 | p(N)*PW(N)^2 |
| 0 | $ 85,000.00 | $ (85,000.00) | ||||||
| 1 | $ 40,000.00 | $ 34,482.76 | $ (50,517.24) | 0.02 | $ (1,010.34) | $ 2,55,19,91,676.58 | $ 5,10,39,833.53 | |
| 2 | $ 42,704.00 | $ 31,736.03 | $ (18,781.21) | 0.12 | $ (2,253.75) | $ 35,27,33,955.81 | $ 4,23,28,074.70 | |
| 3 | $ 45,590.79 | $ 29,208.09 | $ 10,426.88 | 0.34 | $ 3,545.14 | $ 10,87,19,761.28 | $ 3,69,64,718.83 | |
| 4 | $ 48,672.73 | $ 26,881.51 | $ 37,308.39 | 0.22 | $ 8,207.85 | $ 1,39,19,16,051.05 | $ 30,62,21,531.23 | |
| 5 | $ 51,963.00 | $ 24,740.26 | $ 62,048.65 | 0.18 | $ 11,168.76 | $ 3,85,00,35,437.95 | $ 69,30,06,378.83 | |
| 6 | $ 55,475.70 | $ 22,769.57 | $ 84,818.23 | 0.12 | $ 10,178.19 | $ 7,19,41,31,554.37 | $ 86,32,95,786.52 | |
| E(PW) | $ 29,835.84 | E[(PW)^2] | $ 1,99,28,56,323.65 | |||||
| V(PW) | $ 1,10,26,79,053.21 | |||||||
| SD(PW) | $ 33,206.61 |
