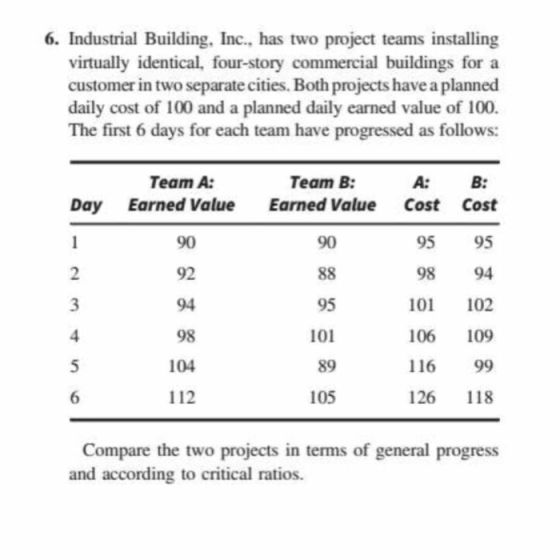

Question

6. Industrial Building, Inc., has two project teams installing virtually identical, four-story commercial buildings for a customer in two separate cities. Both projects have a planned daily cost of 100 and a planned daily earned value of 100 The first 6 days for each team have progressed as follows: Team A: Team B: A: B: Day Earned Value Earned Value Cost Cost 95 95 98 94 0 102 106 109 116 99 126 118 90 92 94 98 104 112 90 95 101 89 105 3 6 Compare the two projects in terms of general progress and according to critical ratios
0 0
Add a comment Improve this question Transcribed image text
Answer #1
DAY-WISE CUMULATIVE PROGRESS
Project A Project B Project A Project B Project A Project B
Day Earned Value Cost EV/C Earned Value Cost EV/C Planned EV/Planned Cost Cumulative EV Cumulative Cost Cumulative EV/C Cumulative EV Cumulative Cost Cumulative EV/C Increase over previous day
1 90 95 0.95 90 95 0.95 1 90 95 0.95 90 95 0.95 EV C EV C
2 92 98 0.94 88 94 0.94 1 182 193 0.94 178 189 0.94 2 3 -2 -1
3 94 101 0.93 95 102 0.93 1 276 294 0.94 273 291 0.94 2 3 7 8
4 98 106 0.92 101 109 0.93 1 374 400 0.94 374 400 0.94 4 5 6 7
5 104 116 0.90 89 99 0.90 1 478 516 0.93 463 499 0.93 6 10 -12 -10
6 112 126 0.89 105 118 0.89 1 590 642 0.92 568 617 0.92 8 10 16 19
Day-wise EV/C is same for both projects
Also cumulative EV/C is decreasing from Day-1 to Day-6
Both have always been less than 1 --on all days & cumulative-- decreasing more as days progress from 1 to 6
indicating that costs are increasing at a rate more than the increase in earned value as for Project A & B
or decreasing at a rate less than earned value for Project B on Day 1 & 5
