Question

Please help and show work for all steps! Everything marked with a red X is incorrect.

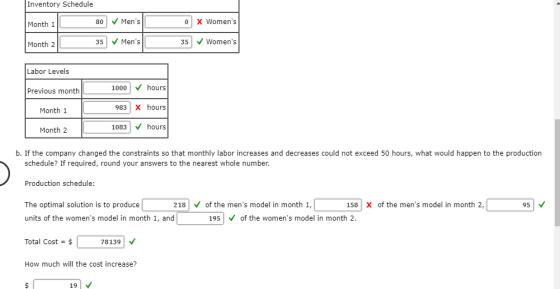

Problem 4-19 (Algorithmic) The Silver Star Bicycle Company will be manufacturing both mens and womens models of its Easy-PeInventory Schedule VMens X Womens 80 0 Month 1 V Mens Womens 35 35 Month 2 Labor Levels V hours 1000 Previous month X hou

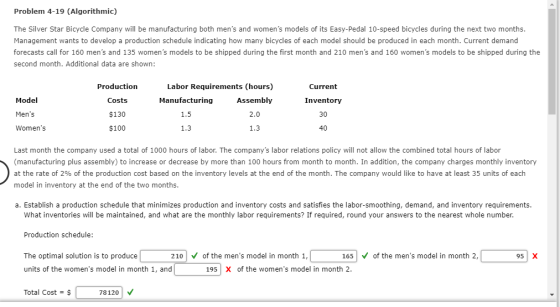

Problem 4-19 (Algorithmic) The Silver Star Bicycle Company will be manufacturing both men's and women's models of its Easy-Pedal 10-speed bicycles during the next two months. Management wants to develop a production schedule indicating how many bicycles of each model should be produced in each month. Current demand forecasts call for 160 men's and 135 women's models to be shipped during the first month and 210 men's and 160 women's models to be shipped during the second month. Additional data are shown: Production Labor Requirements (hours) Current Manufacturing Model Assembly Inventory Costs Men's $130 1.5 2.0 30 Women's $100 1.3 1.3 40 Last month the company used a total of 10000 hours of labor. The company's labor relations policy will not allow the combined total hours of labor (manufacturing plus assembly) to increase or decrease by more than 100 hours from month to month. In addition, the company charges monthly inventory at the rate of 2% of the production cost based on the inventory levels at the end of the month. The company would like to have at least 35 units of each model in inventory at the end of the two months. a. Establish a production schedule that minimizes production and inventory costs and satisfies the labor-smoothing, demand, and inventory requirements. What inventories will be maintained, and what are the monthly labor requirements? If required, round your answers to the nearest whole number. Production schedule: of to produce men's model month n's in mon TI 2 X 210 165 95 195 X of the women's model in month 2 units of the women's model in month 1, and Total Cost $ 78120
Inventory Schedule VMen's X Women's 80 0 Month 1 V Men's Women's 35 35 Month 2 Labor Levels V hours 1000 Previous month X hours 983 Month 1 Vhours 1083 Month 2 b. If the company changed the constraints so that monthly labor increases and decreases could not exceed 50 hours, what would happen to the production schedule? If required, round your answers to the nearest whole number. Production schedule: x of the men's model in month 2, The optimal solution is to produce of the men's model in month 1, 218 158 95 units of the women's model in month 1, and of the women's model in month 2 195 Total Cost $ 78139 How much will the cost increase? 19
0 0
Add a comment Improve this question Transcribed image text
Answer #1

1.

Decision variables

Let

x11 =Number of men's model in month 1

x21 = Number of women's model in month 1

x12 = Number of men's model in month 2

x22 = Number of women's model in month 2

s11 = men's model inventory units at end of month 1

s21 = women's model inventory units at end of month 1

s12 = men's model inventory units at end of month 2

s22 = women's model inventory units at end of month

Objective

Minimize cost

Z=( 130x11 + 100x21 + 130x12 + 100x22) +

Constraints

Satisfy Demand in month 1

30+ x11 - s11 = 160

or

x11 - s11 = 130             ...1

40 + x21 - s21 = 135

or

x21 - s21 = 95   ...2

Satisfy Demand in month 2

s11 + x12 - s12 = 210               ...3

s21 + x22 - s22 = 160                ...4

Ending inventory at the end of month 2 constraints

s12 ≥ 35 ...5

s22 ≥ 35 ...6

Labor Hours constraints (month 1)

In the previous month 100 hrs are used .so in month 1, this can be either

  • 1000-100=900 or
  • 1000+100=1100

3.5 x11 + 2.6 x21 ≥ 900 ...7

3.5 x11 + 2.6 x21 ≤ 1100 ...8

Labour Hours constraints (month 2)

In the previous month (month 1), labour hrs used = 3.5 x11 + 2.6 x21

So in month 2,

The decrease can be up to 100

3.5 x11 + 2.6 x21 - 3.5 x12 - 2.6 x22 ≤ 100 ...9

The increase   can be up to 100

3.5 x12 + 2.6 x22 -3.5 x11 - 2.6 x21 ≤100

Or

-3.5 x11 - 2.6 x21 + 3.5 x12 + 2.6 x22 ≤ 100 ...10

Non-negativity constraint

x11, x12, x21, x22, s11, s12, s21, s22 > 0 ...11

solution

Production Schedule

Men's Model

Women's Model

Month 1

210.0

95.0

Month 2

165.0

195.0

Invnetory Schedule

Men's Model

Women's Model

Month 1

80.0

0.0

Month 2

35.0

35.0

labor hrs

Month 1

983.0

Month 2

1083

Security Warning Automatic update links has been disabled Options.. G9 H C E F G K 1 2 3 month 2 4 month 1 5 x11 x21 x22 x12

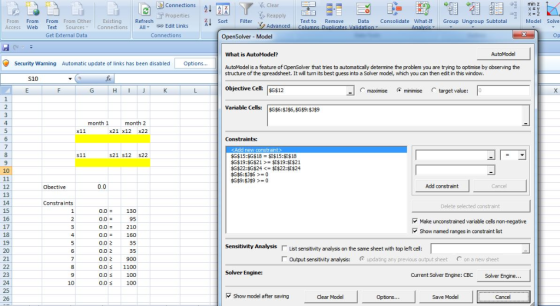

, Clean min z Connections Properties Reapply From From From From Other Refresh Model Solve Existing Connections Filter Text t

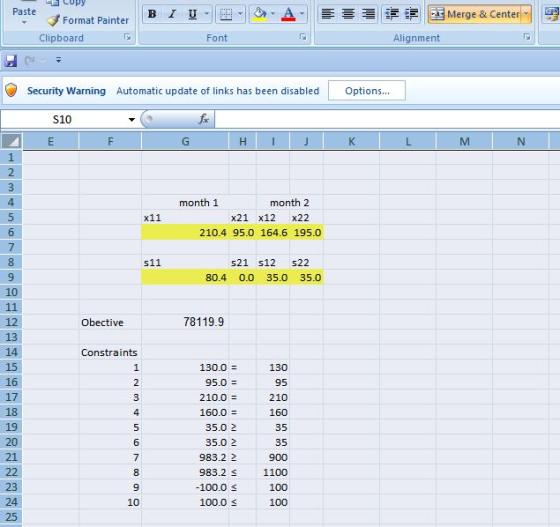

Paste U a Merge & Center Format Painter Alignment Clipboard Font Options... Security Warning Automatic update of links has be

as

2

2.

For the new policy

The RHS of constraints 7,8,9,10 Is changed to 950, 1050, 50, and 50 respectively.

Production Schedule

Men's Model

Women's Model

Month 1

218

95

Month 2

158

195.0

Cost increase =78138.5 – 78119.9=$18.6

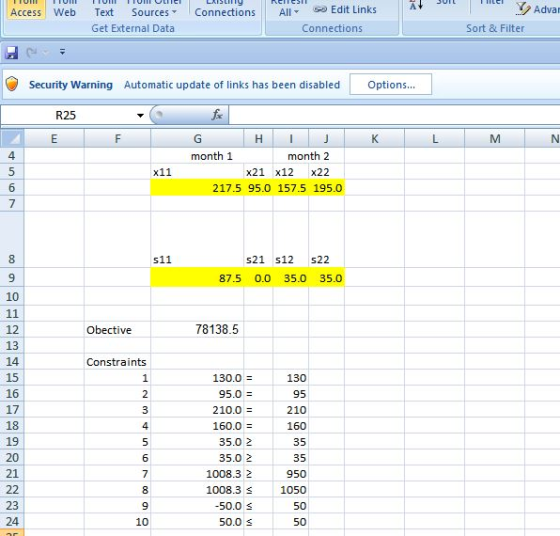

AV GEdit Links Advar Access Web Text Sources Connections All Get External Data Connections Sort & Filter Security Warning Aut
