Question

Racer Oil perfoms oil changes. The standard wage rate for eil change technicians is $13 per hour. By analyzing its past recor

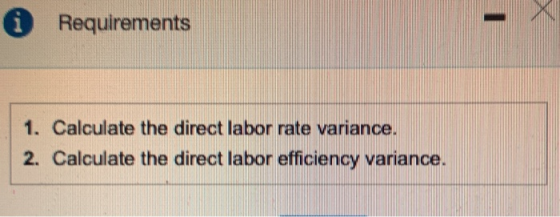

iRequirements 1. Calculate the direct labor rate variance. 2. Calculate the direct labor efficiency variance.
0 0
Add a comment Improve this question Transcribed image text
Answer #1

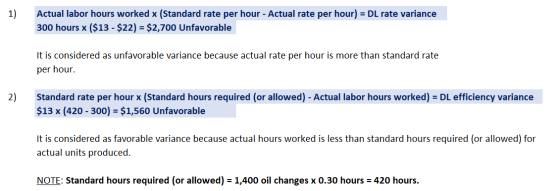

Actual labor hours worked x (Standard rate per hour - Actual rate per hour) 300 hours x ($13 - $22) $2,700 Unfavorable 1) DL

Add a comment
Know the answer?
Add Answer to:
Racer Oil perfoms oil changes. The standard wage rate for eil change technicians is $13 per...
Your Answer:

Post as a guest

Your Name:

What's your source?

Earn Coins

Coins can be redeemed for fabulous gifts.

Not the answer you're looking for? Ask your own homework help question. Our experts will answer your question WITHIN MINUTES for Free.
Similar Homework Help Questions
  • Fiber Oil performs oil changes. The standard wage rate for oil change technicians is $15 per hour...

    Fiber Oil performs oil changes. The standard wage rate for oil change technicians is $15 per hour. By analyzing its past records of time spent on oil changes, the companry has developed a standard of21 minutes (or 0.35 hours) per oil change. In Jully, 900 oil changes were performed at Fiber il Oil change technicians worked a total of 265 direct labor hours at an avcrage rate ol $17 per hour Read the requirements. Requirement 1. Calculate the direct labor...

  • Standard Price and Volume Standards: Direct materials 21.0 yards per awning at $15.00 per yard Direct labor 5.0 hours p...

    Standard Price and Volume Standards: Direct materials 21.0 yards per awning at $15.00 per yard Direct labor 5.0 hours per awning at $17.00 per hour Variable MOH standard rate $4.00 per direct labor hour Predetermined fixed MOH standard rate $7.00 per direct labor hour Total budgeted fixed MOH cost $78,200 Print Done X Actual Results 1 Purchased 51,750 yards at a total cost of $755,550 Used 47,500 yards in producing 2,300 awnings Actual direct labor cost of $194,256 for a...

  • Ander's Clothing manufactures embroidered jackets. The company uses a standard cost system to control manufacturing costs....

    Ander's Clothing manufactures embroidered jackets. The company uses a standard cost system to control manufacturing costs. The following data represent the standard unit cost of a​ jacket:   i Data Table $4.15 per sq. ft.) Direct materials 3.0 sq. ft x 12.45 Direct labor $9.70 per hour) ( 2,0 hours x 19.40 Manufacturing overhead: Variable 2.0 hours x $0.68 per hour) 1.36 4.40 5.76 2.0 hours x $2.20 per hour) Fixed 37.61 Total standard cost per jacket Fixed overhead in total...

  • Purchased 41,800 yards at a total cost of $434,720 Used 38,800 yards in producing 1,900 awnings...

    Purchased 41,800 yards at a total cost of $434,720 Used 38,800 yards in producing 1,900 awnings Actual direct labor cost of $67,100 for a total of 5,500 hours Actual variable MOH $22,550 Actual fixed MOH $47,800 Standards: Direct materials 21.0 yards per awning at $11.00 per yard Direct labor 3.0 hours per awning at $12.00 per hour Variable MOH standard rate $4.00 per direct labor hour Predetermined fixed MOH standard rate $8.00 per direct labor hour Total budgeted fixed MOH...

  • please complete fully, thanks Austin Music manufactures harmonicas. Austin uses standard costs to judge performance. Recently,...

    please complete fully, thanks Austin Music manufactures harmonicas. Austin uses standard costs to judge performance. Recently, a clerk mistakenly threw away some of the records, and only partial data for February exist. Austin knows that the total direct labor variance for the month was $370 F and that the standard labor rate was $8 per hour. A recent pay cut caused a favorable labor rate variance of $0.30 per hour. The standard direct labor hours for actual February outputs were...

  • Please complete fully, thanks i Data Table Kimartin Fabrics manufactures a specialty monogrammed blanket. The following...

    Please complete fully, thanks i Data Table Kimartin Fabrics manufactures a specialty monogrammed blanket. The following are the cost standards for this blanket (Click the icon to view the standards.) Actual results from last month's production of 2,200 blankets are as follows: (Click the icon to view the actual results.) Direct materials (fabric) ............ Direct labor.... .... ....4.0 yards per blanket at $9.50 per yard ...... 1 direct labor hours per blanket at $11.00 per hour . Read the innents...

  • first photo is just the data This Question: 1 pt This Quiz: 4 pts possible 2...

    first photo is just the data This Question: 1 pt This Quiz: 4 pts possible 2 of 4 (0 complete) Ceramics Etc. is a manufacturer of large flower pots for uban settings. The company has these standards (Click the loon to view the standards) m (Cack the icon to view the actual results) Read the requiremerts Requirement 1. Compute the direct labor rate variance and the direct labor efficiency variance. (Enter the varlances as positive numbers. Enter the ourency amounts...

  • help asap please Actual cost and operating data from the most recent month are as follows: EE (Click the loon t...

    help asap please Actual cost and operating data from the most recent month are as follows: EE (Click the loon to view the actual rosults) All manufacturing overhead is allocated on the basis of direct labor hours Pratt Awning manufactures awnings and uses a standard cost systom. The company allocatos overhoed based on the number of direct labor hours. The following are the company's cost and standards data: Read the requirements Requirement 1. Caloulate the standard cost of one awning...

  • Calculating the Direct Labor Rate Variance and the Direct Labor Efficiency Variance Guillermo's Oil and Lube...

    Calculating the Direct Labor Rate Variance and the Direct Labor Efficiency Variance Guillermo's Oil and Lube Company is a service company that offers oil changes and lubrication for automobiles and light trucks. On average, Guillermo has found that a typical oil change takes 24 minutes and 6.2 quarts of oil are used. In June, Guillermo's Oil and Lube had 950 oil changes. Guillermo's Oil and Lube Company provided the following information for the production of oil changes during the month...

  • Assume Drake Consulting has created a standard cost card for each job. Standard direct materials per...

    Assume Drake Consulting has created a standard cost card for each job. Standard direct materials per job include 14 software packages at a cost of $950 per package. Standard direct labor costs per job include 100 hours at $150 per hour. Drake plans on completing 11 jobs during March 2018. Actual direct materials costs for March included 85 software packages at a total cost of $82,875. Actual direct labor costs included 115 hours per job at an average rate of...

ADVERTISEMENT
Free Homework Help App
Download From Google Play
Scan Your Homework
to Get Instant Free Answers
Need Online Homework Help?
Ask a Question
Get Answers For Free
Most questions answered within 3 hours.
ADVERTISEMENT
ADVERTISEMENT
