Question

Project ABC Scope = 10 chairs @ $10.00 = $100.00 PV = Timeframe = 10 days...

Project ABC

Scope = 10 chairs @ $10.00 = $100.00 PV = Timeframe = 10 days AC = At the End of the 5th day 4 chairs were EV = Completed at a cost of $11.00 each CV = CPI= SV = SPI= CR = To install a 10,000 feet fence at a cost of $10.00/per foot. It is estimated that 500 feet of fence can be installed per week for a total of 20 weeks. After 12 weeks and with 50% of work completed $45,000.00 has been spent. Calculate the following and submit the exercise results in a Word document.

Budget at Completion (BAC) = ___________________________ #feet fence * cost/foot

Planned Value (PV) - ________________________________ BAC * (%time passed)

Earned Value (EV) _______________________________________ BAC * % completed

Actual Cost (AC) _________________________________________

Cost Variance (CV) _________________________________________ EV - AC

Schedule Variance (SV) _________________________________________ EV - PV

Cost Performance Index (CPI) ____________________________________ EV/AC %

Schedule Performance Index (SPI) ___________________________________ EV/PV %

Estimate at Completion (EAC) _____________________________________ BAC/CPI

Estimate to Complete (ETC) ____________________________________ EAC - AC

Variance at Completion (VAC) ____________________________________

BAC-EAC To Complete Performance Index ______________________________ (BAC-EV)/(BAC/AC)

0 0
Add a comment Improve this question Transcribed image text
Answer #1

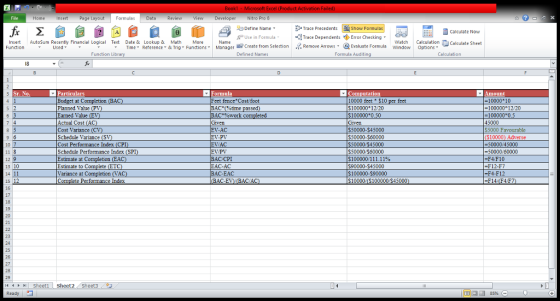

- File 5 EX Home InsertPage LayoutFormulas DataReview View DeveloperNitro Pro8 Cut Copy 11, A-=-9- Ewrap Text General Fll Z в 1 u. 田? 上,A, a-A, 国Merge & Center. 掴Merge & Center. % , aiog Conditional Format Cell | Insert Delete Format % , -28鼎Conditional Format- CellInsert Delete Format Sort & Find & Blu- ロ. 迴 ! Format Painter Clipboard Format Painter Formatting as Table, Styles 2 Clear Filter Select Font Alignment Number Cells Sr. Particulars Formula Feet fence Cost foot BAC*(me p Computation 10000 feet $10 per feet $100000 1220 $100000 0.50 Amount Budget at Completion BAC) 2Planned Value (P 3Earned Value 4Actual Cost (AC) 5Cost Variance (C 6 Schedule Variance (SV) 7 Cost Performance Index (CP 100000 AC%work Given EV-AC EV-PV EV/AC $50000-S45000 $50000-$60000 $50000 S45000 $50000 S60000 $1000001 11.11% (S10000) Adverse 111.11% 83.339 90000 9 Estimate at Completion (EAC) CPI EAC-AC Estimate to Complete (ETC) 11 Variance at Completion (VAC) BAC-EAC $100000-$90000 $10000 ($100000 S45000) 41 H Sheetl Sheet2 Sheet3 Ready !File Home Insert Page Layout﹁ Formulas Data Review View Developer Nitro Pro 5 EX Define Name Trace Precedents calculate Now | 嚃Trace Dependents ◆Error Checking . Remove Arrows Evaluate Formula ruse in Formula- watch Calculation Calculate Sheet Window | Options Insert Autosum Recently Financial Logical Text Date & Lookup & Math More - Time- Reterence - & Trig - FunctionsManager ECreate from SelectionRemove Arrows-Evaluate Formula Windo Options Function Library Defined Names Formula Auditing Calculation Particulars Budget at Completion (BA Formula Feet fence*Cost foot BAC(%tree passed) BAC%work completed 10000 feet $10 per feet $100000 12/20 $100000 0.50 Amount -10000*10 -100000 12/20 -100000 0.5 Earned Value Actual Cost (AC EV-AC $50000-$45000 50000-S60000 $50000 $45000 $50000 S60000 $100000 111.11% ariance Schedule Variance (SV) EV-PV EV/AC ($10000) Adverse -50000/45000 10 7 Cost Performance Index (CPI) Schedule Performance Index (SPD Estimate at Completion (EAC Estimate to Complete (ET 0000 60000 F4 F10 BAC CPI EAC-AC BAC-EAC BAC-EV BAC/AC 12 9 letion $100000-$90000 10000 $100000 $45000 Complete Performance Index 41 H Sheetl Sheet2 Sheet3 ,ウ
