| 1 | Percentage of completion=Cost incurred during the year/Total estimated cost | ||||||
| Revenue to be recognized=(Contract price*Percentage of completion)-Revenue already recognized | |||||||
| Gross profit/(loss) to be recognized=(Estimated gross profit/(Loss) *percentage of completion)-Gross profit already recognized | |||||||
| Estimated gross profit/(loss)=Contract price-Total estimated costs | |||||||
| 2021 | 2022 | 2023 | |||||
| a) Contract price | 8240000 | 8240000 | 8240000 | ||||
| b) Actual cost to date | 2080000 | 4660000 | 8540000 | ||||
| (2080000+2580000) | (4660000+3880000) | ||||||
| c) Estimated costs to complete | 4080000 | 3720000 | 0 | ||||
| d) Total estimated costs (b)+© | 6160000 | 8380000 | 8540000 | ||||
| e) Estimated gross profit/(loss) (a)-(d) | 2080000 | -140000 | -300000 | ||||
| f) Percentage of completion (b)/(d) | 33.77% | 55.61% | 100.00% | ||||
| g) Revenue to be recognized | 2782338 | 1737662 | 3720000 | ||||
| (8240000*33.77%)-0 | Note:1 | (Note:2) | |||||
| h) Gross profit/(loss) to be recognized | 702338 | -842338 | -160000 | ||||
| (2080000*33.77%)-0 | (Note:1) | (Note:2) | |||||
| Note:1 | |||||||
| If estmated gross loss appears,then entire loss has to be recognized in that year itself irrespective of percentage of completion method | |||||||
| Hence,loss to be recognized=140000+702338=$ 842338 | |||||||
| Revenue to be recognized=Expense to be recognized-loss to be recogized=2580000-842338=1737662 | |||||||
| Note:2 | |||||||
| Hence,loss to be recognized=-300000+140000=$ -160000 | |||||||
| Revenue to be recognized=Expense to be recognized-loss to be recogized=3880000-160000=3720000 | |||||||
| Percentages of completion | |||||||
| Year | Actual cost to date | / | Estimated total costs | = | % complete to date | ||
| 2021 | 2080000 | / | 6160000 | = | 33.7662% | ||
| 2022 | 4660000 | / | 8380000 | = | 55.6086% | ||
| 2023 | 8540000 | / | 8540000 | = | 100.0000% | ||
| 2021 | |||||||
| To date | Recognized in prior years | Recognized in 2021 | |||||
| a | b | a-b | |||||
| Construction revenue | 2782338 | 0 | 2782338 | ||||
| Construction expense | 2080000 | 0 | 2080000 | ||||
| Gross profit (loss) | 702338 | 0 | 702338 | ||||
| 2022 | |||||||
| To date | Recognized in prior years | Recognized in 2022 | |||||
| a | b | a-b | |||||
| Construction revenue | 1737662 | ||||||
| (Note:1) | |||||||
| Construction expense | 4660000 | 2080000 | 2580000 | ||||
| Gross profit (loss) | -140000 | 702338 | -842338 | ||||
| 2023 | |||||||
| To date | Recognized in prior years | Recognized in 2023 | |||||
| a | b | a-b | |||||
| Construction revenue | 3720000 | ||||||
| (Note:2) | |||||||
| Construction expense | 8540000 | 4660000 | 3880000 | ||||
| Gross profit (loss) | -300000 | -140000 | -160000 | ||||
| Journal entries: | |||||||
| 2-a. | Date | Account Titles and Explanation | Debit | Credit | |||

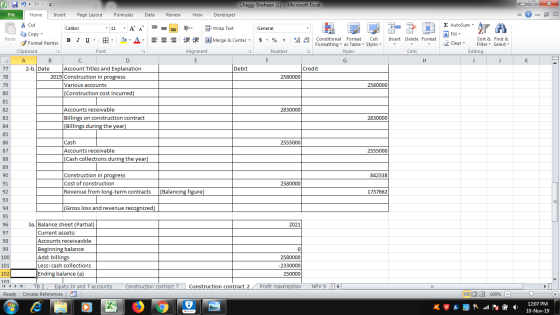

| 2018 | Construction in progress | 2080000 | |||||
| Various accounts | 2080000 | ||||||
| (Construction cost incurred) | |||||||
| Accounts receivable | 2580000 | ||||||
| Billings on construction contract | 2580000 | ||||||
| (Billings during the year) | |||||||
| Cash | 2330000 | ||||||
| Accounts receivable | 2330000 | ||||||
| (Cash collections during the year) | |||||||
| Construction in progress | 702338 | ||||||
| Cost of construction | 2080000 | ||||||
| Revenue from long-term contracts | 2782338 | ||||||
| (Gross profit and revenue recognized) | |||||||



On February 1, 2021, Arrow Construction Company entered into a three-year construction contract to build a...
On February 1, 2021, Arrow Construction Company entered into a three-year construction contract to build a bridge for a price of $8.210,000. During 2021, costs of $2,070,000 were incurred with estimated costs of $4,070,000 yet to be incurred. Billings of $2,570,000 were sent, and cash collected was $2,320,000. In 2022, costs incurred were $2,570,000 with remaining costs estimated to be $3,705.000. 2022 billings were $2.820,000 and $2,545,000 cash was collected. The project was completed in 2023 after additional costs of...
On February 1, 2021, Arrow Construction Company entered into a three-year construction contract to build a bridge for a price of $8,300,000. During 2021, costs of $2,100,000 were incurred with estimated costs of $4,100,000 yet to be incurred. Billings of $2,600,000 were sent, and cash collected was $2,350,000. In 2022, costs incurred were $2,600,000 with remaining costs estimated to be $3,750,000. 2022 billings were $2,850,000 and $2,575,000 cash was collected. The project was completed in 2023 after additional costs of...
On February 1, 2021, Arrow Construction Company entered into a three-year construction contract to build a bridge for a price of $8,240,000. During 2021, costs of $2,080,000 were incurred with estimated costs of $4,080,000 yet to be incurred. Billings of $2,580,000 were sent, and cash collected was $2,330,000. In 2022, costs incurred were $2,580,000 with remaining costs estimated to be $3,720,000. 2022 billings were $2,830,000 and $2,555,000 cash was collected. The project was completed in 2023 after additional costs of...
On February 1, 2021, Arrow Construction Company entered into a three-year construction contract to build a bridge for a price of $8,030,000. During 2021, costs of $2,010,000 were incurred with estimated costs of $4,010,000 yet to be incurred. Billings of $2,510,000 were sent, and cash collected was $2,260,000. In 2022, costs incurred were $2,510,000 with remaining costs estimated to be $3,615,000. 2022 billings were $2,760,000 and $2,485,000 cash was collected. The project was completed in 2023 after additional costs of...
On February 1, 2021, Arrow Construction Company entered into a three-year construction contract to build a bridge for a price of $8,120,000. During 2021, costs of $2,040,000 were incurred with estimated costs of $4,040,000 yet to be incurred. Billings of $2,540,000 were sent, and cash collected was $2,290,000. In 2022, costs incurred were $2,540,000 with remaining costs estimated to be $3,660,000. 2022 billings were $2,790,000 and $2,515,000 cash was collected. The project was completed in 2023 after additional costs of...
On February 1, 2021, Arrow Construction Company entered into a three-year construction contract to build a bridge for a price of $8,120,000. During 2021, costs of $2,040,000 were incurred with estimated costs of $4,040,000 yet to be incurred. Billings of $2,540,000 were sent, and cash collected was $2,290,000. In 2022, costs incurred were $2,540,000 with remaining costs estimated to be $3,660,000. 2022 billings were $2,790,000 and $2,515,000 cash was collected. The project was completed in 2023 after additional costs of...
On February 1, 2021, Arrow Construction Company entered into a three-year construction contract to build a bridge for a price of $8,240,000. During 2021, costs of $2,080,000 were incurred with estimated costs of $4,080,000 yet to be incurred. Billings of $2,580,000 were sent, and cash collected was $2,330,000 In 2022, costs incurred were $2,580,000 with remaining costs estimated to be $3,720,000.2022 billings were $2,830,000 and $2,555,000 cash was collected. The project was completed in 2023 after additional costs of $3,880,000...
On February 1, 2021, Arrow Construction Company entered into a three-year construction contract to build a bridge for a price of $8,300,000. During 2021, costs of $2,120,000 were incurred, with estimated costs of $4,120,000 yet to be incurred. Billings of $2,644,000 were sent, and cash collected was $2,370,000. In 2022, costs incurred were $2,644,000 with remaining costs estimated to be $3,780,000. 2022 billings were $2,894,000, and $2,595,000 cash was collected. The project was completed in 2023 after additional costs of...
On February 1, 2021, Arrow Construction Company entered into a three-year construction contract to build a bridge for a price of $8,150,000. During 2021, costs of $2,060,000 were incurred, with estimated costs of $4,060,000 yet to be incurred. Billings of $2,572,000 were sent, and cash collected was $2,310,000. In 2022, costs incurred were $2,572,000 with remaining costs estimated to be $3,690,000. 2022 billings were $2,822,000, and $2,535,000 cash was collected. The project was completed in 2023 after additional costs of...
On February 1, 2021, Arrow Construction Company entered into a three-year construction contract to build a bridge for a price of $8,050,000. During 2021, costs of $2,020,000 were incurred, with estimated costs of $4,020,000 yet to be incurred. Billings of $2,524,000 were sent, and cash collected was $2,270,000. In 2022, costs incurred were $2,524,000 with remaining costs estimated to be $3,630,000. 2022 billings were $2,774,000, and $2,495,000 cash was collected. The project was completed in 2023 after additional costs of...
