Question

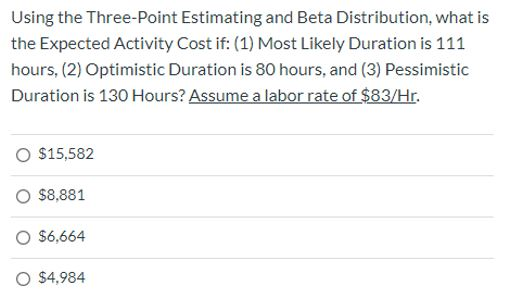

Using the Three-Point Estimating and Beta Distribution, what is the Expected Activity Cost if: (1) Most Likely Duration is 11

0 0
Add a comment Improve this question Transcribed image text
Answer #1
1. Three point distribution:
Three point Distribution: E = (o + m + p ) / 3
where E is Estimate; o = optimistic estimate; p = pessimistic estimate; m = most likely estimate
E = (80+111+130)/3
E = 321/3
E = 107 hours
hence labour cost = 107*83 = 8,881
Option B is correct answer.
2. Beta distribution method
E = (o + 4m + p ) / 6
E = (80 + 444 + 130)/6
E = 109 Hours
hence, labour cost = 109*83 = $9047
Add a comment
Know the answer?
Add Answer to:
Using the Three-Point Estimating and Beta Distribution, what is the Expected Activity Cost if: (1) Most...
Your Answer:

Post as a guest

Your Name:

What's your source?

Earn Coins

Coins can be redeemed for fabulous gifts.

Not the answer you're looking for? Ask your own homework help question. Our experts will answer your question WITHIN MINUTES for Free.
Similar Homework Help Questions
  • Pert project method Activity Predecessors A group 5 optimistic Most likely Pessimistic Expected Variance a m...

    Pert project method Activity Predecessors A group 5 optimistic Most likely Pessimistic Expected Variance a m b Time (t) o 2 3 2 1 B с D NWN mlm A 1 A,B 2 4 1 6 7 9 F 1 с с DE F,G 4 2 5 3 G 4 12 H 2 4 From the table above find the flowing answers. 1. Construct the project Network 2. Find the expected duration and Variance of each activity 3. Find the...

  • Please use the table to answer questions, SHOW WORK Consider the following work breakdown structure for questions 46-50: Duration (Days) Most Start Finish Activity Node Node Optimistic Likely Pessimi...

    Please use the table to answer questions, SHOW WORK Consider the following work breakdown structure for questions 46-50: Duration (Days) Most Start Finish Activity Node Node Optimistic Likely Pessimistic 50 31 70 41 35 59 34 82 41 58 32 30 5 46 What is the estimated expected (mean) time tor activity D? A 32 days B. 41 days C 44 days D. 42 days E 40 dayts 46 What is the estimated standard deviation for the critical path? A...

  • Question 15 (1 point) If three month e-mini S&P500 futures trade below spot then the most...

    Question 15 (1 point) If three month e-mini S&P500 futures trade below spot then the most likely explanation ... Dividends exceed risk free rate This is not possible S&P500 index is expected to decrease Arbitragers are absent from the market Question 16 (1 point) Expected level of S&P500 in 3-months dose NOT depend on ... e-mini futures price dividend rate risk free rate O market risk premium

  • 1. Tatman Corporation uses an activity-based costing system with the following three activity cost pools: Activity...

    1. Tatman Corporation uses an activity-based costing system with the following three activity cost pools: Activity Cost Pool Total Activity Fabrication 10,000 Machine-hours Order Processing 800 Orders Other N/A The other activity pool is used to accumulate costs of idle capacity and organization-sustaining costs. The company has provided the following data concerning its costs: Wages and Salaries 320,000 Depreciation 220,000 Occupancy 120,000 Total 660,000 The distribution of resource consumptions across activity cost pools is given below:   (Activity Cost Pools/Order) Fabrication...

  • Question 18 What are the two principles when crashing a project? Focus on the critical path,...

    Question 18 What are the two principles when crashing a project? Focus on the critical path, select the least expensive alternative. Reduce the cost, reduce the duration. Reduce the duration, increase the cost. Reduce the use of resources, reduce the cost 4 points Question 19 The formula for computing the cost/time slope for each activity that can be crashed is . (Crash cost + Normal cost) / (Crash time + Normal time) (Crash cost - Normal cost) / (Crash time...

  • XYZ Company applies overhead to jobs using direct labor cost as an activity. For the current...

    XYZ Company applies overhead to jobs using direct labor cost as an activity. For the current year, XYZ's estimated overhead was $600,000 and estimated direct labor cost was $240,000. Actual overhead costs for the year totaled $640,000 and actual direct labor costs for the year were $250,000. For the year, overhead was: over-applied by $40,000 O over-applied by $15,000 over-applied by $10,000 under-applied by $40,000 under-applied by $15,000 under-applied by $10,000 O none of the above choices are correct Shown...

  • Question 50 (1 point) A(n) _____ in oil prices and a(n) _____ in taxes will shift...

    Question 50 (1 point) A(n) _____ in oil prices and a(n) _____ in taxes will shift short-run aggregate supply to the left. Question 50 options: a) decrease; increase b) decrease; decrease c) increase; decrease d) increase; increase Question 51 (1 point) Which of the following events will shift the aggregate demand curve to the right? Question 51 options: a) an increase in household debt b) a catastrophic hurricane hitting the northeastern United States c) a decrease in taxes d) a...

  • please help Question 23 (1 point) Which observation is NOT explained by the intermediate disturbance hypothesis...

    please help Question 23 (1 point) Which observation is NOT explained by the intermediate disturbance hypothesis In the interior of an old forest a low number of K-type species dominate the community Species evenness is larger when disturbances are extremely frequent Species richness increases immediately after a disturbance such as a fire, but may decrease later In beach dune environments, a low number of r-type species dominate the community Question 24 (1 point) Some birds follow moving swarms of army...

  • Home Insert Draw Page Layout Formulas Data Review View Help Tell me what you want to...

    Home Insert Draw Page Layout Formulas Data Review View Help Tell me what you want to do = = ). General Calibri B I 11 . Font - A A . .A. Wrap Text Merge & Center. U $ . % * 3 Alignment Number Clipboard R14 4. A . B C D G H nter the last 4 digits of your student ID number 4 Name/s: 7 Save this file in EXCEL FORMAT as: P2 Lastname 8 Round all...

  • I need help on the highlighted questiona. For questions 2,4, & 5 I need help with...

    I need help on the highlighted questiona. For questions 2,4, & 5 I need help with the step by step process to the answers. Thanks! what financial data do you need? i sent a photo of the assigment. The last photo is of a balance sheet and income statement QUESTIONS 1. Give as many reasons as you can why Moore's initial estimate of the value of the restaurant was inappropriate. 2. Calculate the current liquidation value of the business assuming...

ADVERTISEMENT
Free Homework Help App
Download From Google Play
Scan Your Homework
to Get Instant Free Answers
Need Online Homework Help?
Ask a Question
Get Answers For Free
Most questions answered within 3 hours.
ADVERTISEMENT
ADVERTISEMENT
