Hello,
Can you please help me with this problem and give an explanation for the required tabs (1,2 and 3)? Thank you

Hello, Can you please help me with this problem and give an explanation for the required...
I
need help completing this. Thank you!!

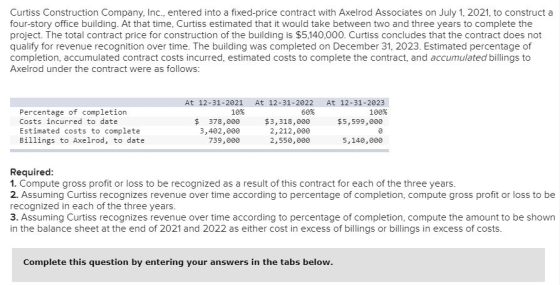

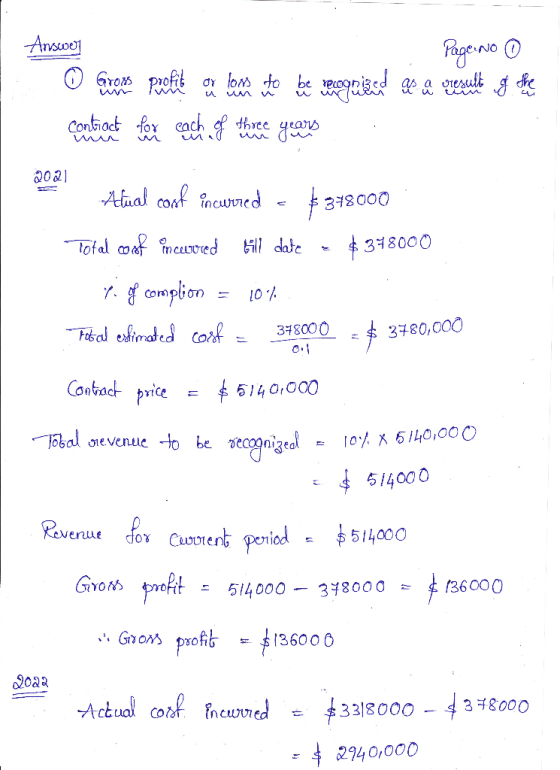

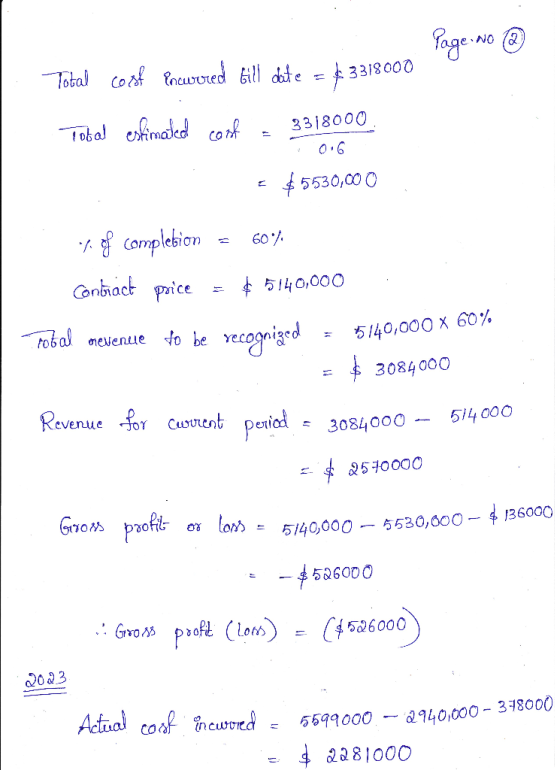

Saved Help Save & Exit Submi Check my work Curtiss Construction Company, Inc., entered into a fixed-price contract with Axelrod Associates on July 1, 2021, to construct a four-story office building. At that time, Curtiss estimated that it would take between two and three years to complete the project. The total contract price for construction of the building is $4,660,000. The building was completed on December 31, 2023. Estimated percentage of completion, accumulated...
Chapter 06 0 Saved Help Save & Exit Submit Check my work 10 Curtiss Construction Company, Inc., entered into a fixed-price contract with Axelrod Associates on July 1, 2021, to construct a four-story office building. At that time, Curtiss estimated that it would take between two and three years to complete the project. The total contract price for construction of the building is $4,720,000. The building was completed on December 31, 2023. Estimated percentage of completion, accumulated contract costs incurred,...
Check my work Curtiss Construction Company, Inc., entered into a fixed-price contract with Axelrod Associates on July 1, 2021, to construct a four-story office building. At that time, Curtiss estimated that it would take between two and three years to complete the project. The total contract price for construction of the building is $4,480,000. The bullding was completed on December 31, 2023. Estimated percentage of completion, accumulated contract costs incurred, estimated costs to complete the contract, and accumulated billings to...
Check my work 10 Curtiss Construction Company, Inc., entered into a fixed-price contract with Axelrod Associates on July 1, 2021, to construct a four-story office building. At that time, Curtiss estimated that it would take between two and three years to complete the project. The total contract price for construction of the building is $4,000,000. The building was completed on December 31, 2023. Estimated percentage of completion, accumulated contract costs incurred, estimated costs to complete the contract, and accumulated billings...
Curtiss Construction Company, Inc., entered into a fixed price contract with Axelrod Associates on July 1, 2021, lo construct a four- story office building. At that time, Curtiss estimated that it would take belween two and three years to complete the project. The total contract price for construction of the building is $5.080,000. Curliss concludes that the contract does not qually for revenue recognition over time. The building was completed on December 31, 2023. Estimated percentage of completion, accumulated contract...
Curtiss Construction Company, Inc., entered into a fixed-price contract with Axelrod Associates on July 1, 2021, to construct a four-story office building. At that time, Curtiss estimated that it would take between two and three years to complete the project. The total contract price for construction of the building is $4,600,000. The building was completed on December 31, 2023. Estimated percentage of completion, accumulated contract costs incurred, estimated costs to complete the contract, and accumulated billings to Axelrod under the...
Curtiss Construction Company, Inc., entered into a fixed-price contract with Axelrod Associates on July 1, 2021, to construct a four-story office building. At that time, Curtiss estimated that it would take between two and three years to complete the project. The total contract price for construction of the building is $4,420,000. Curtiss concludes that the contract does not qualify for revenue recognition over time. The building was completed on December 31, 2023. Estimated percentage of completion, accumulated contract costs incurred,...
Curtiss Construction Company, Inc., entered into a fixed price contract with Axelrod Associates on July 1, 2021, to construct a four-stor office building. At that time, Curtiss estimated that it would take between two and three years to complete the project. The total contract price for construction of the building is $4,240,000. The building was completed on December 31, 2023. Estimated percentage of completion, accumulated contract costs incurred, estimated costs to complete the contract, and accumulated billings to Axelrod under...
Curtiss Construction Company, Inc., entered into a fixed-price contract with Axelrod Associates on July 1, 2021, to construct a four-story office building. At that time, Curtiss estimated that it would take between two and three years to complete the project. The total contract price for construction of the building is $4,960,000. The building was completed on December 31, 2023. Estimated percentage of completion, accumulated contract costs incurred, estimated costs to complete the contract, and accumulated billings to Axelrod under the...
Hello,
Can you please help me with this problem and give an explanation
for each required tab (1-3)? Thank you.
On June 15, 2021, Sanderson Construction entered into a long-term construction contract to build a baseball stadium in Washington, D.C., for $330 million. The expected completion date is April 1, 2023, just in time for the 2023 baseball season. Costs incurred and estimated costs to complete at year-end for the life of the contract are as follows ($ in millions):...
