Curtiss Construction Company, Inc., entered into a fixed-price
contract with Axelrod Associates on July 1, 2021, to construct a
four-story office building. At that time, Curtiss estimated that it
would take between two and three years to complete the project. The
total contract price for construction of the building is
$4,960,000. The building was completed on December 31, 2023.
Estimated percentage of completion, accumulated contract costs
incurred, estimated costs to complete the contract, and
accumulated billings to Axelrod under the contract were as
follows:
| At 12-31-2021 | At 12-31-2022 | At 12-31-2023 | |||||||||
| Percentage of completion | 10 | % | 60 | % | 100 | % | |||||
| Costs incurred to date | $ | 375,000 | $ | 3,192,000 | $ | 5,386,000 | |||||
| Estimated costs to complete | 3,375,000 | 2,128,000 | 0 | ||||||||
| Billings to Axelrod, to date | 736,000 | 2,490,000 | 4,960,000 | ||||||||
Required:

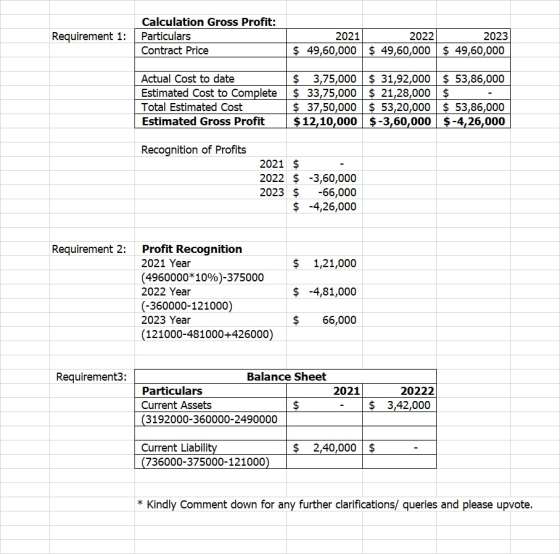

1. Compute gross profit or loss to be recognized as a
result of this contract for each of the three years. Curtiss
concludes that the contract does not qualify for revenue
recognition over time.
2. Assuming Curtiss recognizes revenue over time
according to percentage of completion, compute gross profit or loss
to be recognized in each of the three years.
3. Assuming Curtiss recognizes revenue over time
according to percentage of completion, compute the amount to be
shown in the balance sheet at the end of 2021 and 2022 as either
cost in excess of billings or billings in excess of costs.
