Solution:

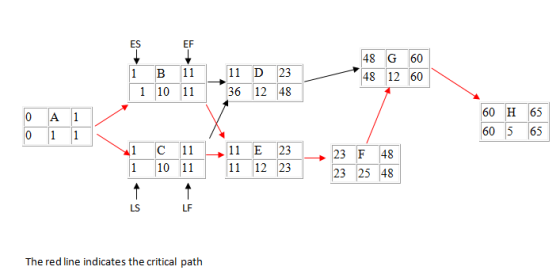

a. 65 hours is the total project time as the EF of the last activity H is 65.
The below diagram shows this
b. Only activity D can be
delayed because the activity has a slack of 25 hours
LS-ES = 36-11 =25
The home office biling department of a chain of department stores prepares monthly inventory reports for...

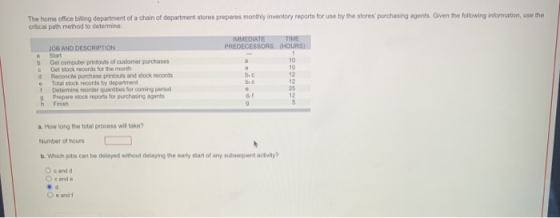

The home office billing department of a chain of department stores prepares monthly inventory reports for use by the stores' purchasing agents. Given the following information, use the critical path method to determine: IMMEDIATE TIME PREDECESSORS (HOURS) d e f g h JOB AND DESCRIPTION Start Get computer printouts of customer purchases Get stock records for the month Reconcile purchase printouts and stock records Total stock records by department Determine reorder quantities for coming period Prepare stock reports for purchasing...
The home office billing department of a chain of department stores prepares monthly inventory reports for use by the stores’ purchasing agents. Given the following information, use the critical path method to determine: JOB AND DESCRIPTION IMMEDIATE PREDECESSORS TIME (HOURS) a Start — 0 b Get computer printouts of customer purchases a 9 c Get stock records for the month a 18 d Reconcile purchase printouts and stock records b c 28 e Total stock records by department b c...
How can we assess whether a project is a success or a
failure?
This case presents two phases of a large business transformation project involving the implementation of an ERP system with the aim of creating an integrated company. The case illustrates some of the challenges associated with integration. It also presents the obstacles facing companies that undertake projects involving large information technology projects. Bombardier and Its Environment Joseph-Armand Bombardier was 15 years old when he built his first snowmobile...
