Question

Hello,

I need to see the solution, how they got these numbers? Will appreciate help. The Action Toy Company has decided to manufacture a new train set, the production of which is broken into six steps. The dema

0 0
Add a comment Improve this question Transcribed image text
Answer #1

Please refer to the solution below.

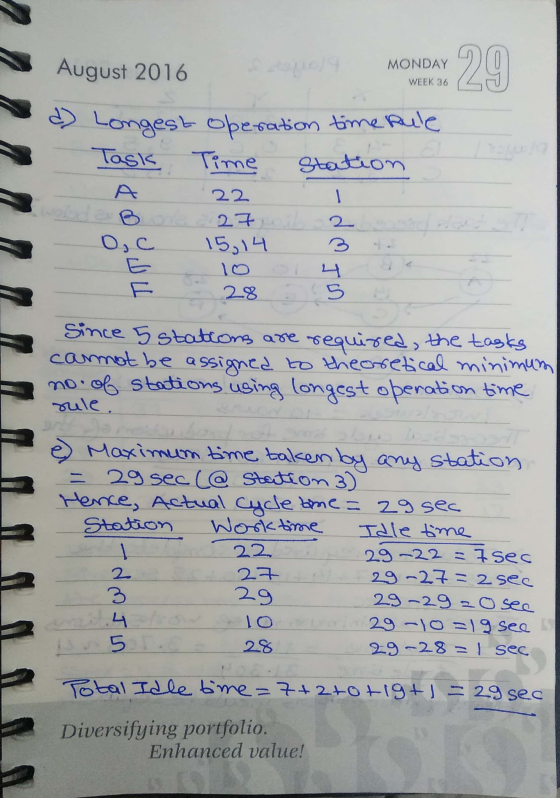

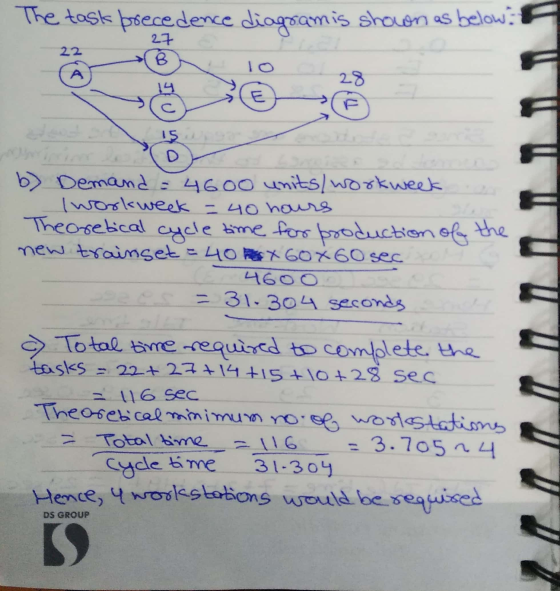

The task precedence diagramis shown as below: 27 22 28 Is lo b) Demand = 4600 units/workweek workweek = 40 hours TheoreticalSATURDAY WEEK 35 27 August 2016 f) Efficiency of assembly line with 5 workstations I- Idletime =1-29 Total time L16 75 28 SUN
