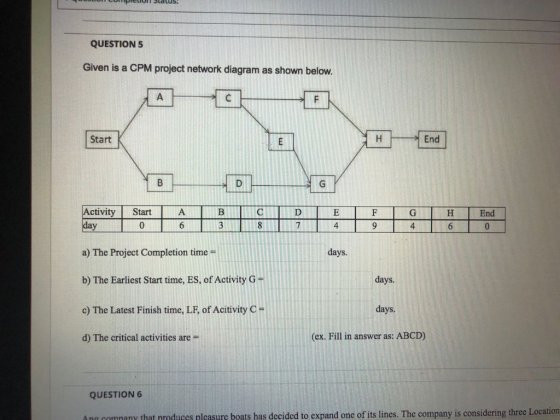

a) The project will flow from and get completed along either the path A-C-F-H or A-C-E-G-H or B-D-G-H.
Now time along A-C-F-H = 6 + 8 + 9 +6 = 29 days
Time along A-C-E-G-H = 6 + 8 + 4 + 4 + 6 = 28 days
Time along B-D-G-H = 3 + 7 + 4 + 6 = 20 days.
Since the longest time is along A-C-F-H, it is the critical path and the project completion time is 29 days.
b) Earliest start time of activity G = maximum of (earliest finish of E or D).
Now, earliest finish of activity E = 6 + 8 + 4 = 18 days
And, earliest finish of activity D = 3 + 7 = 10 days
Hence, Earliest start time, ES of activity G = 18 days
c) Latest finish of activity C = minimum of (latest start of E or F).
Now latest start of F = Project completion time - Duration of activity H - Duration of activity F
= 29 - 6 - 9 = 14 days
And, latest start of E = Project completion time - Duration of activity H - Duration of activity G - Duration of activity E
= 29 - 6 - 4 - 4 = 15 days
Hence, Latest finish time, LF of activity C = 14 days
d) The critical activities are ACFH, along the critical path.
QUESTION 5 Given is a CPM project network diagram as shown below. А C F Start...
