I need help with the attached assignment. I attached the question and completed assigment. I just need help with answering one more question which is which is:
Discuss a strategy that you would use to communicate the status of the project to stakeholders?





To communicate the status of the project to the stake holders, the best strategy is visual communication. Visual communication means conveying messages and updating through webpages, signs and illustrations. For example, social media post. This technqiue is applicable when the number of stake holders are high. If the number of stake holders are few, verbal communication strategies such as meetings and phone calls can be used.
I need help with the attached assignment. I attached the question and completed assigment. I just...

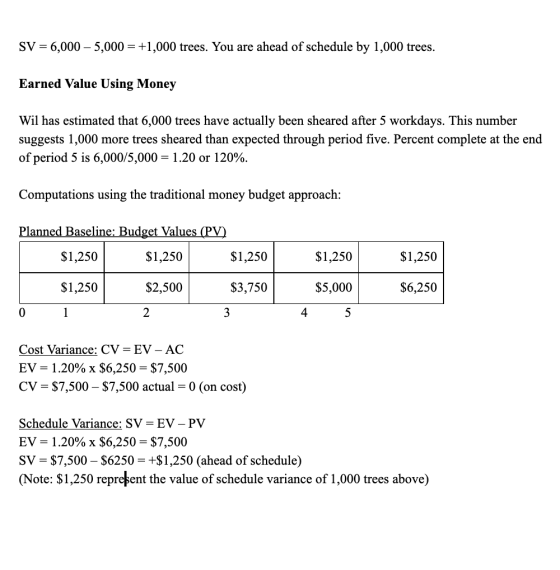

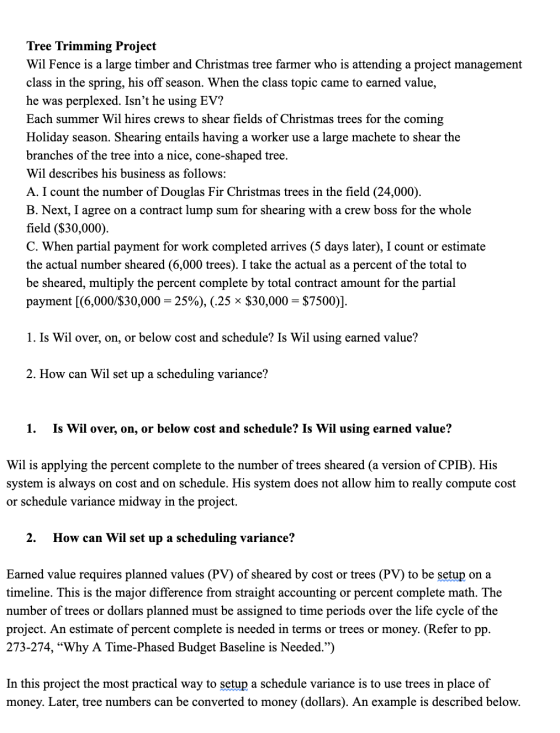

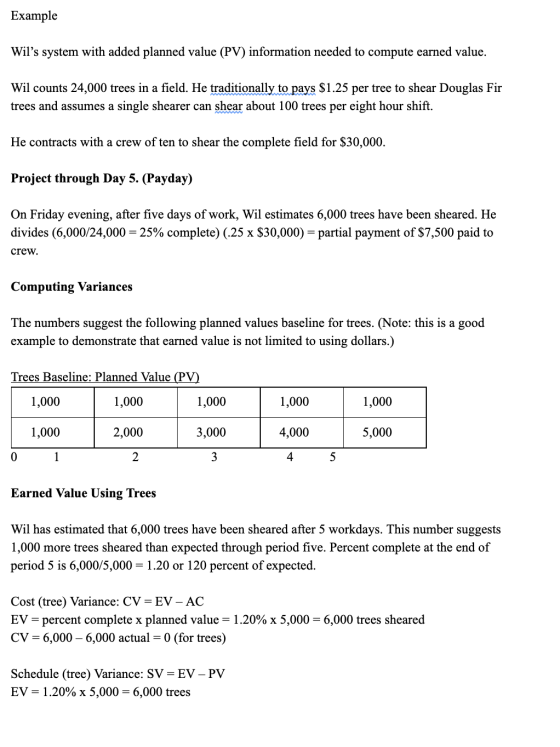

Complete the following items for this assignment: 1. Read through the Case 13.1 Tree Trimming Project Case in Larson and Gray. Respond to Questions 1 and 2 of the case. Use Microsoft Excel to complete this item and include all calculations in your Excel file. Note that showing all calculations in Excel is required. 2. Complete Appendix Exercise 2 at end of Chapter 13 in Larson and Gray. Specifically, complete the table on pp. 509-510 in the textbook (note th...
please a clear and understandable answer , i posted this
question before and no one answered yet !!!
Suppose a project X is half completed by the end of first month. Upto this duration the rate of performance is 50 percent. Complete the below table by using given values and explain about the budget and schedule on the basis of calculations. Earned value calculations for project X after 1 month are as follows: PV-8000 SR AC-20000 SR RP=50% Project X...
Project ABC Scope = 10 chairs @ $10.00 = $100.00 PV = Timeframe = 10 days AC = At the End of the 5th day 4 chairs were EV = Completed at a cost of $11.00 each CV = CPI= SV = SPI= CR = To install a 10,000 feet fence at a cost of $10.00/per foot. It is estimated that 500 feet of fence can be installed per week for a total of 20 weeks. After 12 weeks and...
Complete the following exercises and submit them in a word document (10 points). Project ABC Scope = 10 chairs @ $10.00 = $100.00 PV = Timeframe = 10 days At the End of the 5th day 4 chairs were EV = Completed at a cost of $11.00 each CPLE SV = SPIE To install a 10,000 feet fence at a cost of $10.00/per foot. It is estimated that 500 feet of fence can be installed per week for a total...
Remaining Time: 57 minutes, 05 seconds Less than half of the team Question Comeletion Status Question 10 Save A You have a project to be completed in 12 months. The budget for the project is 100.000 USD. Six months have passed, and 60.000 USD has been spent. On closer review, you find that only 40% of the work has become to date. Based on these figures, answer the following questions to receive full grade you must show your work 1....
At week 10 of a project below to improve distance learning platform, assume that the planned values (PV) are based on time proportionality but the “% Complete” values for earned values (EV) are from the workers actually doing the tasks. ACTIVITY PRE- DECESSORS DURATION (WEEKS) BUDGET ($) ACTUAL COST ($) % COMPLETE A - 5 500 640 100 B A 3 300 400 100 C B 4 320 310 80 D B 6 600 250 60 E C,D 3 300...
3) You are in charge of the Aurora Project. Given the following project network, baseline, and status information, (40 Points) B DI OA E • Develop status reports for periods 7 and complete the performance indices table. . Calculate the EAC, and VAC. Based on your data, what is the current status of the project? At completion? Rule 1 0% complete 2-50/50 3 - 0/100 ID LF SL Schedule information Total 0 1 2 PV 3 4 30 5 6...
2. You are 4.5 months into a 6-month, $12,000 project with a planned linear spend rate. You have an earned value of $8,500 and you have spent $10,000. What is your EAC? (2 points) 3. The earned value on your project is $15,000, the planned value is $20,000, and the actual cost is $18,000. What is your current schedule variance (in $)? (1 point) 5. You are working on a large project and have determined that your cost variance is...
Given the project network and baseline information below, complete the form to develop a status report for the project at the end of period 4 and the end of period 8 LEGEND ES | ID | EF SL LS DUR LF SL 8 D 12 0 8412 0 0 0 2 6 8 12 F15 0 12 315 0 0 0 7 E 10 2 93 12 2 4 5 9 Time Period Task LF DUR ES SL Budget (PV)...
Question 1: The following data and table illustrate a small project: Activity A was completed on schedule • Activity B started as planned but it is expected to take four weeks more Activity C started as planned but finished one week later • %age of completion of activity D is 60% ACWP at the end of week 10 = SR 90400 Activity Original Planned Start Time Original Planned Finish Time Wage Complete Amount Completed BCWP Amount Scheduled BCWS Amount Spent...
