Question

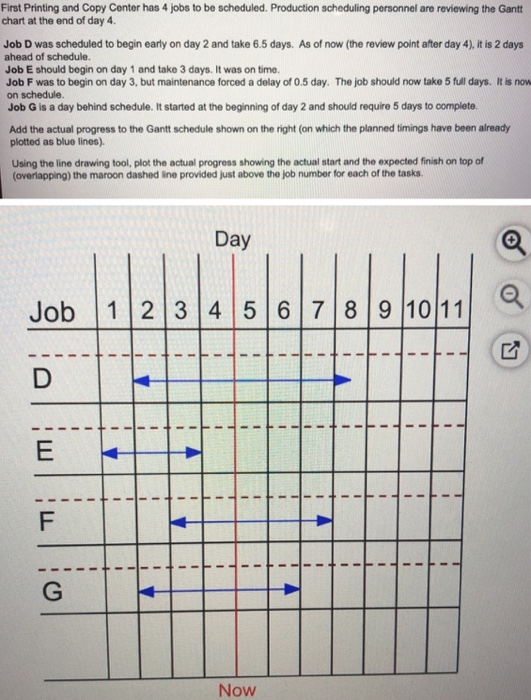

First Printing and Copy Center has 4 jobs to be scheduled. Production scheduling personnel are reviewing the Gantt chart at t
0 0
Add a comment Improve this question Transcribed image text
Answer #1

Given and inference is as follows,

Activity Inference Completion
Job D 2 day ahead o schedule, 1 day early started; scheduled completion reduces to 5.5 4/5.5 days
Job E No Comments 100%
Job F dealy of 0.5 day 1.5/5 days
Job G 1 day delay 2/5 days

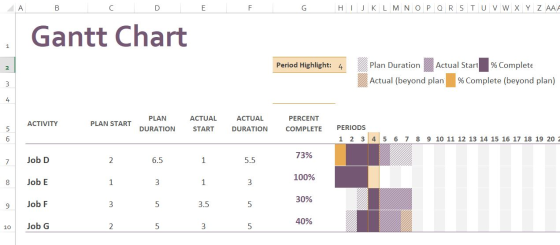

Updated Gantt Chart is as follows,

A B C D E F G H I J K L M N O P Q R S T U V W X Y Z AAA Gantt Chart 1 Period Highlight: 4 2. Plan Duration Actual Start % Com

Note: 0.5 day tolerance can’t be accumulated in excel cell. It is advised to refer ‘Work Completion Column’ for Job completion of D & F.

If you like the answer please give an up-vote, this will be quite encouraging for me, thank you.

If you have further suggestions in answer, please write below on the comment section, I will certainly look into it.
