(a)

.
(b)

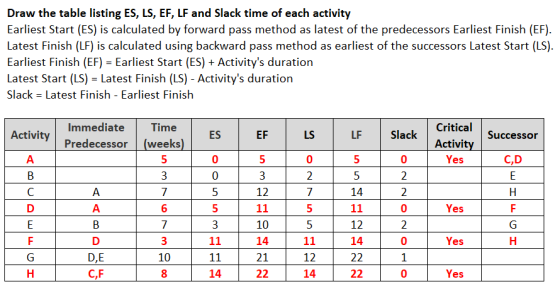

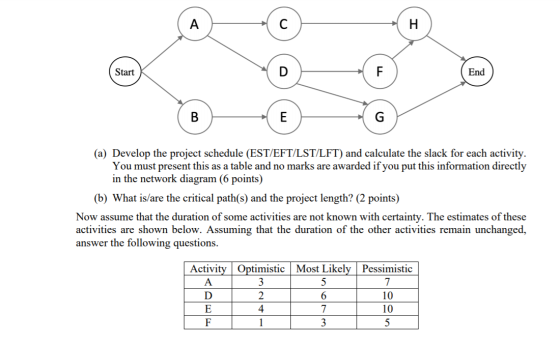

Critical path is the longest path in the network. All the activities on critical path have 0 slack.
Critical path is: A-D-F-H
Project length = Length of critical path = 5+6+3+8 = 22 weeks
.
(c)
For each activity, calculate the expected time, te =(optimistic + 4 * most likely + pessimistic)/6
Variance = (pessimistic - Optimistic)2/36
| Activity | Predecessor | Optimistic | Most likely | Pessimistic | Expected Time, te | Variance (σ2) |
| A | 3 | 5 | 7 | 5 | 0.44 | |
| B | 3 | 3 | 3 | 3 | 0 | |
| C | A | 7 | 7 | 7 | 7 | 0 |
| D | A | 2 | 6 | 10 | 6 | 1.78 |
| E | B | 4 | 7 | 10 | 7 | 1 |
| F | D | 1 | 3 | 5 | 3 | 0.44 |
| G | D,E | 10 | 10 | 10 | 10 | 0 |
| H | C,F | 8 | 8 | 8 | 8 | 0 |
We see that expected time remain same as deterministic time.
Project's expected completion time = 5+6+3+8 = 22
Critical path remains same, i.e. A-D-F-H
Project variance = SUM of variances of critical activities
= 0.44+1.78+0.44+0
= 2.67
.
Standard deviation = square root of variance
= sqrt(2.67)
= 1.63
Deadline = 25 weeks
z value = (25-22)/1.63
= 1.84
P(z) = NORMSDIST(1.84)
= 0.97
Probability of team failing to meet the deadline = 1 - P(z)
= 1 - 0.97
= 0.03
or, 3 %
.

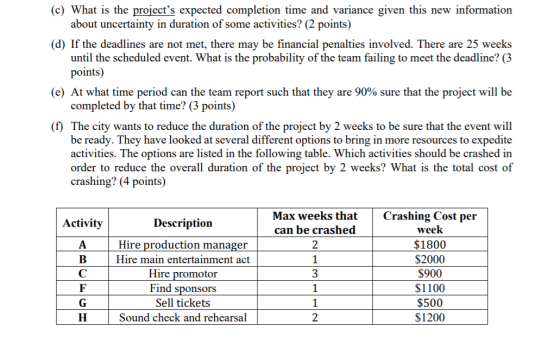

(e)
For 90%, z value = NORMSINV(0.90)
= 1.28
Completion time = 22 + 1.28*1.63
= 24 weeks

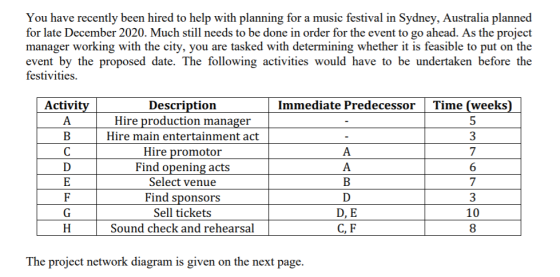

You have recently been hired to help with planning for a music festival in Sydney, Australia...
