Question

You have recently been hired to help with planning for a music festival in Sydney, Australia planned for late December 2020.

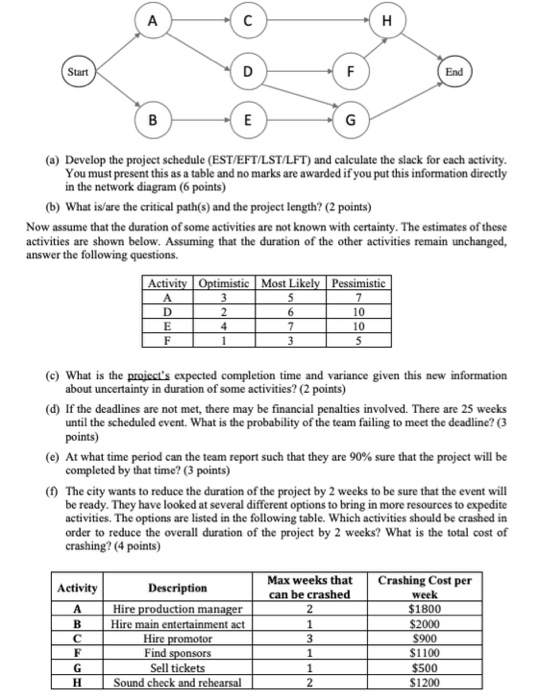

A с H Start D F End B E G (a) Develop the project schedule (EST/EFT/LST/LFT) and calculate the slack for each activity. You m
0 0
Add a comment Improve this question Transcribed image text
Answer #1

Answer a=

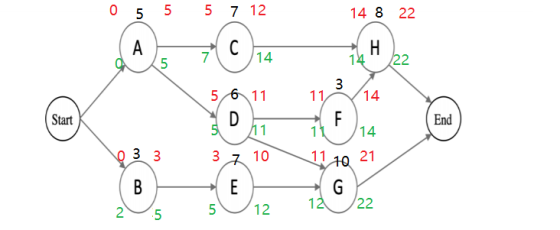

0 5 5 5 7 12 14 8 22 A C H 5 7 14 14 22 3 11 14 5 6 11 D 111 Start F End 5 14 0 3 3 3 7 10 11 10 21 B E G 12 22 2 12 ол 5

Activity ES EF LS LF Slack
A 0 5 0 5 5-5=0
B 0 3 2 5 5-3=2
C 5 12 7 14 14-12=2
D 5 11 5 11 11-11=0
E 3 10 5 12 12-10=2
F 11 14 11 14 14-14=0
G 11 21 12 22 22-21=1
H 14 22 14 22 22-22=0

Answer B= Critical path = activity with zero slack

Critical path =A-D-F-H

Project duration =5+6+3+8=22

Answer c=

Activity O M P Duration Duration Variance Variance
A 3 5 7 (3+4*5+7)/6 5 ((7-3)/6))^2 0.44
D 2 6 10 (2+4*6+10)/6 6 ((10-2)/6))^2 1.78
E 4 7 10 (4+4*7+10)/6 7 ((10-4)/6))^2 1
F 1 3 5 (1+4*3+5)/6 3 ((5-1)/6))^2 0.44

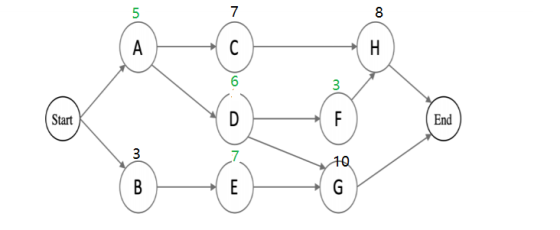

5 7 8 A C H 6 3 Start D F End 3 10 B E G

The new project duration= B-E-G=3+7+10=20

Variance =1
