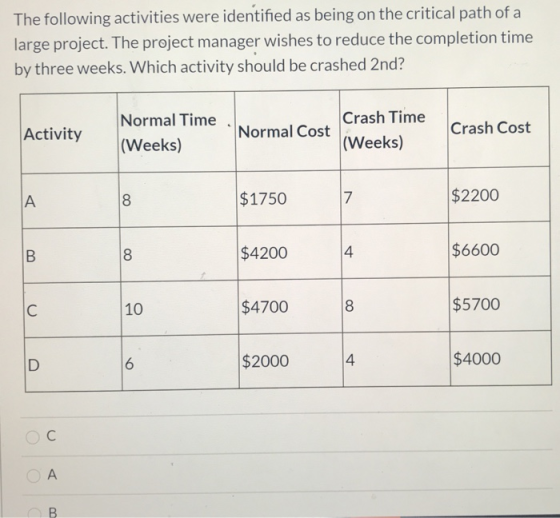

Question

The following activities were identified as being on the critical path of a large project. The project manager wishes to redu

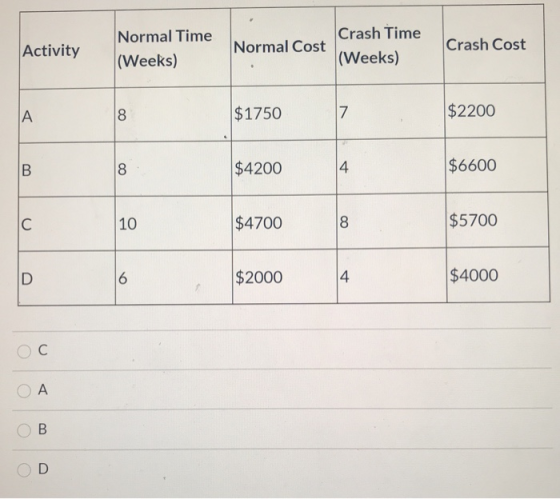

Activity Normal Time (Weeks) Crash Time Normal Cost (Weeks) Crash Cost A 8 $1750 7 $2200 B 8 $4200 4 $6600 IC 10 $4700 8 $570
0 0
Add a comment Improve this question Transcribed image text
Answer #1
Activity Normal Time (Weeks)
(a)
Normal Cost
(b)
Crash Time (Weeks)
(c)
Crash Cost
(d)
Crash Limit
(a-c)
Total Crash Cost
(d-b)
Crash Cost Per Week
A 8 $1,750 7 $2,200 1 $450 $450
B 8 $4,200 4 $6,600 4 $2,400 $600
C 10 $4,700 8 $5,700 2 $1,000 $500
D 6 $2,000 4 $4,000 2 $2,000 $1,000

First - Activity A since crash cost per week is the lowest ($450)

Second - Activity C since crash cost per week is the second lowest ($500)

Third - Activity C since crash cost per week is the second lowest ($500) and there is still limit left
