Question

Lecture Exercise #13 Project Crashing Activity Predecessor(s) Time (weeks) Normal Crash 3 2 A None None None B Cost Normal Cr
0 0
Add a comment Improve this question Transcribed image text
Answer #1

Answer: Normal project completion time = 14 weeks

Critical Path = A - D - G

Crash Activity D.

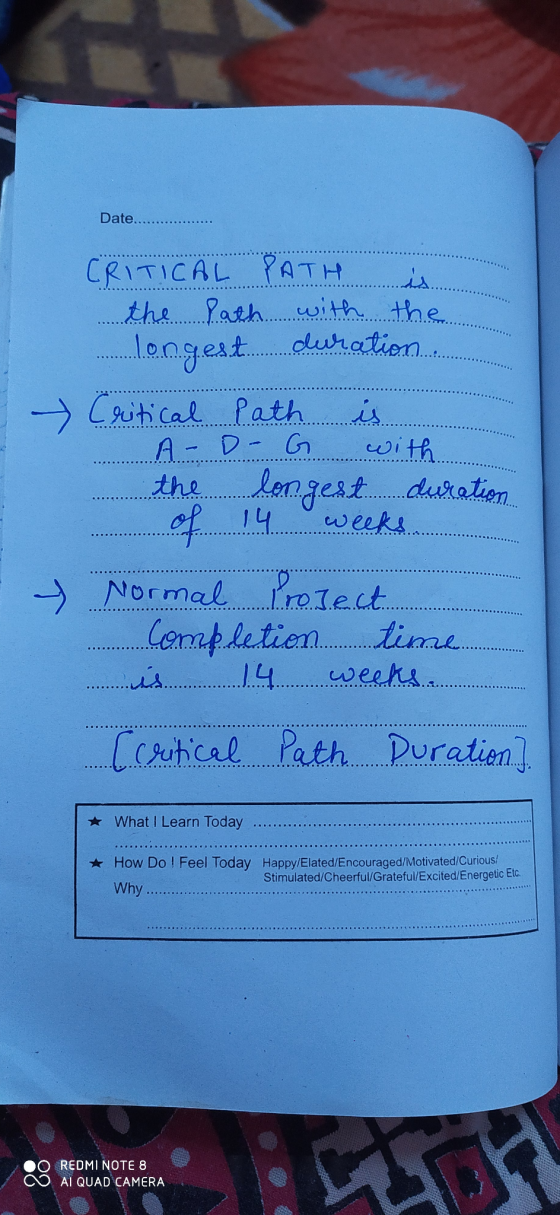

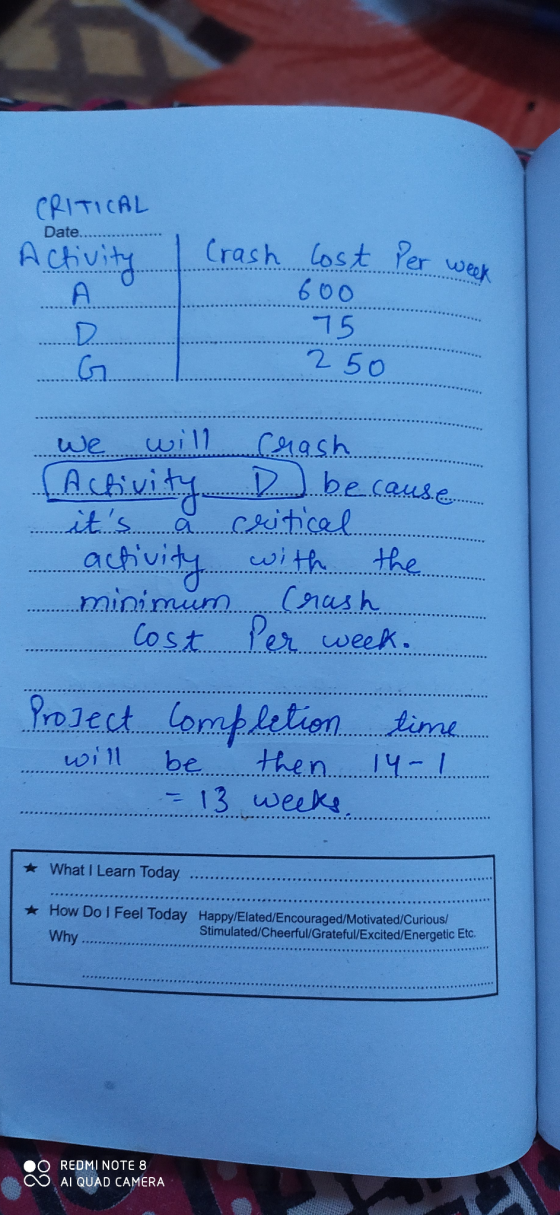

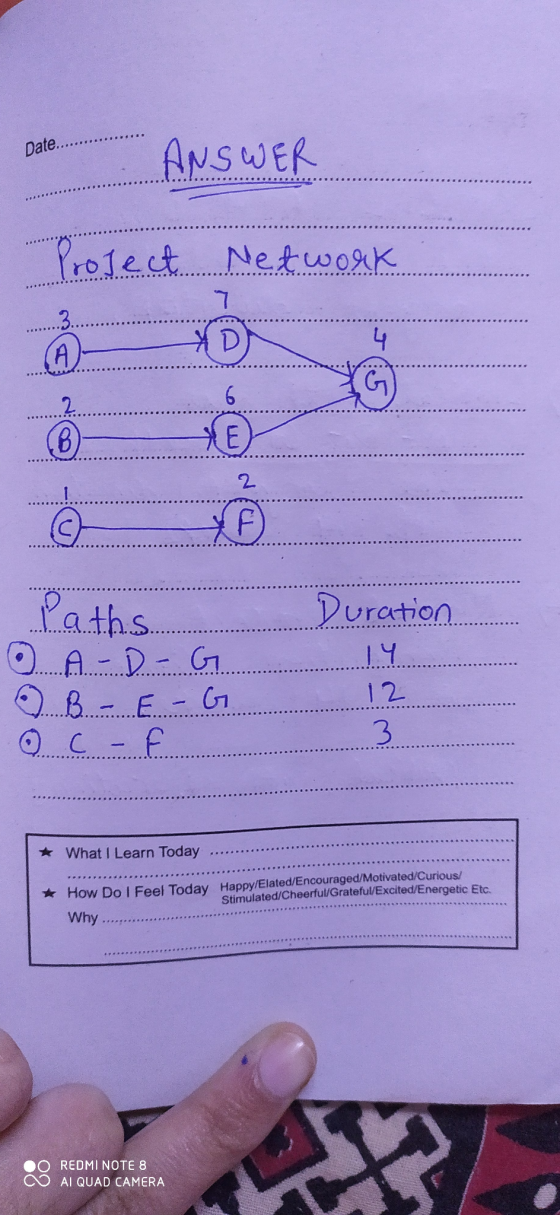

Date.... ANSWER Project Network 7 3. (A D 4 6 G B E 2 © Paths... Duration O A-D-G. B. - E. E-G C f 12 3 * What I Learn TodayDate... CRITICAL PATH is. the Path with the ...ongest duration Critical Path is A-D- G the longest duration weeks with of 14Date. you want to the Project by shorten I week, Crash the... which has. Crash Cost per you should activity least... week. ·Crash Cost per week Date.. CRITICAL Activity 75 D. G 250 will crash A.chivity... because its. a critical activity with the m
