Question

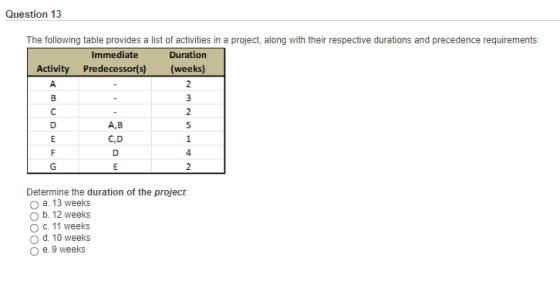

Question 13 The following table provides a list of activities in a project, along with their respective durations and precedeQuestion 14 Assume that activity F has the following times: Early start time (ES) = 7 days Early finish time (EF) = 12 days L

0 0
Add a comment Improve this question Transcribed image text
Answer #1

13) Using given becomes: data, activity activity on node (RON) diagram 5 © - Start End 2 B E Peth Total time 2+5+4= Il ADF AD

Add a comment
Know the answer?
Add Answer to:
Question 13 The following table provides a list of activities in a project, along with their...
Your Answer:

Post as a guest

Your Name:

What's your source?

Earn Coins

Coins can be redeemed for fabulous gifts.

Not the answer you're looking for? Ask your own homework help question. Our experts will answer your question WITHIN MINUTES for Free.
Similar Homework Help Questions
  • A Question 11 The following table provides a list of activities in a project, along with...

    A Question 11 The following table provides a list of activities in a project, along with their respective durations and precedence requirements: Immediate Duration Activity Predecessor(s) (weeks) 2 B 3 C B D А E A.C 1 F DE 3 с 3 2 6 G Determine the amount of slack time for Activity E: a. O weeks b. 1 week C. 2 weeks O d. 3 weeks Question 12 Assume that activity A has the following times: Early start time...

  • Question 14 Assume that activity F has the following times: Early start time (ES) = 7...

    Question 14 Assume that activity F has the following times: Early start time (ES) = 7 days Early finish time (EF) = 12 days Latest start time (LS) = 15 days Latest finish time (LF) = 20 days If disaster strikes and activity F will take 20 days to complete rather than the original activity duration (assume that it started at the ES time), by how long will the completion of the project be delayed? O a. 20 days b....

  • The following table provides a list of activities in a project, along with their respective durations...

    The following table provides a list of activities in a project, along with their respective durations and precedence requirements: Immediate Duration Activity Predecessor(s) (weeks) A 2 3 2 B с D E F 4 A B B с DE E 1 3 G 2 Determine the amount of slack time for Activity E Ola. O weeks b. 1 week c. 2 weeks d. 3 weeks

  • Consider a project having the following six activities:

    Consider a project having the following six activities:                                                      Immediate                                                  Max        Crash cost             Activity                           Predecessors           Time (weeks)             Crash*    per week                   A                                none                                    6                          6                N/A                   B                                none                                    5                          2               $500                   C                                A                                       3                          2             $1000                   D                                A, B                                    4                          2             $2000                   E                                 C, D                                    5                          2             $1250                   F                                D                                       6                          2             $1000                                                                                                 *Shortest possible time for the task 1. Draw the project network and list...

  • Consider a project having the following six activities:

    Consider a project having the following six activities:                                                      Immediate                                                  Max            Crash cost             Activity                           Predecessors          Time (weeks)             Crash*    per week                   A                                none                                    7                          7         N/A                   B                                none                                    3                          2        $500                   C                                A                                       5                          3      $1000                   D                                A, B                                    6                          4      $2000                   E                                 C, D                                    4                          3      $1250                   F                                D                                       3                          2      $1000                                                                                                 *Shortest possible time for the task 1. Draw the project network and list...

  • Consider the following project activities: Calculate the expected time (te) for each activity. Draw an Activity...

    Consider the following project activities: Calculate the expected time (te) for each activity. Draw an Activity on Node (AON) diagram to reflect the flow of these activities. Calculate the Early Start (ES), Early Finish (EF), Late Start (LS), and Late Finish (LF) for each activity. Calculate the slack for each activity. Identify all activities on the Critical Path. Use the data to calculate the probability the project will finish in 20 weeks (Hint: z-score). Activity A 8 с D E...

  • The ABC Manufacturing Co. has made a decision to replace an existing production line with new...

    The ABC Manufacturing Co. has made a decision to replace an existing production line with new equipment. This project will require several tasks (jobs) with precedence relationships and duration (days) as shown in the following table. The project will be finished when activities A-J are all finished. Activity predecessor Optimistic Most likely Pessimistic Expected A - 4 5 12 B A 3 4.5 15 C A 2 3 4 D C 6 8 22 E B 4 6 8 F...

  • A construction company has a project proposal, which takes 10 activities as follows: Activity Predecessors Activity...

    A construction company has a project proposal, which takes 10 activities as follows: Activity Predecessors Activity Duration Time (In DAYS ) Early Start (ES) (In DAYS ) Early Finish (EF) (In DAYS ) Late Start (LS) (In DAYS ) Late Finish (LF) (In DAYS ) SLACK (In DAYS ) A - 14 B - 13 C A 11 D A 15 E B 14 F B 11 G D, E 13 H F 15 J C 12 K G,H 11...

  • 4. A project manager calculated early and late start and finish times for all activities in...

    4. A project manager calculated early and late start and finish times for all activities in her eight-activity project but spilled her energy drink on the paper and the acid in the beverage wiped out some of the table entries. The remaining legible entries are correct. Activity Predecessor Duration ES EF LS LF Slack A -- B A 12 12 C A 5 18 D B 8 E C 9 0 F D,E 27 34 0 G E 6 33...

  • also needs daves latest start and latest finish: Dave Fletcher was able to determine the activity...

    also needs daves latest start and latest finish: Dave Fletcher was able to determine the activity times for constructing his laser scanning machine. Fletcher would like to determine ES, EF, LS, LF, and slack for e activity. The total project completion time and the critical path should also be determined. Here are the activity times: Activity Time (weeks) Immediate Predecessor(s) Activity Time (weeks) Immediate Predecessor(s) C, E D, F Dave's earliest start (ES) and earliest finish (EF) are: Activity ES...
