Question
only number 3

Southwestern University South Day Sweate AL One of m demanding Wha wad. With dance. WU to face the head on. Althoch alarm wi

3

Southwester University: (A)* Southwestern University (SWU), a large state college in Stephenville, Texas, 30 miles southwest
20 30 H 2.000 20 25 60 2.000 Hardware/AC/metal workings Tile carpet/windows Inspection Final detail work/cleanup H 8 10 K 12
0 0
Add a comment Improve this question Transcribed image text
Answer #1

1)

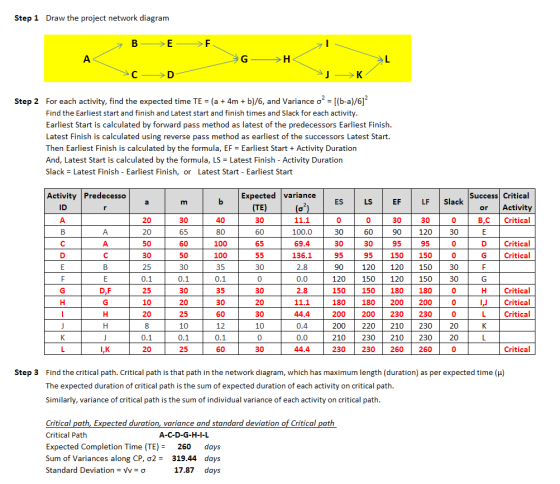

Step 1 Draw the project network diagram B >E —> F A G >H L C->D J -> Step 2 For each activity, find the expected time TE = (a

-----------------------------------------------

2)

For target time of 265 days, z value = (265-260)/17.87 = 0.28

P(z) = NORMSDIST(0.28) = 0.61

Probability of completing the project in less than 265 days = 0.61 or 61 %

-----------------------------------------------

3)

There are four paths in the network.

These paths and their respective duration are listed below:

Path Duration
A-B-E-F-G-H-I-L 230.1
A-B-E-F-G-H-J-K-L 210.2
A-C-D-G-H-I-L 260
A-C-D-G-H-J-K-L 240.1

Activity A is on critical path and has the lowest crash cost/day.

Crash time of activity A = 30-20 = 10 days, So, activity A is crashed by 10 days at a cost of $ 1500 per day

Activity D on critical path has the next lowest crash cost/day. Crash time of activity D = 55-30 = 25 days. So, activity D is crashed by 25 days at a cost of $ 1900 per day

Now, the project duration has been shortened by 10+25 = 35 days

Activity H or I has the next lowest crash cost/day. So, either of these activities is crashed by 5 days.

Let's say activity H is crashed by 5 days at a cost of $ 2000 per day

Summary: Activity A, D and H needs to be crashed by 10, 25 and 5 days respectively.

Project duration after crashing = 220 days

Total crash cost = 1500*10+1900*25+2000*5 = $ 72,500

Total savings in penalty = 10000*40 = $ 400,000
