Question
#1

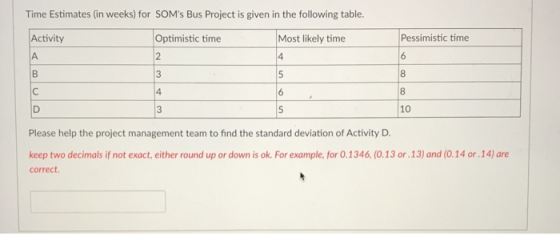

Time Estimates (in weeks) for SOMs Bus Project is given in the following table. Activity Optimistic time Most likely time Pe
#2

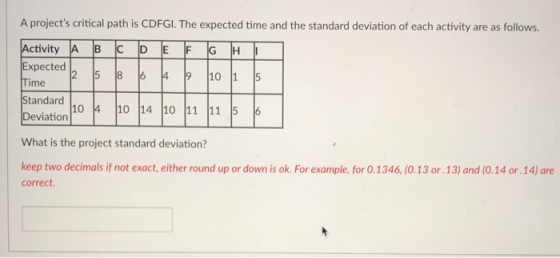

A projects critical path is CDFGI. The expected time and the standard deviation of each activity are as follows. Activity AB
#3

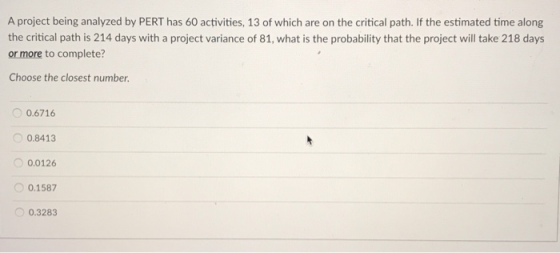

A project being analyzed by PERT has 60 activities, 13 of which are on the critical path. If the estimated time along the cri
#4
A project being analyzed by PERT has 60 activities, 13 of which are on the critical path. If the estimated time along the cri
0 0
Add a comment Improve this question Transcribed image text
Answer #1

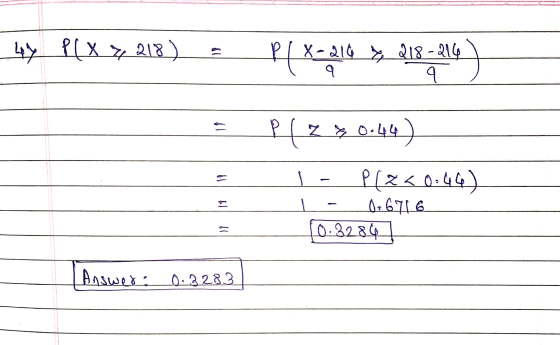

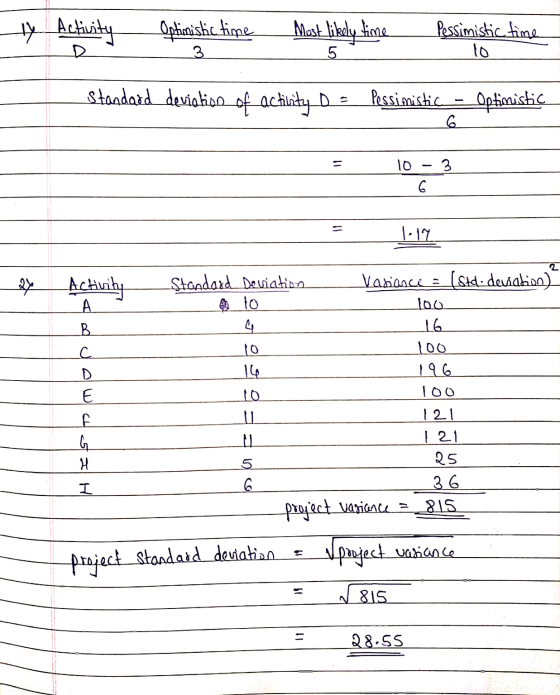

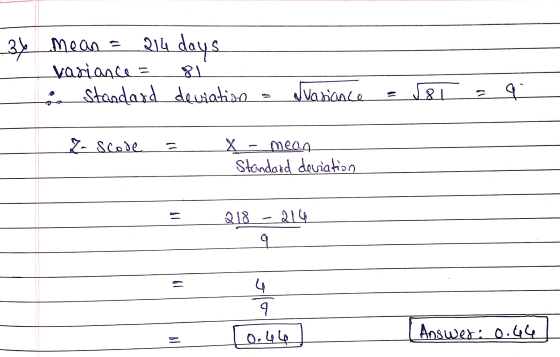

у Activity Optimistic time Most likely time Pessimistic time 3 5 To Standard deviation of activity Ds Pessimistic 6 Optimisti3% means 214 days variances 81 standard deviation = variance 581 q 7- Scode X - mean Standard deviation 11 Q18 - 214 4 9 0.464) १[x 218) P( P/X-21, 218 - 214 १ १ । - P (7 * 0.५५) P[2< 0.५५) 046716 0.3284 - Answer : 0.3283 :
