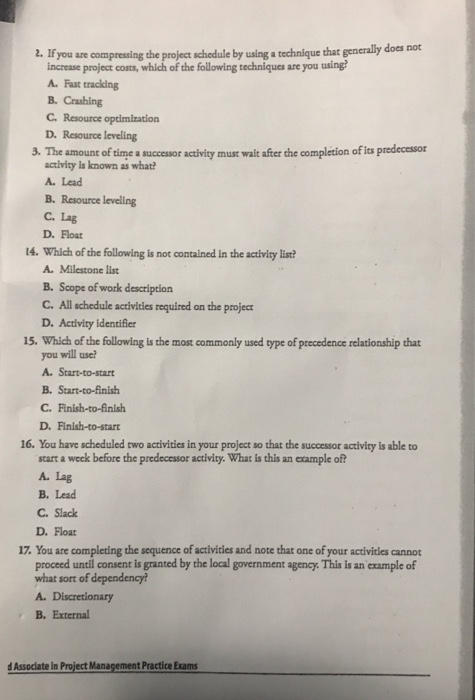

2) C
It is the resource optimization scenario so as to compress the schedule
3) D
It is also called as Slack
14) A
The milestone list is the part of project schedule and not included in activity list
15) D
Finish to Start is the common relationship as it is used in case of dependencies
post the answers for the following Mcq's. NOTE: FYI - 17th question has 4 option in...
1. Consider the following project. Activity Duration (weeks)5 Immediate Predecessor(s) Cost (S) 1000 | 400 I 200 | 1200 | 500 | 700 | 1200 | 800 | 1800 | 1500 | 400 (a) Construct the activity-on-node (AoN) network for the relations among the activities in the (b) Using the activity-on-node (Ao) network developed in part (a), determine the critical path and the minimum time required to complete the project. Develop the earliest start and finish times, the latest finish...
Assignment for week 5Given the following information, draw the project network. Compute the early, late and slack times for the project network. which activities are on the critical path have only the start or finish of the activity on the critical path?ID duration finish to start finish to start additional lag lag predecessor lag Relationship A 2 none 0 none 0B 4 A 0 none 0C 6 A 0 finish-finish C to F 7D 8 A 0 none 0E 18...
Case-2 Consider that you have an interview in a construction firm and they asked you to develop an (AOA) network for a construction project has the following activities along with their relationships. Draw your suggested network. (15 Marks) (The project was started in activity A and it is the precedence of activities B,C,D &E, the activity B is followed by activity F, while the activity C was followed by activity G, the activity K was not start until the activities...
26.According to the DISC acronym, _____ relates to control, power, and assertiveness. independence steadiness influence dominance competence 28.Which of the following is an example of asynchronous communications? Texting Mail and package delivery Instant messaging Computer-assisted conference Audio conference 33.Which of the following is an example of synchronous communications? Web log Fax Computer-assisted conference Mail and package delivery Electronic mail 36.A table reflecting Communication Escalation will contain information about all of the following EXCEPT: Priority Definitions Decision Authority Timeframe for Notification...
QUESTION 1 Your company is planning to implement a construction project in a nearby town. You have identified ten (10) activities and their relationship to be carried out in order to complete the project. Table 1 and Figure 1 below show the relationship and the critical path diagram for the project. The duration to complete each activity (days) is stated below the activity. The relationship between activities is 'finish-start with no lag except for the following activities. Table 1: Relationship...
Consider the following set of activities: Time Predecessor Activity Required Activities A 5 None B 4 A C 5 B D 8 B E 9 C F 6 C,D G 8 D H 3 E,F,G a. Draw the CPM network for this problem. b. Calculate and summarize the earliest and latest start and finish times, the slack for each activity, and the critical activities. c. What is the earliest time that the project can be completed? d. If the project needed to be completed...
17. The types of float in a CPM schedule are a. free Float b. negative Float c. total Float d. independent Float e. all of the above 18. A loop in the schedule means a. circular logic between two activities b. two paths with the same logic c. duplicate activities d. negative float e. a and d 19. Constraints can be define as a. imposed restrictions applied to activities to reflect project requirements that cannot be built into the logic....
hi need answers for this urgently thanks
Question 2 (20 Marks) a) Given the following project details, identify the project's critical path; Activity Predecessor A B Duration (Man Days) 5 10 12 8 6 15 D Ε F B, C GE CD G H 20 18 30 5 I,J к F, L M (10 Marks) Continued... b) Given the information below, identify how much it would cost for each day you crash the schedule. Determine the total cost for crashing...
Consider the following project activities:
Calculate the expected time (te) for each
activity.
Draw an Activity on Node (AON) diagram to reflect the flow of
these activities.
Calculate the Early Start (ES), Early Finish (EF), Late Start
(LS), and Late Finish (LF) for each activity.
Calculate the slack for each activity.
Identify all activities on the Critical Path.
Use the data to calculate the probability the project will
finish in 20 weeks (Hint: z-score).
Activity A 8 с D E...
QUESTION 1 Please use the information below to draw and solve the network on a piece of paper by: Complete the forward and backward pass Identify the critical path Fill in the requested information (Example: ESA Early Start of Activity A; LFA Late Finish of Activity A, etc) Relationship Activity Contract sign Predecessor Activity ID Duration 3 А Survey В 2 А Target market C Data В,С D 7 collection Presentation 2 FS Lag 3 E В Analyze F 2...
