Consider the following set of activities:
| Time | Predecessor | |
| Activity | Required | Activities |
| A | 5 | None |
| B | 4 | A |
| C | 5 | B |
| D | 8 | B |
| E | 9 | C |
| F | 6 | C,D |
| G | 8 | D |
| H | 3 | E,F,G |

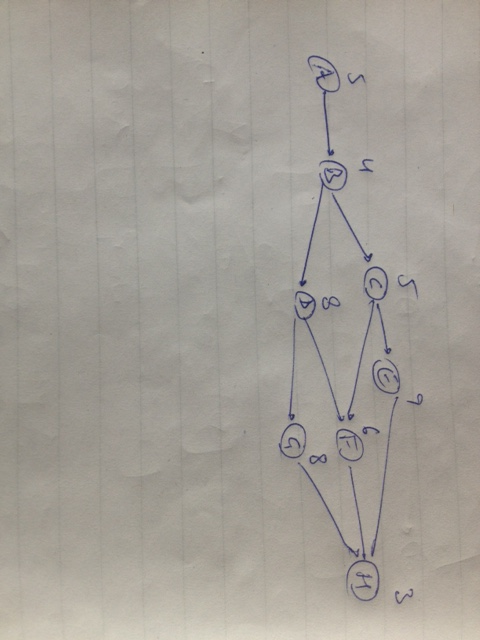

| a. Draw the CPM network for this problem. |
| b. Calculate and summarize the earliest and latest start and finish times, the slack for each activity, and the critical activities. |
| c. What is the earliest time that the project can be completed? |
| d. If the project needed to be completed two (Time) earlier, what would you recommend? |

| Activity | ||||||
| ES | EF | LS | LF | Slack | Critical | |
| A | 0 | 5 | 0 | 5 | 0 | Yes |
| B | 5 | 9 | 5 | 9 | 0 | Yes |
| C | 9 | 14 | 11 | 16 | 2 | No |
| D | 9 | 17 | 9 | 17 | 0 | Yes |
| E | 14 | 23 | 16 | 25 | 2 | No |
| F | 17 | 23 | 19 | 25 | 2 | No |
| G | 17 | 25 | 17 | 25 | 0 | Yes |
| H | 25 | 28 | 25 | 28 | 0 | Yes |
The earliest completion time is 28.
If the project needs to be completed 2 times earlier, the activity G should be crashed ( reduced for time) for 2 days.
