| 2016 | 2017 | 2018 | 2019 | |||
| Costs incurred to date | $120,250 | $507,000 | $840,000 | $1,090,000 | ||
| Est. cost to complete | $804,750 | $468,000 | $210,000 | $0 | ||
| Total estimated costs | $925,000 | $975,000 | $1,050,000 | $1,090,000 | ||
| Contarct Price | $1,200,000 | $1,200,000 | $1,200,000 | $1,200,000 | ||
| Expected gross profit | $275,000 | $225,000 | $150,000 | $110,000 | (Contract Price - total estimated cost) | |
| Percentage completed | 13% | 52% | 80% | 100% | Costs incurred to date / Est. total costs | |
| $35,750 | $117,000 | $120,000 | $110,000 | (Percentage competed x Expected gross profit) | ||
| Less: Profit/Loss Recognized earlier year | $0 | $35,750 | $117,000 | $120,000 | ||
| Gross Profit/(Loss) to recognize | $35,750 | $81,250 | $3,000 | -$10,000 | ||
| Accounts Title | Debit | Credit | ||||
| Work in Progress | $250,000 | |||||
| Accounts payable and others | $250,000 | |||||
| Accounts Receivable | $300,000 | |||||
| Billings | $300,000 | |||||
| Cash | $310,000 | |||||
| Accounts Receivable | $310,000 | |||||
| Billings | $1,200,000 | |||||
| Contruction Contracts Revenue | $1,200,000 | |||||
| Cost of construction | $1,090,000 | |||||
| Work in Progress | $1,090,000 | |||||

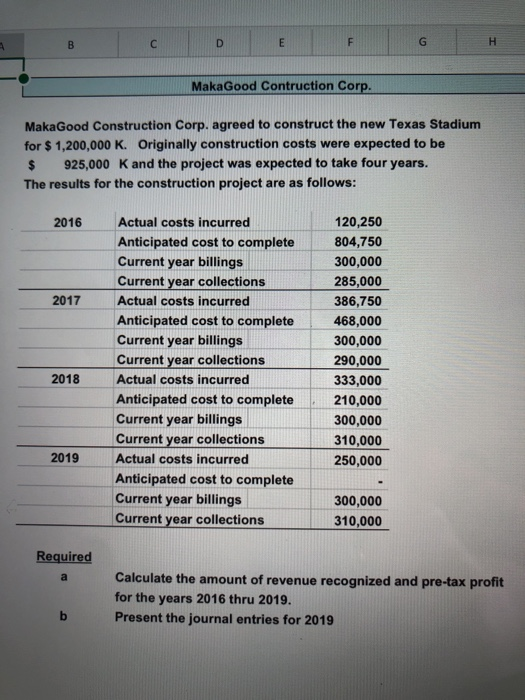

MakaGood Construction Corp. please show work or formulas. thanks B С D E F G H...
18.A construction company was hired on a construction project to build a building for $1,800,000. The project was begun in 2015 and completed in 2016. Cost and other data are presented below: 2015 2016 Costs incurred during the year $450,000 $1,100,000 Estimated costs to complete 1,050,000 0 Billing during the year 400,000 1,400,000 Cash collections during the year 300,000 1,500,000 Assume that A recognizes revenue on this contract over time according to percentage of completion. Required: Prepare all journal entries...
B30 - x fx С D E F G 9 B 1 On January 1, 2020, Construction Co. enters into a contract with Trump Co. to build a new high-rise 2 building for $10,000,000. The contract allows Construction Co. to make monthly progress billings as 3 work progresses on the projects. Following is information on the contract for 2020. 4 2020 5 Construction costs incurred during the year $3,000,000 6 Construction costs incurred in prior years So 7 Cumulative construction...
Davis Construction company was a low bidder on a construction
project to build and earthen dam for $2,000,000. The project was
begun in 2017. Cost and other are presented bellow.
2017 2018
Costs incurred during the year $450,000 $1,100,000
Total costs 1,050,000 50,000
Percentage of completion 30% 96.875%
Billings during the year 500,000 1,400,000
Cash collections during the year 400,000 1,400,000
Assume the Beavis recognizes revenue on the contract over time
according to percentage of completion
Required
1. Compute the...
Beavis Construction Company was the low bidder on a construction project to build an earthen dam for $1,800,000. The project was begun in 2017 and completed in 2018. Cost and other data are presented below. $ Costs incurred during the year Estimated costs to complete Billings during the year Cash collections during the year 2017 2018 450,000 $1,100,000 1,050,000 400,000 1,400,000 300,000 1,500,000 Assume that Beavis recognizes revenue upon completion of the project. Required: Compute the amount of gross profit...
MSK Construction Company contracted to construct a factory building for $525,000. Construction started during 2019 and was completed in 2020. Information relating to the contract follows 2019 $290,000 145,000 260,000 240,000 2020 Costs incurred during the year Estimated additional cost to complete Billings during the year Cash collections during the year $150,000 265,000 285,000 Required 1. Record the preceding transactions in MSK's books assuming it recognizes revenue over time and uses costs incurred to measure the extent to which its...
B12 fx D E F А Assume Nortel Networks contracted to provide a customer with Internet infrastructure for $2,300,000 The project began in 2021 and was completed in 2022. Data relating to the contract are summarized below: 2021 $324,000 $1,296,000 $410,000 $310,000 2022 $1,800,000 SO $1,680,000 $1,780,000 2021 2022 1 2 3 Costs incurred during the year 4 Estimated cost to complete as of 12/31 5 Billings during the year 6 Cash collections during the year 7 Requirement 1: Complete...
In 2018, the Westgate Construction Company entered into a contract to construct a road for Santa Clara County for $10,000,000. The road was completed in 2020. Information related to the contract is as follows: 2020 $2,008,600 Cost incurred during the year Estimated costs to complete as of year-end Billings during the year Cash collections during the year 2018 $2,490,000 5,810,000 2,030,000 1,815,000 2019 $3,984,000 1,826,000 4,444,000 3,900,000 3,526,000 4,285,000 Westgate recognizes revenue over time according to percentage of completion. 3....
In 2018, the Westgate Construction Company entered into a contract to construct a road for Santa Clara County for $10,000,000. The road was completed in 2020. Information related to the contract is as follows: 2018 2019 2020 Cost incurred during the year $ 2,490,000 $ 3,984,000 $ 2,008,600 Estimated costs to complete as of year-end 5,810,000 1,826,000 0 Billings during the year 2,030,000 4,444,000 3,526,000 Cash collections during the year 1,815,000 3,900,000 4,285,000 Westgate recognizes revenue over time according to...
On February 1, 2018, Arrow Construction Company entered into a
three-year construction contract to build a bridge for a price of
$8,060,000. During 2018, costs of $2,020,000 were incurred with
estimated costs of $4,020,000 yet to be incurred. Billings of
$2,520,000 were sent, and cash collected was $2,270,000.
In 2019, costs incurred were $2,520,000 with remaining costs
estimated to be $3,630,000. 2019 billings were $2,770,000 and
$2,495,000 cash was collected. The project was completed in 2020
after additional costs of...
Contract Information 2018 2019 2020 $ 1,530,000 $ 7,100,000 $ 540,000 Actual construction costs incurred during the year Estimated costs to complete Progress billings made during the year Cash collections during the year 0 7,280,000 4,400,000 3,110,000 460,000 3,900,000 3,110,000 1,030,000 3,110,000 Dulu TUNIC 2018 2019 2020 Cumulative square feet completed 16,800 25,200 42,000 Anglee Builders accepts a contract with Norton Stores to construct a strip mall on Route 3 on January 2, 2018. The builder accepts a fixed fee...
